Ordinary Council Meeting

 Minutes

Wednesday 12 February 2014

Commencing at 7.00pm

Wycheproof Supper Room

367 Broadway, Wycheproof

Paul Younis

Acting Chief Executive Officer

Buloke Shire Council

Buloke Shire Council Ordinary Meeting Minutes                             Wednesday, 12 February 2014

Minutes of the Ordinary Meeting held on Wednesday, 12 February 2014 commencing at 7.00pm in the Wycheproof Supper Room, 367 Broadway, Wycheproof

PRESENT

CHAIRPERSON:

Cr Reid Mather                                Mallee Ward

COUNCILLORS:

Cr Ellen White                                  Mallee Ward

Cr David Pollard                              Lower Avoca Ward

Cr Stuart McLean                            Lower Avoca Ward

Cr Graeme Milne                             Mount Jeffcott Ward

Cr Leo Tellefson                              Mount Jeffcott Ward

Cr Gail Sharp                                   Mount Jeffcott Ward

OFFICERS:

Mr Paul Younis                                Acting Chief Executive Officer

Ms Gaynor Doreian                         Director Corporate and Community Services

Mr Anthony Judd                             Director Works and Technical Services

Mr Bill Keane                                   Manager Community Services

Mr Tom O’Reilly                              Manager Finance

Mr Warren Hemopo                        Manager Reconstruction

AGENDA

1.       COUNCIL prayer AND WELCOME

The Mayor Cr Reid Mather read the Council Prayer and welcomed members of the gallery.

We acknowledge the traditional owners of the land on which we are meeting.   We pay our respects to their Elders and to the Elders from other communities who maybe here today.

2.       RECEIPT OF APOLOGIES

Nil.

3.       CONFIRMATION OF MINUTES OF PREVIOUS MEETING

Motion:

That Council adopt the Minutes of the Ordinary Meeting held on Wednesday, 11 December 2013.

Moved:             Cr Stuart McLean

Seconded:      Cr David Pollard

Carried.

4.       REQUESTS FOR LEAVE OF ABSENCE

Nil.

5.       DECLARATION of PECUNIARY AND conflictS of interest

Cr Sharp declared an interest in Item 7.2.5 on the basis of a family member being employed by the Contractor undertaking the reconstruction works for Contract C06 2011/12.

6....... Procedural Items

6.1            Report of Assembly of Councillors Meetings  5

6.2            Building Permits - Monthly Update  8

6.3            Planning Applications Received - Monthly Update  11

6.4            Planning Applications Approved By Acting Chief Executive Officer  12

6.5            Letters of Congratulations and Recognition of Achievement/Awards  14

7....... General Business

7.1      Policy Reports   16

Nil

7.2      Management Reports   17

7.2.1        Public Holidays Act 1993 - Melbourne Cup Holiday Arrangements  17

7.2.2        Notice Of Intention To Approve Planning Permit 530/13 - Amendment To Planning Permit 488/13 Being For A Wind Energy Facility  24

7.2.3        Contract No. C18 – 2011/12 -Construction of Managers Cottage,  Travellers Rest, Charlton  37

7.2.4        Exercise of Delegation - 11 December 2013 to 12 February 2014  40

7.2.5        Deed of Variation - Contract C06-2011/12  42

7.2.6        Road Management Plan Review   44

7.3      Financial Reports   74

7.3.1        2013-14 Mid Year Budget Review   74

8....... REPORTS FROM COUNCILLORS

8.1      Delegate Reports   84

Nil

8.2      Activity Reports   84

Nil

8.3      Report from the Mayor   84

Nil

9....... OTHER BUSINESS

9.1      Petitions   85

Nil

9.2      Notices of Motion   85

9.2.1  Victoria Police - Community Conversations (Nom No. 32) (Cr McLean)  (CR/13/01)

9.3      Questions from Councillors   85

9.3.1        presentation from gwm water  85

9.4      Questions from the Public   85

Nil

9.5      Any Other Procedural Matter   85

Nil

9.6      Urgent Business   85

Nil

10..... MATTERS THAT MAY EXCLUDE THE PUBLIC

Nil

11..... ANY OTHER BUSINESS

12..... MEETING CLOSE

NEXT MEETING

The next Ordinary Meeting of Council will be held in Wycheproof Supper Room, 367 Broadway, Wycheproof on Wednesday, 12 March 2014 at 7.00pm.

Paul Younis

ACTING CHIEF EXECUTIVE OFFICER

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

6.          Procedural Items

6.1       Report of Assembly of Councillors Meetings

Author’s Title:           Governance Officer

Department:              Office of the CEO                                            File No: GO/05/04

Attachments:

1       ViewRecord of Assembly of Councillor Meeting - 9 December 2013

Motion:

That the Council notes the report of the Assembly of Councillor Meeting held on 9 December 2013.

Moved:             Cr Leo Tellefson

Seconded:      Cr Graeme Milne

Carried.

1.       Key Points/Issues

The Local Government Act 1989 (the Act) provides that a record must be kept of any Meeting of Councillors and Staff deemed to be an Assembly of Councillors Meeting as defined in the Act.

The Act also provides that the record of any Assembly of Councillors is to be reported to the next practicable Council Meeting and recorded in the Minutes.

A record of the Assembly of Councillor Meetings held on 9 December 2013 is attached.

Buloke Shire Council Ordinary Meeting Minutes                                    Wednesday, 12 February 2014

6.1                   Report of Assembly of Councillors Meetings

Attachment 1    Record of Assembly of Councillor Meeting - 9 December 2013

BULOKE SHIRE COUNCIL

RECORD

Assembly of Council Meeting

Date and Time:

9 December 2013

Time:    5.00pm to 8.00pm

Location:

Charlton District Office

Attendees:

Cr Reid Mather – Mayor

Cr Ellen White

Cr David Pollard

Cr Stuart McLean

Cr Leo Tellefson

Cr Gail Sharp

Cr Graeme Milne

Paul Younis – Acting Chief Executive Officer

Bill Ryan – Manager Finance

Anthony Judd – Manager Assets and Infrastructure

Gaynor Doreian – Manager Works and Construction

Bill Keane – Manager Community Services

Jessie Lysaght – Senior Planning Officer

Apologies:

Nil

ITEMS

NO.

TOPIC

1.

Declarations of Conflicts of Interest

1.1

Cr Leo Tellefson (Item 2.1)

On the basis of his membership on the Board of the East Wimmera Health Service

2.

Presentations

2.

2.1

Paula Noble (East Wimmera Health Service)

3.

Items for Discussion

3.1

Council Reports

3.2

2014/2015 Budget Development

3.3

Christmas/New Year Break Service Arrangements

4.

CEO Updates

4.1

Contract CO6 Update

4.2

Fire Notices

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

6.2       Building Permits - Monthly Update

Author’s Title:           Compliance Administration Officer

Department:              Works and Technical Services                     File No: DB/14/02

Attachments:

Nil

Motion:

That the Council note information contained in the report on Building Permits approved under delegation from 1st December 2013 to 31st January 2014.

Moved:             Cr David Pollard

Seconded:      Cr Gail Sharp

Carried.

1.       Executive Summary

This report provides information on Building Permits approved under delegation from 1st December 2013  to 31st January 2014.

2.       List of Building Permits Approved by Council Surveyor

Permit No.

Address

Project Description

Value

Date Approved

20130166

22 Napier Street, DONALD

Other: Fence

$25,000

4/12/2013

20130167

32 Aitken Avenue, DONALD

New Building: Re-erection of storage building

$6,000

4/12/2013

20130169

611 Yeungroon-Woosang Road, YEUNGROON EAST

New Building: Shed-Farm Building

$80,000

9/12/2013

20130171

1-7 George Street, Sea Lake

New Building: Shed

$9,000

16/12/2013

20130173

22-28 Watchem Road, BIRCHIP

New Building: Front Fence

$1,500

20/12/2013

20130174

24 Main Street, CULGOA

New Building: Swimming Pool & Safety Barrier

$3,600

20/12/2013

20120048/3

Boundary Street, BIRCHIP

New Building: O’Connor’s Building  Stage 3 to Install Sign

$750,000

(Total Project, Buildings etc)

20/12/2013

January 2014

20140001

25 Park Street, CULGOA

New Building: Shed

$11,800

14/1/2014

20140002

10 Watchem Road, BIRCHIP

Extension: Veranda

$8,000

14/1/2014

20140005

18 Menzies Street, CHARLTON

Alteration: To Dwelling-Deck

$6,500

15/1/2014

20140008

14 Waugh Street, CHARLTON

Demolish Garage and Construct Shed

$10,000

17/1/2014

20140012

74 Woods Street, DONALD

Alteration: Replace Facade and Verandah to Shop

$43,000

31/1/2014

3.       List of Building Permits Approved by Private Surveyors

Permit No.

Address

Project Description

Value

Date Approved

201300168

2 Main Street, CULGOA

Extension & Alteration of Fire Station

$120,000

22/12/2013

20130170

Pratt Street, CURYO

Demolition of Hall

$22,302

11/12/2013

20130172

1437 Birchip-Wycheproof Road, NARRAPORT

New Building: Motor Room( Fire Station)

$249,370

9/12/2013

January 2014

20140003

161 Jones Street, GLENLOTH

New Building: Fire Station & Motor Room

$492,516

20/12/2013

20140004

10 Watchem Road, BIRCHIP

New Building: Carport

$11,250

10/01/2014

20140006

37 Corack Road, BIRCHIP

New Building: Construction of a Vergola

$28,355

15/5/2013

20140007

Yeungroon Road, YEUNGROON

New Building: Fire Station

$311,250

7/1/2014

20140009

5129 Birchip-Sea Lake Road, SEA LAKE

New Building: Machinery Shed

$227,000

14/1/2014

20140010

21 Armstrong Street, CHARLTON

New Building: Construction of a Verandah

$14,340

20/1/2014

20140011

10 Sherwood Street, BIRCHIP

New Building: Dwelling-Detached

$32,500

23/1/2014

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

6.3       Planning Applications Received - Monthly Update

Author’s Title:           Senior Planner

Department:              Corporate and Community Services            File No: LP/10/09

Attachments:

Nil

Motion:

That the Council note information contained in the report on planning applications under consideration and the status of each of these applications.

Moved:             Cr Graeme Milne

Seconded:      Cr Leo Tellefson

Carried.

1.       Executive Summary

This report advises provides information on planning applications under consideration and the status of each of these applications.

2.       List of Planning Applications

Application No

Applicant

Address

Date Rec

Summary of Proposal

Status

535/14

Acciona

Gap Road, Nine Mile

20/12/2013

Wind Energy Facility and associated works

Notice of Application

536/14

Adrian Cummins & Associates Surveying

27 Golf Links Road, Charlton

13/12/2013

Two Lot Subdivision – Dwelling Excision

Further Info request

537/14

Ferguson Perry Surveying

7 Hammil Street, Donald

06/01/2014

Two Lot Subdivision

Notice of Application

538/14

Country Fire Authority

4679 Donald- Swan Hill Road, Dumosa

20/12/2013

Use and development of an Emergency Services Facility

Referral

539/14

A Borafitrey

28 Camp Street, Watchem

10/01/2013

Buildings and works in Township Zone

Notice of Application

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

6.4       Planning Applications Approved By Acting Chief Executive Officer

Author’s Title:           Governance Officer

Department:              Office of the CEO                                            File No: LP/10/01

Attachments:

Nil

Motion:

That the Council note information contained in the report on planning permits that have been administered by the Planning Officer and approved by the Acting Chief Executive Officer under Council’s delegated authority.

Moved:             Cr Stuart McLean

Seconded:      Cr Gail Sharp

Carried.

1.       Executive Summary

This report advises Council of the planning permits that have been administered by the Planning Officer and approved by the Acting Chief Executive Officer under Council’s delegated authority.

2.       List of Planning Permits

Date

Permit No.

Applicant

Address and Project

13.1.14

510/13

Simon Early on behalf of the CFA
P O Box 701
Mt Waverley  Vic  3419

55 – 63 Railway Avenue, Sea Lake

Pty No:  245 401 904

Development and Use of an Emergency Services Facility

13.1.14

527/13

Peter Clapham
Plans for People

434 Hargreaves Street
Bendigo   3550

73 Best Street, Sea Lake

Pty No:  240 003 504

Building and Works (Verandah)

13.1.14

531/13

Country Fire Authority

270 Yeungroon – Nine Mile Road, Yeungroon

Pty No:  381 913 402

Use and development of Emergency Services Facility

8.1.14

522/13

Price Merrett Consulting on behalf of
P & K Hutcheon
P O Box 1172
Swan Hill   Vic   3585

CA 72A and 72B Parish of Teddywaddy

Pty No:  185 168 004

Known as 4907 St Arnaud-Wycheproof Road, Teddywaddy West 3527

Two Lot Subdivision

Date

Permit No.

Applicant

Address and Project

7.1.14

528/13

K Harberger
Box 6
Donald     Vic   3480

Lot 56  PS  40521

Known as Racecourse Road, Donald

Pty No:  115 400 703

Works to construct a Weighbridge and Weigh Station

8.1.14

534/13

St Josephs School
P O Box 149
Charlton   vic   3525

Lot 2 PS 409705

Known as 25 Watson Street, Charlton

Pty No:  363 011 102

Development of an Outdoor Shelter

4.12.13

533/13

P Shirley
P O Box 22

Culgoa    Vic  3530

Lot 1 TP 170787P Parish of Kaneira

Known as 25 Park Street, Culgoa  3530

Pty No:  254 401 004

Development and Use of a Shed

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

6.5       Letters of Congratulations and Recognition of Achievement/Awards

Author’s Title:           Governance Officer

Department:              Office of the CEO                                            File No: CR/13/01

Attachments:

Nil

Motion:

That the Council acknowledge and congratulate the persons and/or groups mentioned in the report for their achievements.

Moved:             Cr Gail Sharp

Seconded:      Cr Leo Tellefson

Carried.

1.       Executive Summary

This report acknowledges and congratulates community persons and/or groups for their success in being recognised for a significant achievement or for being a recipient of an honourable award.

The report also informs Council of any letters of congratulations or any particular recognition of achievement that Council has received or been awarded in the past month.

2.       Recognition of Achievement Items

Provider

Recipient

Date

Purpose for Recognition

Australian Government

Merridee Hardinge OAM, Altona

(Wife of Former Councillor and Mayor of Hobsons Bay Leigh Hardinge)

26 Jan 2014

The Order of Australia Medal has been for her service to the community of Hobsons Bay.

Buloke Council wishes to recognise this achievement as Merridee and Leigh provided assistance to Buloke community during the difficult times of drought and were vital links in strengthening the Council’s Friendship Alliance.

State Government’s Community Sport and Recreation Awards

Tom Trewin
Wycheproof

Dec 2013

Was one of the last three finalists for the  “Young Volunteer of the Year Award” in the State Government’s Community Sport and Recreation Awards.

This Award recognises Tom for his volunteer work he has undertaken for Junior Cricket in his community, showing exceptional leadership qualities and being held in high regard by his team mates, opponents and administrators.

Wycheproof P-12 College

Christopher Driscoll
Wycheproof

Dec 2013

Awarded the Dux for Wycheproof P-12 College in 2013

Charlton College

Matthew Peverill
Charton

Dec 2013

Awarded the Dux for Charlton College in 2013

Provider

Recipient

Date

Purpose for Recognition

Birchip P-12 College

Harrison Christie
Birchip

Dec 2013

Awarded the Dux for the Birchip P-12 College in 2013

Donald High School

Kate Stuchbery
Donald

Dec 2013

Awarded the Dux for the Donald High School in 2013

Tyrrell College

Zac Martin

Dec 2013

Awarded the Dux for the Tyrrell College in 2013

Transport Union

Luba Grigorovitch, (Hobsons Bay City Councillor)

Nov 2013

First Woman and the youngest person to lead Victoria’s Transport Union at the age of 28.

Buloke Council wishes to recognise this achievement of Ms Grigorovitch, in appreciation and as a thank you to the vital links and Friendship Alliance with your role as a Councillor at Hobsons Bay City Council.

Buloke Shire Council Ordinary Meeting Minutes                             Wednesday, 12 February 2014

 7.         General Business

7.1       Policy Reports

                         Nil

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

7.2       Management Reports

7.2.1    Public Holidays Act 1993 - Melbourne Cup Holiday Arrangements

Author’s Title:           Governance Officer

Department:              Office of the CEO                                            File No: PE/12/01

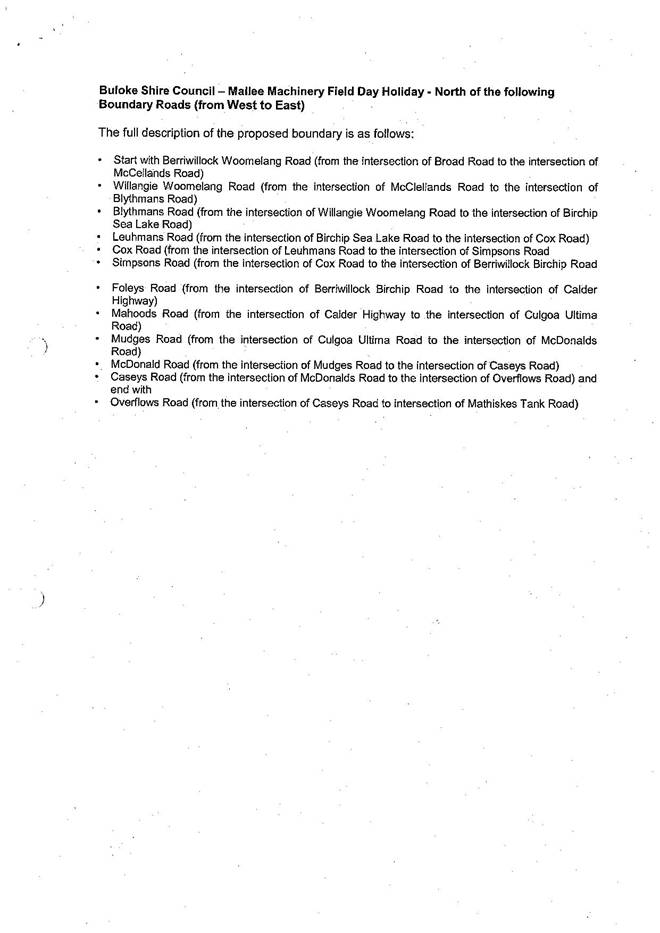

Attachments:

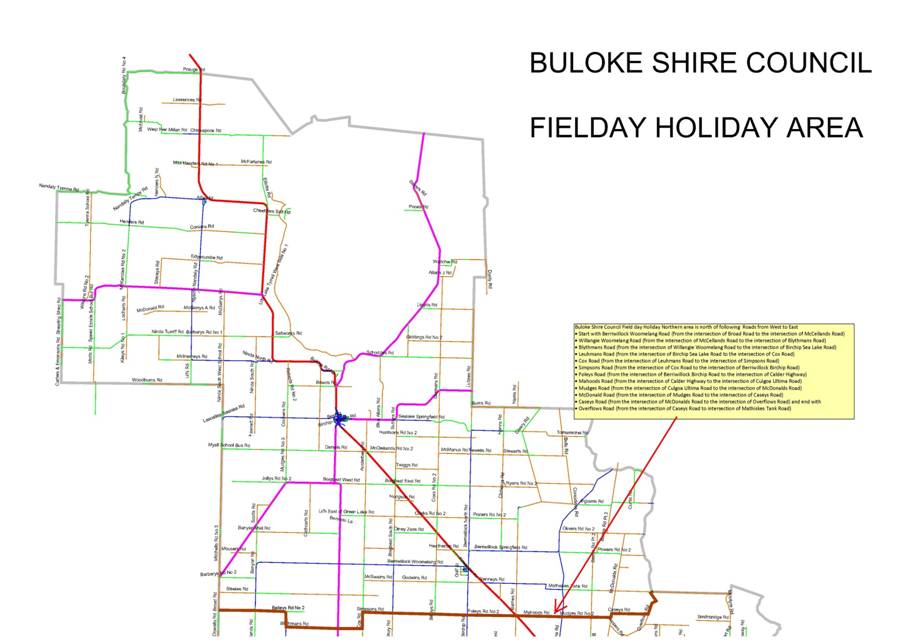

1       ViewMap of Northern Area of Shire - Mallee Machinery Field Day

2       ViewSummary of Northern Area of Shire - Mallee Machinery Field Day

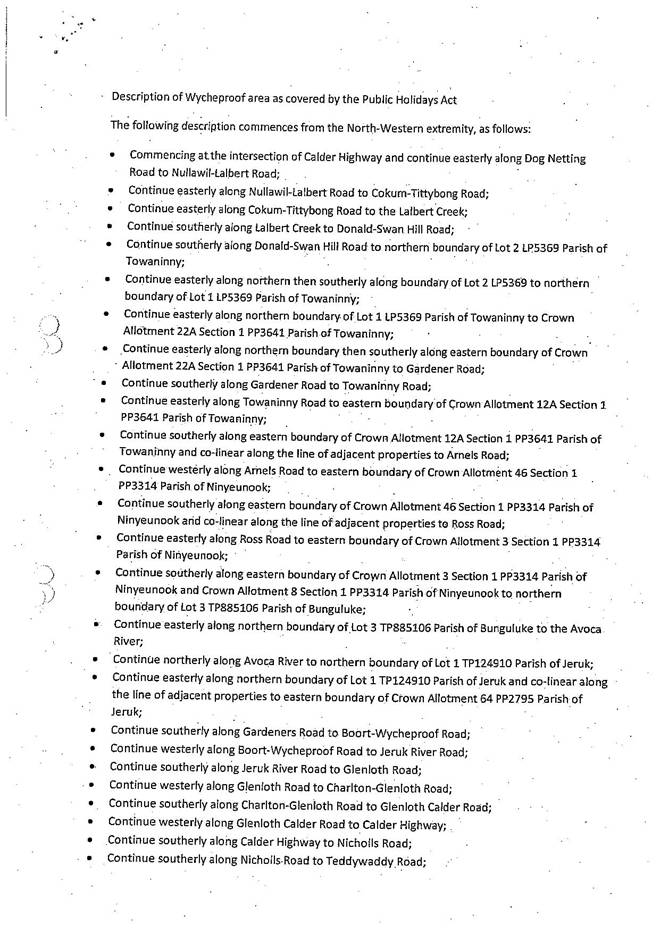

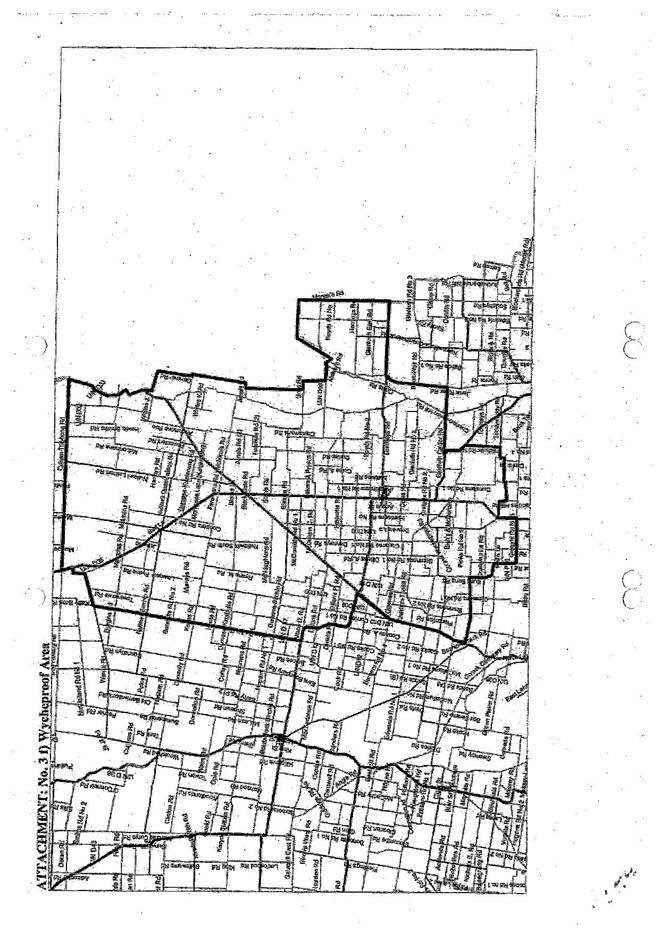

3       ViewMap and Summary of Wycheproof, Nullawil and District - Wycheproof Show Day

Relevance to Council Plan 2009-13

Objective:                            A Buloke community connected and involved in shaping decisions that affect them

Strategy:                              Working with communities and other stakeholders in planning for and making decisions about the future

Priority:                                Celebrate the vitality and resilience of towns and localities across the Shire through facilitation and support for events and community festivals

Motion:

That:

1.       Council nominate 22 October 2014 (Wycheproof Show day) as a substitute full day Public Holiday for Melbourne Cup Day for Wycheproof and District (including Nullawil) in accord with the map attached to this report.

2.       Council nominate 6 August 2014 (the first day of the Mallee Machinery Field Days) as a substitute full day Public Holiday for Melbourne Cup Day for the northern section of the Shire as shown on the map attached to this report (the area being generally known as Berriwillock, Sea Lake, Nandaly and District)

3.       The remainder of the Shire continue to recognise the Melbourne Cup Day as its gazetted full day Public Holiday.

Moved:             Cr Stuart McLean

Seconded:      Cr Graeme Milne

Carried.

1.       Executive Summary

Council has received a request from the Minister for Employment and Trade, seeking advice on a preferred holiday/s it may wish to declare as an alternative local public holiday in lieu of Melbourne Cup Day.

This report proposes changes to the existing Melbourne Cup Day which is consistent with the days proclaimed in previous years.

2.       Discussion

The Public Holidays Act 1993 provides the ability for regional councils, if preferred, to nominate one full day, or two half-day, Public Holidays in one or more parts of their municipal districts as a substitute Public Holiday in lieu of Melbourne Cup Day.

In accordance to the Act, Council is required to submit its request for alternative arrangements to the Minister for Employment and Trade, at least 90 days prior to Melbourne Cup Day.

The request will need to specify:

·    The area or areas in the municipality subject to the proposed substitute arrangements;

·    The nominated day or two half days in lieu of Melbourne Cup day; and

·    The reasons for the request.

The Act also provides for a Council to nominate a half day on Melbourne Cup Day itself as one of its two half-day public holidays, if that is its preference.

Those Council’s, or areas of a municipality, not subject to a substitution arrangement will continue to automatically receive the Melbourne Cup Day Public Holiday on the first Tuesday in November 2014.

Arrangements for Melbourne Cup Day across the Shire in 2013 were as follows:

·    Donald and District – Melbourne Cup Day Public Holiday

·    Charlton and District – Melbourne Cup Day Public Holiday

·    Birchip and District – Melbourne Cup Day Public Holiday

·    Wycheproof and District (including Nullawil) – Wycheproof Show Day as a full day Public Holiday in lieu of Melbourne Cup Day

·    Sea Lake and District (including Berriwillock and Nandaly) – Mallee Machinery Field Day as a full day Public Holiday in lieu of Melbourne Cup Day.

Advance Sea Lake Inc. has submitted to Council its request to make application to the Minister to substitute Wednesday 6 August 2014 as a Public Holiday for Sea Lake and District in lieu of Melbourne Cup Day.

Advance Sea Lake Inc advised in their application they have consulted with schools, businesses, service clubs and the general community, and confirmed their support for this application.

Following receipt of the request from Advance Sea Lake Inc contact has been made with the Nandaly Progress Association and Berriwillock Community Development Group to confirm their support for this substitute public holiday.   Both organisations support this proposal.

The area proposed for the alternative Public Holiday for Mallee Machinery Field Day is to remain as per last year’s arrangements.   (Description and map of the proposed area is attached).

Wycheproof Agricultural and Pastoral Society have indicated they wish to have the same arrangements as undertaken in 2013, to apply in 2014. The alternative Public Holiday for Melbourne Cup Day for Wycheproof and District will be Wednesday 22 October 2014.   A description and map of the respective area relative to this holiday is attached.

Following Council consideration of this matter, an advertisement will be placed in the local papers advising the broader community of Council’s decision, and seeking any objections to the matter.

3.       Financial Implications

There are no financial implications for Council from this report.

Council will continue to observe Melbourne Cup Day as the designated Public Holiday in accordance to its operational activities to be adopted in its Budget 2014/2015.

4.       Community Consultation

The community has been consulted during consideration of this matter through direct approach to local representative associations.

Following Council consideration of this matter, an advertisement will be placed in the local papers advising the broader community of Council’s decision, and seeking any objections to the adopted proposal.

5.       Internal Consultation

There has been no internal consultation on this matter.

6.       Legislative / Policy Implications

This report is addressed in accordance with the provisions of the Public Holidays Act 1993.

7.       Environmental Sustainability

Nil.

8.       Conflict of Interest Considerations

There are no known Conflict of Interest considerations from this report.

9.       Conclusion

The Public Holidays Act 1993 provides for regional and rural Councils to apply to the Minister to nominate substitute Public Holidays for Melbourne Cup Day.

It is recommended that Council continue to support both the Wycheproof Show Day and Mallee Machinery Field Days for an alternative Public Holiday for their respective districts as specified in the report.

Buloke Shire Council Ordinary Meeting Minutes                                                                        Wednesday, 12 February 2014

7.2.1                 Public Holidays Act 1993 - Melbourne Cup Holiday Arrangements

Attachment 1    Map of Northern Area of Shire - Mallee Machinery Field Day

Buloke Shire Council Ordinary Meeting Minutes                                                    Wednesday, 12 February 2014

7.2.1                 Public Holidays Act 1993 - Melbourne Cup Holiday Arrangements

Attachment 2    Summary of Northern Area of Shire - Mallee Machinery Field Day

Buloke Shire Council Ordinary Meeting Minutes                                                    Wednesday, 12 February 2014

7.2.1                 Public Holidays Act 1993 - Melbourne Cup Holiday Arrangements

Attachment 3    Map and Summary of Wycheproof, Nullawil and District - Wycheproof Show Day

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

7.2.2    Notice Of Intention To Approve Planning Permit 530/13 - Amendment To Planning Permit 488/13 Being For A Wind Energy Facility

Author’s Title:           Senior Planner

Department:              Corporate and Community Services            File No: LP/09/01

Attachments:

1       ViewPlanning Permit conditions for 530/13

Relevance to Council Plan 2013 - 2017

Objective:                            A local economy in which new business is actively encouraged; investment welcomed; employment created; business skills developed and local networks are supported.

Strategy:                              Encouraging innovative energy solutions for future energy generation.

Priority:                                Actively promoting the Shire as a location for energy production from wind, solar and other clean energy technologies and advocate to other levels of Government for investment in infrastructure to ensure this can occur.

Motion:

That:

1.       That Notice of Intention to approve planning permit 530/13 for amendments to the planning permit 488/13 for a wind energy facility, subject to conditions as attached, be given to the applicant and submitters.

Moved:             Cr Leo Tellefson

Seconded:      Cr Gail Sharp

Carried.

1.       Executive Summary

A planning permit application to amend planning permit 488/13 was received by Council   on the 18th October 2014. The amendment was for:

·    An additional wind turbine to be added to the existing five that were approved;

·    A substation to be added to the development;

·    Several planning permit conditions to be rewritten for clarification purposes; and

·    The batching plant, office and lay-down areas to become permanent on the site.

As per the original application, all Notice of Application was repeated and several external bodies including Powercor, Vic Roads, Department of Environment and Primary Industry and the CFA were re advised. Notice of Application was also repeated in the North Central News and to all surrounding land holders within a five kilometre radius. Two objections were received and consultation was undertaken with submitters who wished to be involved in further discussions. The planning permit was assessed against a number of Planning and Environment Act 1987 decision guidelines and it is recommended that Notice of Intention to approve the planning permit be given.

2.       Discussion

The relevant Buloke Planning Scheme sections were dealt with in the original report to Council and need not be repeated. The factors in this application are the increase in turbines and permanent fixtures on the site and whether they will have a greater amenity impact than the original application.

Whilst there are small increases in the noise impact assessment levels and increased visual impact by an additional turbine, it is considered that these are negligible if the project is assessed in its entirety. The permanency of several works on the site is also considered minimal given the project scale and their only being on the site for the life of the project. The substation is required to assist with regulating the input of power into the powerlines and is there to insure a consistent flow without overloading Powercor infrastructure.

3.       Financial Implications

There are still financial implications for three scenarios; if the Notice of Intention to            Approve is challenged through the Victoria Civil and Administrative Tribunal, Buloke

Shire Council will be required to provide legal support for the position taken in the            planning permit process and outcome. If the planning permit is ultimately approved by the           end of the Notice period or VCAT, then enforcement of the conditions will add additional           workload to the Planning staff at Buloke Shire Council. Thirdly, once the project is            developed and operational a set fee as determined by the Electricity regulator will be           provided to Council annually from the energy producing facility

4.       Community Consultation

Community consultation was undertaken by the Council as per Section 52 of the Planning

and Environment Act 1987 which included notice in the locally circulating newspaper         (North Central News) and mail notification to neighbouring properties within a 5km radius
of the project.

5.       Internal Consultation

Additional internal consultation to planning permit 488/13 was undertaken with Council’s Technical Services Officer regarding the traffic management criteria and also Council’s Environmental Officer regarding the vegetation aspects of the planning permit application. Advice was received by both officers and has been incorporated into the planning permit conditions.

6.       Legislative / Policy Implications

There are many statutory requirements on wind energy facilities; this includes sections of          the Planning and Environment Act, the Buloke Planning Scheme, Victoria Planning

         Provisions and the Policy and Planning Guidelines for Development of Wind Energy

         Facilities in Victoria 2009.

7.       Environmental Sustainability

There are two environmental considerations for this planning permit, from the development perspective all environmental sustainability issues need to be addressed through environmental management plans and from a use perspective the alternative energy sector is proposed to increase overall environmental sustainability.

8.       Conflict of Interest Considerations

          No conflict of interest considerations are reasonably known.

9.       Conclusion

It is recommended that Notice of Intention to approve planning permit application 488/13 be given.

The application meets the decision guidelines of the Buloke Planning Scheme including the State Planning Policy Framework and relevant particular provision. The wind energy facility application has met the numerous reports and specifications required under the Act, scheme and relevant policies and guidelines. The objections received by Council as a result of the application were considered by planning staff and it is felt that many of the concerns were able to be addressed in the planning permit conditions. The ongoing enforcement of the conditions should a planning permit be issued following the Notice of intention period will require close monitoring once the use and development commence and complete construction.

Buloke Shire Council Ordinary Meeting Minutes                                    Wednesday, 12 February 2014

7.2.2                 Notice Of Intention To Approve Planning Permit 530/13 - Amendment To Planning Permit 488/13 Being For A Wind Energy Facility

Attachment 1    Planning Permit conditions for 530/13

Attachment 1

It is recommended that Notice of Intention to approve planning permit 530/13 be given subject to the following planning permit conditions:

1. The use and development as shown on the endorsed development plans or other plans to the satisfaction of the Responsible Authority must not be altered or modified in any way without the written consent of the Responsible Authority save that the micro siting of wind generators will be regarded as generally in accordance with the endorsed plans if the Responsible Authority is satisfied that it will not give rise to a material change to assessed landscape, vegetation, cultural, visual, shadow or noise impacts and:

o (a) if a turbine requires micro siting then;

§ (ii) Houses #4, 5, 6, 8 should not have any turbine brought any closer than shown in the application plans.

§ (iii) Turbine 1 is not permitted to move closer to Mt Gowar Reserve

LIGHTING

2. No permanent external lighting of infrastructure associated with the wind energy facility, other than low level security lighting where appropriate, may be installed or operated without further consent from the Responsible Authority.

SPECIFICATIONS

3. The wind energy facility must be constructed in accordance with the following specifications, which must not be changed without the prior written consent of the Responsible Authority:

o (a) A total of not more than 6 wind turbine generators;

o (b) The turbine model that is selected must be to the satisfaction of the Responsible Authority.

o (c) The wind turbines shown on the plan shall have an overall height of not more than 150 metres

o (d) The rotor on each wind generator must comprise of three blades;

o (e) The tower, nacelle and rotor blades must be off-white or another colour satisfactory to the Responsible Authority, and must be of a non-reflective finish;

o (f) The colours and finishes of all substations and ancillary equipment must be specified to the satisfaction of the Responsible Authority so as to ensure that impact on landscape values is minimised;

o (g) All new electricity cabling associated with the collector network within the wind energy facility generator cluster must be placed under the ground unless exception is required at the request of Powercor.

o (h) The access tracks within the site are to be sited to ensure minimum impacts on the site, including impacts on erosion and overland flows and, where appropriate, having regard to the farming attributes of the land.

o (i) A permanent wind monitoring mast may remain on site.

o (i) The concrete batching plant, if required, become a permanent part of the development.
o (i) The lay down area designated in the development plans become a permanent part of the development.

4. A control room and site office, car parking for staff vehicles, amenities including bathroom and kitchen facilities, warehouse to accommodate equipment, an outside storage area and a substation are to be permanent features of the development.  A site map showing this will be provided to the Responsible Authority at the same time lodgement for the building permit application is carried out.

5. The construction of the wind energy facility must not be staged without the prior written consent of the Responsible Authority.

TRAFFIC MANAGEMENT – VICROADS CONDITIONS

6. Before the commencement of any works and before the engagement of any haulage contractors, a Traffic Management Plan to the satisfaction of the Responsible Authority, in consultation with Vic Roads, in its capacity as road authority under the Road Management Act 2004 for local and arterial (public) roads used to transport material to/from and within the vicinity of the wind energy facility. The traffic management plan must be submitted to and approved by the Responsible Authority being Buloke Shire and Vic Roads. When approved, the plan will be endorsed by the Buloke Shire Council and Vic Roads.

The traffic management plan, without limiting the generality of the plan, must include:

o (a) Prior to commencement of works, an existing conditions survey of public roads and associated infrastructure that may be used in connection with the wind energy facility (for access, delivery of material, pre-construction or construction purposes) including details of the suitability of the proponent’s use, design, condition and construction standard of the relevant public roads and bridges.

o (b) The designation of appropriate construction and transport vehicle routes to the wind energy facility for pre construction, construction and transport.

o (c) The designation of all vehicle access points to the wind energy facility from surrounding roads, including main road access points to local access roads.

o (d) The designation of vehicle access points which must be designed and located to ensure safe sight distances, turning movements, and avoid potential through traffic conflicts.

o (e) engineering plans and reporting demonstrating whether, and if so, how truck movements to and from the site can be safely accommodated within a road reserve. Mitigation measures are to be developed by the proponent and agreed to by Vicroads and the Buloke Shire Council for all hazards including, but not limited to; oversize and over-mass haulage, traffic management, removal of roadside vegetation, reduction in speed limits, alteration to any road furniture or intersection, emergency management, and risk management.

o (f) recommendations regarding the need for road, bridge and intersection upgrades to accommodate any additional traffic, oversize or over-mass loads, or site access requirements (whether temporary or ongoing). Where upgrades are required, the traffic management plan must include:

i) Detailed engineering plans showing the required works,

ii) The timing of when works are to be undertaken.

o A program of regular inspections to be carried out during the construction of the wind energy facility to identify maintenance works necessary as a result of construction traffic.

o Works identified during surveys in condition a above must be completed expeditiously to the satisfaction of Vicroads and the Buloke Shire Council.

o The designation of operating hours and speed limits for trucks on routes accessing the site which:

i) Avoid school bus routes and school bus times where relevant,

ii) Provide for resident safety

o Measures to be taken to manage traffic impacts associated with the construction and ongoing operation of the wind energy facility on the traffic volumes and flows on surrounding roads.

o A program to rehabilitate existing public roads and associated infrastructure to a safe and usable condition to a standard no less then what is required to support the proposed use or the condition identified by the surveys required under Condition 1a above, whichever is the greater:

i) During the construction period.

ii) At the conclusion of the construction of the wind energy facility,

iii) First two years during the operation of the wind energy facility.

o Demonstration that all necessary permits have been obtained for the removal of vegetation within the road reserve for the purpose of providing access to the site for material.

o That the proponent is responsible for any damage caused to construction vehicles or other vehicles in the event that the safe and usable quality of any public road and associated infrastructure is degraded or compromised as a result of the development, and that Vicroads or the Buloke Shire Council will not accept liability for any such damage.

7. By no later that three (3) months after the date of completion of the wind energy facility, a post construction conditions surveys of public roads that have been used in connection with the wind energy facility (for access, preconstruction or construction purposes) must be submitted to the satisfaction of Vicroads and the Buloke Shire Council. The report must include details of any dilapidation or damage to the roads and a program of rehabilitation in accordance with the requirements of the approved Traffic Management Plan.

8. The traffic management and road upgrade and maintenance works indentified in the endorsed traffic management plan must be carried out in accordance with the endorsed traffic management plan to the satisfaction of Vicroads and the Buloke Shire Council.

9. The provision of a security bond prior to the commencement of works equal to the estimated cost of the rehabilitation/replacement of any infrastructure identified as being at risk to the satisfaction of Vicroads and the Buloke Shire Council.

10. Al works, reporting and the provisions of Vicroads road escort vehicles and personnel are to be at not cost to Vicroads or the Buloke Shire Council, including but not limited to: all additional route survey work, together with all associated Vicroads bridge assessments for the over dimensional and over-madd vehicles and their loads, and all additional traffic management resources and equipment such as variable message signs.

11. The use and development must be carried out in accordance with the endorsed Traffic Management Plan and the cost of any works including maintenance are to be at the expense of the permit holder.

ENVIRONMENTAL AND CULTURAL MANAGEMENT PLAN

       12. . The environmental management plan received with the application will be endorsed

       by the Responsible Authority. The Environmental Management Plan includes:

§ (i)The identification of all construction and operational processes that could potentially lead to water contamination.

§ (ii) The identification of appropriate storage, construction and operational methods to control any identified contamination risks.

§ (iii) The identification of waste re-use, recycling and disposal procedures.

§ (iv) A management plan for the concrete batching plant to prevent pollution of local waterways particularly from wash water and waste concrete materials.

§ (v) Appropriate sanitary facilities for construction and maintenance staff.

§ (iii) The identification of waste re-use, recycling and disposal procedures.

§ (iv) A management plan for the concrete batching plant to prevent pollution of local waterways particularly from wash water and waste concrete materials.

§ (v) Appropriate sanitary facilities for construction and maintenance staff.

The plan must contain procedures for the removal of works buildings and staging area on completion of construction of the project and for the return of the site to its former condition. This information is currently contained in the main report page 179 and will need to be included in the Environmental Management Plan.

(b) A sediment, erosion and water quality management plan. This plan must be referred to and approved by relevant water supply authorities, as described in Clause 66.02-10 of the Planning Scheme, who may consult with and take into account the views of the relevant Catchment Management Authority and other authorities.

The sediment and erosion plan must include:

· (i) Procedures to ensure that silt from batters, cut-off drains, table drains and road works is retained on the works site during and after the construction stage of the project. All land disturbances must be confined to a minimum practical working area and to the vicinity of the identified works areas. Soil to be removed must be stockpiled and separate soil horizons must be retained in separate stockpiles and not mixed. Stockpiles must be located away from drainage lines.

· (ii) The installation of geotextile silt fences (with sedimentation basins where appropriate) on all drainage lines from the site which are likely to receive run-off from disturbed areas.

· (iii) Procedures to contain any contaminated or turbid run-off during and after construction of the wind energy facility.

· (iv) Procedures to suppress dust arising from construction-related activities. Appropriate measures may include water spraying of roads and stockpiles, stabilising surfaces, temporary screening and/or wind fences, modifying construction activities during periods of heightened winds and revegetating exposed areas as soon as practicable.

· (v) Procedures to ensure that steep batters are treated in accordance with Environmental Protection Authority recommendations detailed in the ‘Construction Techniques for Sediment Pollution Control’ No 275, May 1991.

· (vi) Criteria for the siting of any temporary concrete batching plant associated with the development of the wind energy facility and the procedure for its removal and reinstatement of the site once its use finishes. The establishment and operation of any temporary concrete batching plant must be in accordance with the Environment Protection Authority’s Environmental Guidelines for the Concrete Batching Industry, Publication No. 628.

· (vii) Procedures for waste water and discharge management.

· (viii) A process for overland flow management to prevent the concentration and diversion of waters off site or erosion prone slopes.

· (ix) Pollution management measures for management of stored and stockpiled materials including waste materials, litter and any other potential source of water pollution.

· (x) Incorporation of control measures outlined in EPA publication No. 480 Environmental Guidelines for Major Construction Sites.

· (xi) Siting of concrete batching plant and any on-site wastewater and disposal and disposal treatment fields at least 100 metres from any watercourse.

· (xii) Appropriate capacity and an agreed program for annual inspection and regular maintenance of any on-site wastewater management system constructed to service staff, contractors or visitors.

· (xiii) Immediate remediation of localised erosion, with a specified response time.

· (xiv) Method identified under condition 9(a)(iv) to protect groundwater aquifiers.

(c) Procedures for the storage of any fuels, lubricants or waste oil to be stored in bunded areas with contingency measures to ensure that any chemical or oil spills are contained on-site and cleaned up in accordance with the Environment Protection Authority’s requirements are to be provided to the responsible authority for endorsement within three months of project construction commencement.

(d) The Emergency Management Plan will be endorsed by both the Country Fire Authority and Buloke Shire Council as part of the planning permit and will not be altered without the written consent of both parties.

(e) While no Aboriginal sites were recorded during the survey there is low-moderate potential for very diffuse stone artefact scatters and scarred trees to be present within the study area. To ensure there is no accidental damage to potential sites it is required that:

· (i) Contractors are provided with information on Aboriginal site identification and what to do in the event that suspected Aboriginal site material is uncovered. This ‘induction’ should be undertaken by Aboriginal Affairs Victoria or Framlingham Aboriginal Trust, prior to works commencing.

· (ii) Monitoring of construction activities associated with the Coonnoer Bridge wind farm is undertaken by Aboriginal representatives. Works which require monitoring are initial topsoil stripping in all areas where ground disturbing activities are taking place. Aboriginal monitors will primarily be monitoring the works to determine whether unregistered sites are uncovered during construction. An archaeologist should be on call if Aboriginal monitors detect cultural heritage material. The archaeologist can assist the Aboriginal representatives to record any cultural material uncovered. They will also be able to provide management advice and if necessary, make arrangements for Consent to Disturb.

· (iii) Procedures for the management of potential Aboriginal site values for the project, should be outlined in a Cultural Heritage Management Plan, prepared in consultation with the Registered Aboriginal Party and Aboriginal Affairs Victoria.

· (iv) If suspected Aboriginal cultural heritage material is located in the study area contact: Aboriginal Affairs Victoria (1300 888 544) and Framlingham Aboriginal Trust (03 5567 1003). If suspected non-Aboriginal cultural heritage material is located in the study area contact Heritage Victoria (9637 9475).

(f) A native vegetation protocol. This protocol is to be established in consultation with the Department of Environment and Primary Industry– North West Region. The protocol is to clarify the circumstances in which a further planning permit will be sought for native vegetation removal. The protocol is to also include the Net Gain actions that will be undertaken if native vegetation disturbance or removal cannot be avoided for the construction, operation and decommissioning stages of the project.

(g) The pest animal management will be undertaken as per section 4.5 and the works schedule of the Environmental Management Plan. The procedure provides that follow-up pest animal control is undertaken on all areas disturbed by the wind energy facility construction works for a period of two years following the completion of the wind energy facility.
(h) Procedures to prevent the spread of weeds and pathogens from earth moving equipment and associated machinery including the cleaning of all plant and equipment before transport to the site and the use of road making material comprising clean fill that is free of weeds.
(i) A program of early identification and eradication of weeds in disturbed areas and follow-up weed control for a minimum period of two years following the completion of the works.
(j) An environmental monitoring plan.
(k) A training program including a site induction program relating to the range of issues addressed by the Environmental Management Plan.
(l) A program for reporting, including a register of environmental incidents, non-conformances, complaints and corrective actions.

13. The Environmental Management Plan is to be reviewed every five years to reflect operational experience and changes in environmental management standards and techniques and is to be submitted to the Responsible Authority for re-endorsement.

14. The use and development must be carried out in accordance with the endorsed Environmental Management Plan.

NOISE

15. The operation of the wind energy facility must comply with the New Zealand Standard ‘Acoustics – The Assessment and Measurement of Wind Farm Noise’ (NZ 6808:2010) (the ‘New Zealand Standard’), in relation to any dwelling existing at the date of approval of this document to the satisfaction of the Responsible Authority. In determining compliance with the New Zealand Standard, the following apply:

o (a) The sound level from the wind energy facility, when measured outdoors within 10 metres of a dwelling at any relevant nominated wind speed, should not exceed the background level (L95) by more than 5dBA or a level of 40dBA L95, whichever is the greater.

o (b) When sound has a special audible characteristic, the measured sound level of the source shall have a 5dBA penalty applied.

o (c) Compliance at night must be separately assessed with regard to night time data. For these purposes the night is defined as 10.00pm to 7.00am. For sleep protection purposes, a breach of the standard set out at Condition 12(a), for 10% of the night, amounts to a breach of the condition.

16. Before the use commences, details of a noise complaint, evaluation and response process must be submitted to and approved by the Responsible Authority to address any alleged breaches of Condition 12. This evaluation process should include, but not be limited to the following components:

o (a) A noise complaint telephone service;

o (b) Details of validity requirements for noise complaints (that is: date, time, noise description and weather conditions at the receptor);

o (c) Response protocol to valid noise complaints including, but not limited to:

§ (i) determination of the meteorological circumstances at the time of the breach and the operational status of the turbine(s) at that time;

§ (ii) noise optimisation of the relevant turbine(s) under the same meteorological circumstances as occurred at the time of the breach;

§ (iii) in the event of further breaches the selective shut down of the relevant wind turbine(s) in the same meteorological circumstances; and

§ (iv) where under the same meteorological conditions subsequent confirmed noise breaches occur, the decommissioning of the relevant turbine(s).

o (d) A register of complaints, responses and rectifications which may be inspected by the Responsible Authority;

o (e) Provision for review of the complaint and evaluation process, including review of the process six months after commencement of the operation of the wind energy facility.

o (f) Upon receiving a written request by the Responsible Authority, the operator must within 30 days of that request supply an assessment of noise levels emitted by the wind energy facility by a qualified acoustic consultant with readings taken at times and locations specified by the Responsible Authority. Recommendations to address any non-compliance with NZS6808 must be included in the report and, on agreement by the Responsible Authority, measures to address non-compliance must be immediately implemented to the satisfaction of the Responsible Authority.

17. An independent post-construction noise monitoring program must be commissioned by the proponent within two months from the commissioning of the last generator and continue for 24 months all to the satisfaction of the Responsible Authority. The program must be carried out in accordance with the New Zealand standard as varied by Conditions 12 (a), (b) and (c) above. The permit holder must pay the reasonable costs of the monitoring program.

18. An independent report summarising the results of the monitoring program, and the data collected, and indicating compliance or non compliance with the New Zealand Standard, must be forwarded to the Responsible Authority within 45 days quarterly for the monitoring period. The results must be written in plain English and formatted for reading by lay people.

19. The Responsible Authority must make a copy of the report referred to in Condition 18 and any data available as soon as practicable during office hours for any person to inspect free of charge.

20. For the purposes of this permit, the carrying out of preliminary investigative works is not considered to amount to commencement of the Development.

21. The associated infrastructure and activities related to the wind energy facility on the nominated site must comply with the Environment Protection Authority’s Interim Guidelines for Control of Noise for Industry in Rural Victoria NIRV: 1411 at all times to the satisfaction of the Responsible Authority.

BLADE SHADOW FLICKER

22. No existing dwelling will experience over 12 hours blade shadow flicker per annum.

COMPLAINTS HANDELING

23. Before the use commences the complaint, evaluation and response process outlined at figure 3-20 of the main report and approved by the Responsible Authority will be initially used to assess any breach of Condition 19.

TELECOMMUNICATION AND TELEVISION RECEPTION AND INTERFERENCE

24. If complaints are made regarding the television and radio reception at the residences identified as number 1 to 16 within 5km, or regarding the GPS system, a post-construction qualitative survey must be carried out. If the qualitative survey establishes any detrimental increase in interference to reception or transmission, measures must be taken to mitigate the interference to return the affected reception or transmission to pre-construction quality at the cost of the wind energy facility operator and to the satisfaction of the Responsible Authority.

SECURITY

23. All site and wind generator access points and electrical equipment must be locked and made inaccessible to the general public to the satisfaction of the Responsible Authority. Public safety warning signs must be located on all towers and all spare parts and other equipment and materials associated with the wind energy facility must be located in screened, locked storage areas that are inaccessible to the public to the satisfaction of the Responsible Authority.

EMERGENCY ARRANGEMENTS

24. Before the use starts, the operator of the wind energy facility must conduct a familiarisation visit and explanation of emergency procedures for the Country Fire Authority (CFA) and the State Emergency Service (SES), and thereafter must continue to provide such sessions for the CFA and SES on a regular basis and/or as required by those agencies.

RE-POWERING

25. No wind turbine or any component of a wind turbine, approved in the plans endorsed under Condition 2 of this permit, shall be replaced in a manner that would materially affect the location, size, external visual appearance, sound power characteristics, generator capacity, or electrical output of the turbine, without further written consent from the Responsible Authority.

AVIATION

26. The applicant will provide appropriate conspicuous markings to the existing wind monitoring tower.

27. The wind turbines to be identified on the relevant aeronautical charts once final locations are selected.

DECOMMISSIONING

28. The wind energy facility operator must, without delay, notify the Responsible Authority in writing as soon as all or any wind energy facility generators have permanently ceased to generate electricity, whether due to planned removal, faults or otherwise. Within 12 months of that date, the wind energy facility operator, or in the absence of the operator, the owner of the land in which the relevant generator is located must undertake the following to the satisfaction of the Responsible Authority:

o (a) Remove all non-operational or downed equipment;

o (b) Remove and clean up any residual spills;

o (c) Clean up and restore all storage, construction and other area associated with use, development and decommissioning of the wind energy facility, including provision of soil cover and grassing over the wind generator site;

o (d) Restore all access roads and any other area affected by the project closure or decommissioning, if not otherwise useful to the on-going management of the land;

o (e) Prepare and submit a post-decommissioning traffic management plan to the satisfaction of the Responsible Authority and, when approved by the Responsible Authority, implement that plan; and

o (f) Prepare and submit a post-decommissioning revegetation management plan to the satisfaction of the Responsible Authority and, when approved by the Responsible Authority, implement that plan.

AGREEMENTS

29. Agreements required under Conditions 12 shall be retained by the wind energy facility operator for inspection by the Responsible Authority and any prospective purchaser of a property containing wind turbines.

DEPARTMENT OF ENVIRONMENT AND PRIMARY INDUSTRY

Offsets

1. In order to offset the removal of native vegetation as identified in Table 3 of the report’ Coonooer Bridge Wind Farm Flora and Fauna Assessment’ (February 2013) approved for removal as part of this permit, the applicant must provide offsets to achieve targets identified in Table 22 of the report, plus an additional 5% or an alternative to the satisfaction of the responsible authority.

To provide the required offset, within 12 months of the vegetation removal the applicant or owner must either:

a) Provide to the responsible authority, an Allocated Credit Extraction issued by the Department of Environment and Primary Industries Native Vegetation Credit Register, which satisfies the required offset, or

b) Commence management of an offset in accordance with an offset plan to the satisfaction of the Department of Environment and Primary Industries and endorsed by the responsible authority. The offset plan must be prepared to the satisfaction of and approved by the responsible authority.

The offset plan must include details of how the targets outlined in table 22 of the report ‘Coonooer Bridge Wind Farm Flora and Fauna Assessment’ (February 2013) are to be achieved including:

i. Methods of permanent protection for established offsets;

ii. Location of the offsets including details of Bioregion;

iii. Type of offsets to be provided;

iv. details of any revegetation including number of trees, shrubs and other plants; species mix; density; methods of interim protection and management until vegetation is established and a schedule of works;

v. details of any existing vegetation to be retained including methods of managing and restoring the vegetation and a schedule of works;

vi. the person(s) responsible for implementing and monitoring the offset plan;

vii. the timeline for the implementation of the offset plan.

When approved the offset plan will be endorsed and form part of this permit.

2. Within twelve months of the native vegetation removal:

· The offset site must be permanently protected to the satisfaction of the responsible authority such as through an encumbrance on the title, and

· A copy of the endorsed offset plan and protection mechanism(e.g. title showing encumbrance) must be lodged with the Department of Environment and Primary Industries.

3. At two, five and ten years after the responsible authorities’ approval of the offset plan, the applicant must provide notification to the Department of Environment and Primary Industries of the management actions undertaken towards the management of the offset as specified in the offset plan. Vegetation removal and the provision of offsets must accord with the enclosed plan.

Plans

4. Prior to the commencement of works the following documents are to be prepared to the satisfaction of the Department of Environment and Primary Industries:

· A Construction Environmental Management Plan,

· A plan for fauna monitoring protocols post construction,

· A Wildlife Management Plan, including details of animal welfare handling and release protocols and capture and release technique for follow dependent fauna.

Three copies of the documents must be submitted, approved and endorsed by the responsible authority; when endorsed the documents will form part of the permit.

Management of Remnant Vegetation

5. Prior to the commencement of works, the boundaries of all vegetation to be removed and retained must be clearly marked on the ground with tape or temporary fencing to the satisfaction of the responsible authority.

6. To prevent damage to remaining grassland vegetation there must be no temporary or permanent storage of any materials, vehicles or equipment within areas of native vegetation identified to be retained in accordance with the endorsed plans. All storage sites must be restricted to existing cleared areas close to existing roads and tracks, and must not adversely impact upon native vegetation, including the root zones of existing trees. Such sites must not be located on or near erodible surfaces, surface water runoff areas or areas infested with weeds.

Vehicle Hygiene

7. All vehicles, earth-moving equipment and other machinery must be cleaned of soil and plant material before entering and leaving the site to prevent the spread of weeds and pathogens.

Adjoining Crown Land

8. All turbines must be a minimum distance of 220 metres from the Mount Gower Scenic Reserve.

9. No associated infrastructure such as access tracks and powerlines are to impact on the Crown land.

(Notes)

· Third part offsets may be available from Bushbroker Over the Counter program. Please email bushbroker@dse.vic.gov.au or visit www.dse.vic.gov.au/nativevegetation for further information.

· The adjoining Crown land is not to be used for access, storage of materials or rubbish. Any private use of Crown land requires consent and/or licensing from the Department of Environment and Primary Industries.

· Any proposal to develop the road reserve will require the applicant to purchase the road. The sale of the road is dependant on the outcome of a Public Land assessment and consultation with adjoining owners and Buloke Shire Council.

· It is noted that one of the roads is currently held under licence by an adjoining landowner.

LANDSCAPE

30. Before the development starts, a program of landscape mitigation works is to be offered at no initial cost to the owners any house within 5km of a wind turbine. As part of this program an Off-site Landscaping Plan must be prepared and submitted, to the satisfaction of the Responsible Authority. When approved, the plan will be endorsed by the Responsible Authority. The Off-site Landscaping Plan may be submitted in stages, to the satisfaction of the Responsible Authority (such that not all stages are completed before the development starts) and must include:

o (a) A provision for the owners of any other dwellings within 5km of a wind turbine to have the opportunity to accept the offer of visual screen planting at any time up to until 12 months after the commissioning of the last wind turbine generator;

o (b) The process by which the owners of any other dwellings within 5km of a wind turbine will be informed of this offer and the process by which it can be accepted;

o (c) Details of planting or other treatments that will be used to reduce the visual impact of the wind turbines at the dwellings of participating landowners;

o (d) Details of the species proposed to be used for the landscaping including details of height and size of species at maturity;

o (e) A timetable for the implementation plan.

31. Before the development starts, a Landscape Plan for the intended permanent buildings on site to the satisfaction of the Responsible Authority must be submitted to and approved by the Responsible Authority. It must be prepared by a suitably qualified person and show details of landscaping of around compound to minimise the visual impact of the facility from public roads and nearby dwellings. When approved, the landscape plan will be endorsed and will then form part of the permit.

43. The development must be carried out in accordance with the endorsed Off-site Landscaping Plan and Landscape Plan for the intended permanent buildings on site, to the satisfaction of the Responsible Authority.

ADVERTISING SIGNS

32. Details of any signage proposed to be displayed as part of the wind farm must be approved by the Responsible Authority and limited to:

o (a) (b) One logo or company identification for the wind facility operator or wind generator manufacturer displayed on each wind turbine.

o (c) Signs required specifically in relation to site safety issues.

EXPIRY

33.. Notwithstanding other provisions of these conditions, this permit will expire if one of the following circumstances applies:

o (a) The development is not started within three years of the date of this permit.

o (b) The development is not completed and the use is not started within five years of the date of this permit.

The Responsible Authority may extend the periods referred to if a request is made in writing before the permit expires or within three months afterwards.

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

7.2.3    Contract No. C18 – 2011/12 -Construction of Managers Cottage,
Travellers Rest, Charlton

Author’s Title:           Director Works and Technical Services

Department:              Works and Technical Services                     File No: CP/21/14

Attachments:

1       Attachment - Confidential Schedule - printed in separate document

Relevance to Council Plan 2013 - 2017

Objective:                            A local economy in which new business is actively encouraged; investment welcomed; employment created; business skills developed and local networks are supported.

Strategy:                              Development of infrastructure and services that take advantage of the major transport routes through the Shire, including experiential visitor opportunities.

Priority:                                Work with communities located on the Calder Highway and Sunraysia Highway to provide a range of commercial, public health, accommodation and recreational facilities to travellers on these two major road networks.

Motion:

That:

1.       Council notes and declares the Confidential Attachment to this Report for Contract No C18 – 2011/12 – Construction of Manager’s Cottage, Traveller’s Rest, Charlton, pursuant to Section 77 (2) of the Local Government Act 1989, on the grounds that it relates to Contractual Matters as described in Section 89 (2) of the Local Government Act 1989.

2.       Council award the Contract (Contract No. C18 – 2011/12 for Construction of the Managers Cottage at Travellers Rest, Charlton to Neatline Homes Pty Ltd for the tendered lump sum price of $169,700.00 (excluding GST); and

3.       Delegate authority to the Chief Executive Officer to approve payments to the contractor for undertaking works associated with the Contract.

Moved:             Cr David Pollard

Seconded:      Cr Stuart McLean

Carried.

1.       Executive Summary

This report provides a summary of the Tender Evaluation Panel Report for the Construction of the Managers Cottage at Travellers Rest in Charlton.

2.       Discussion

In 2010/11, on behalf of the Charlton Travellers Rest Committee of Management, Council secured external funding through the Helen McPherson Smith Trust fund and the Local Government Infrastructure Program for the construction of the Managers Cottage/Information Centre at Travellers Rest, Charlton.

Council worked with the Charlton Travellers Rest Committee of Management in developing plans for the proposed building and called for Tenders in October 2013.

At the time of opening tenders, one submission was received, which was significantly over the available total project budget.

The tender evaluation panel, having satisfied the tendering requirements of the Local Government Act and Council’s Procurement Policy and through agreement with the Acting Chief Executive Officer, commenced negotiated with building companies specialising in construction of transportable homes.

Following preliminary evaluation of the available floorplans and pricing options from three separate firms, the panel requested a formal quotation from Neatline Homes Pty Ltd.

Neatline Homes Pty Ltd provided a submission, including a quotation and floorplan that was both within budget and fits the original intent and scope of the project. The quotation for the construction of the Managers Cottage/Information Centre is $169,700 exclusive GST.

In evaluating the tender against the total project budget, Council have made an allowance of $75,000 (excluding GST) additional to the lump sum price to cover connection of services, stormwater run-off, relocation of rainwater tank, professional fees and contingencies.

The tender evaluation panel are satisfied that:

·    The submission of Neatline Homes Pty Ltd suits the original intent of the project brief and functionality of the proposed Charlton Travellers Rest Manager’s Cottage.

·    The quotation of Neatline Homes Pty Ltd, along with the additional costs ($75,000) is within the set total project budget.

·    Neatline Homes Pty Ltd has the expertise and capability required to undertake the work.

·    Neatline Homes Pty Ltd can undertake the works of the contract within acceptable timeframes (completion 23rd May 2014).

·    The submission from Neatline Homes Pty Ltd provides a good value for money outcome for Council and the community.

3.       Financial Implications

The total project cost, which includes connection of services costs and contingencies outside of the lump sum tender, is estimated to be $244,700 exclusive GST.

This is within the total project budget of $245,000 exclusive GST.

Council have previously received $172,000 of external funding for the project, with the balance to be provided by the committee and local fundraising. Any cost overruns will be by the responsibility of the committee.

4.       Community Consultation

A significant amount of consultation has been held with the Charlton Travellers Rest Committee of Management in the development and design of this project. Two members of the committee were involved on the Tender Evaluation Panel.

5.       Internal Consultation

Staff within the Works and Technical Services Directorate along  with the Senior Planning Officer, Building Surveyor and Acting Chief Executive Officer have met to discuss this project and tender evaluation panel report.

6.       Legislative / Policy Implications

This tender was conducted in accordance with requirements of the Local Government Act and Council’s Tender Procedures.

7.       Environmental Sustainability

Where possible, environmentally sustainable design features have been incorporated into the building. This includes solar hot water systems, claiming and re-using stormwater

8.       Conflict of Interest Considerations

Nil

9.       Conclusion

The Confidential Attachment outlines the estimated value of these tenders.

It is recommended that Council award the tender for the Construction of the Managers Cottage, at Travellers Rest, Charlton to Neatline Homes Pty Ltd for the lump sum of $169,700 (excluding GST).

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

7.2.4    Exercise of Delegation - 11 December 2013 to 12 February 2014

Author’s Title:           Acting Chief Executive Officer

Department:              Office of the CEO                                            File No: PE/02/01

Attachments:

Nil

Relevance to Council Plan 2013 - 2017

Objective:                            An organisation that is responsibly governed with a strong emphasis on sustainable financial and risk management

Strategy:                              Ensuring Council is well governed and its finances and risks are managed  sustainably and responsibly

Priority:                                Maintain good governance processes for Council and Special Committee meetings and communicate decisions to the community

Motion:

That the Council note the report.

Moved:             Cr Gail Sharp

Seconded:      Cr Ellen White

Carried.

1.       Executive Summary

This report is for Council to provide Council with an update of the use of delegated authority by the Chief Executive Officer in awarding contracts for the period 11 December 2013 to 12 February 2014.

2.       Discussion

At the December 2013 Ordinary Meeting, Council delegated certain powers and functions under Section 98(1) of the Local Government Act 1989 to the Acting CEO to award time-critical contracts.

Under this delegation, the Acting CEO has approved a Tender Evaluation Panel report recommending awarding Contract No. C15 – 2013/14 – Construction of the Donald Family Services to RTM Constructions Pty Ltd for the tendered lump sum price of $1,709,301(excluding GST), which includes a provisional sum for signage and fit out of $50,320 excluding GST. This contract is now let and preliminary and planning works have begun.

Contract No. C17 2013/14 – Redevelopment of Synthetic Lawn Bowling Green, for Birchip Bowls has not yet been awarded due to ongoing negotiation with tenderers.

3.       Financial Implications

This tender is within the Council budget and within the estimates provided by quantity surveyors. The project will be completed over the 13/14 and 14/15 financial years.

4.       Community Consultation

The projects have been publicly tendered in accordance with council’s procurement policy.

5.       Internal Consultation

Nil

6.       Legislative / Policy Implications

Whilst the value of the tendered sum exceed the current authority delegated to the Chief Executive Officer, Council authorised delegations to the Acting Chief Executive Officer in accordance with the Local Government Act 1989, Sect 98(1) to award this contract.

7.       Environmental Sustainability

Nil

8.       Conflict of Interest Considerations

Nil

9.       Conclusion

It is recommended that Council note the report.

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

7.2.5    Deed of Variation - Contract C06-2011/12

Author’s Title:           Acting Chief Executive Officer

Department:              Office of the CEO                                            File No: C6/03/01

Attachments:

1       Confidential Attachment - Deed of Variation - Contract C06 2011/2012 - printed in separate document

Relevance to Council Plan 2013 - 2017

Objective:                            A Shire where roads, drains, public spaces, community facilities, parks and other essential infrastructure are fit for purpose, well maintained and contribute to the well-being of the community.

Strategy:                              Improving local road and transport networks to facilitate safe and efficient  transport movement within and across the Shire.

Priority:                                Keep local roads maintained to a high standard as specified in Council’s Road Management Plan.

Cr Sharp declared an interest in Item 7.2.5 on the basis of a family member being employed by the Contractor undertaking the reconstruction works for Contract C06 2011/12.

Cr Sharp left the Council Chamber at 7.20pm before the discussion of this Item.

Motion:

That:

1.       Council notes and declares Confidential Attachment to the Report Item 7.2.5, Deed of Variation – Contract C06-2011/12, pursuant to Section 77(2) of the Local Government Act 1989, on the grounds that it relates to Contractual Matters as described in Section 89(2) of the Local Government Act 1989.

2.       Council authorise the Chief Executive Officer to sign a Deed of Variation to Contract C06-2011/12 generally in accordance with the Confidential Attachment to the report.

Moved:             Cr Leo Tellefson

Seconded:      Cr Stuart McLean

Carried.

1.       Executive Summary

This report is for council to consider a Deed of Variation to Contract C06-2011/12, to meet the Natural Disaster Relief and Recovery Funds (NDRRF) guidelines.

2.       Discussion

Natural Disaster Financial Assistance has been provided by the Victorian State Government in accordance with Commonwealth-State Natural Disaster Relief and Recovery Arrangements for Buloke Shire to fund the recovery works for flood events experienced by the community.

Council currently have a contract with Bitu-Mill (Vic.) Pty Ltd to deliver a majority of these works, specifically for the reconstruction of flood and storm damaged roads, bridges, culverts, floodways and appurtenant works throughout Buloke Shire. The Contract is for a two year period to January 2015.

Under the Natural Disaster Funding Agreement, all expenditure associated with the recovery works must occur within a period of less than two years after the end of the financial year that the flood event occurred.  For Buloke, this period ended on 30th June 2013, Buloke have been granted an extension of this period to 30th June 2014.  The Department of Finance has advised that no further extension of time can be granted.

In order to complete the works by the 30th June 2014 an agreement needs to be developed between Bitu-Mill and Council to accelerate the works.  Councils legal advice is that this agreement is best formalised by way of a Deed of Variation to the existing Contract.

The Deed of Variation (attached) has been the subject of negotiation between the parties and essentially provides for the contact works to be completed by the 30th June 2014 and that the scope of works to be amended to ensure compliance with the NDRRF guidelines.

3.       Financial Implications

The proposed Deed of Variation ensures consistency with the NDRRF guidelines so that all works conducted under the contract will be fully funded.

4.       Community Consultation

Nil

5.       Internal Consultation

Nil

6.       Legislative / Policy Implications

The Department of Finance and Local Government Victoria have been advised of the proposed Deed of Variation and have advised that the payments made in accordance with the Deed will be able to be claimed under the NDRRF.

7.       Environmental Sustainability

Nil

8.       Conflict of Interest Considerations

Nil

9.       Conclusion

The proposed Deed of Variation to Contract C06 will put in place variations to the existing contract with Bitu-Mill to meet the NDRRF guidelines.  The Deed has been prepared in consultation with the Department of Finance and Local Government Victoria and has been developed on the advice of Council legal representatives.

Cr Sharp returned to the Council Chamber at 7.22pm before the discussion of Item 7.2.6.

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

7.2.6    Road Management Plan Review

Author’s Title:           Director Works and Technical Services

Department:              Works and Technical Services                     File No: RO/15/08

Attachments:

1       ViewDraft Road Management Plan - Version 3.0

2       ViewRoad Management Plan Maps

Relevance to Council Plan 2013 - 2017

Objective:                            A Shire where roads, drains, public spaces, community facilities, parks and other essential infrastructure are fit for purpose, well maintained and contribute to the well-being of the community.

Strategy:                              Improving local road and transport networks to facilitate safe and efficient  transport movement within and across the Shire.

Priority:                                Keep local roads maintained to a high standard as specified in Council’s Road Management Plan.

Motion:

That the Council :

1.       Endorse the Draft Road Management Plan (Version 3.0) to be released for public consultation.

2.       Give notice of its intention to make amendments to Council’s Road Management Plan and invite submissions in the Government Gazette and in the Buloke Times, North Central News and Sea Lake Times Ensign in accordance with Section 54 of the Road Management Act 2004.

3.       Make copies of the Draft Road Management Plan and associated maps available on Council’s website and at each of the Council’s District Offices.

4.       Prepare a Consultation Plan to guide community consultation on the Road Management Plan.

5.       Receive a further report following the consultation period, updating Council on the submissions received, and formally adopt the Plan.

Moved:             Cr David Pollard

Seconded:      Cr Ellen White

Carried.

1.       Executive Summary

This report updates Council on the progress of the amending the Road Management Plan and seeks endorsement to release the draft plan for public consultation.

2.       Discussion

A Road Management Plan is a statutory plan under the Road Management Act 2004 that sets out the maintenance regime for management of the municipal road network for Buloke Shire.  It establishes the management system for Council to inspect, maintain and repair its public roads based on policy and operational objectives having regard to available resources.

The purpose of this Road Management Plan is to:

·    Detail the management systems for the road management functions under the control of Buloke Shire Council,

·    Set the relevant standards in relation to the discharge of duties in the performance of those road management functions within the approved budget,

·    Ensure the provision of a safe and efficient road network for use by road users and the community.

In reviewing the plan, a classification of roads based on a functional hierarchy rather than the current condition based system (i.e. sealed, gravel, earth) is proposed.

A functional classification system enables each road to be critically assessed based on destination and purpose, with agreed criteria to determine whether the road system is meeting the needs of the road users.

In developing the road classification system the following guiding principles have been used:

·    Classification system is linked with, and consistent to the Austroads National Functional Road Classification system;

·    Traffic volumes, vehicle type, existing road structure, abutting property use, future demand etc, assist in determining appropriate classification; and

·    Access to abutting properties;

·    Direct linkage with other roads in the network, including arterial roads;

·    Transportation and bus routes;

·    Identifiable origin and destination function served;

·    Links within areas of the municipality, such as agricultural, community and commercial

·    The existing width of a road or whether it is sealed is not necessarily criteria that influence a classification.

The revised plan now proposes that each road be classified into a Link (e.g.. Birchip-Corack Road), Collector (e.g. Seven Mile Road), Access (e.g. roads servicing residential properties) or Limited Access (e.g. road servicing rural paddocks) road and identified the standard Council desires to achieve for that class of road. In considering this re-classification, the hierarchy maintains the current Council Policy to provide all weather access roads to an occupied residence.

The road hierarchy approach to the classification of roads will have an impact on the level of service attributed to some roads.  Minor roads are classed as those roads that do not provide a primary access to an occupied residence.  These roads are generally maintained to an earth road standard.  The new classification system proposed will result in an additional 45km of sealed roads and 610km of gravel roads being maintained to an earth road standard rather than the current sealed or gravel road standard.

This represents an annual reduction of approximately $1.56million on the required renewal of these assets.   This saving has been calculated based on completing sealed road rehabilitation every 60 years at $275,000 per kilometre, sealed road surface re-seal every 15 years at $20,000 per kilometre and gravel road re-sheet every 15 years at $32,000 per kilometre.

Council have also completed a functional re-classification of its footpath network based on Primary Access (high traffic footpaths such as commercial areas and school zones) and Secondary Access (lower traffic/residential areas).

The move to a functional hierarchy has also brought about changes to the type and frequency of pro-active condition inspections, intervention levels and the standard for renewal. These changes vary dependent on the classification level of a road or footpath.

Under the Road Management Act 2004, Council must publically advertise the proposed change to the plan for 28 days. It is recommended that the Council endorse the draft plan for consultation and receive a further report at the April 2014 Ordinary Meeting of Council following the public consultation period.

3.       Financial Implications

There are short-term financial savings in the implementation of the Draft Road Management Plan, however the major benefit of the plan is that it offers a sustainable long term plan of managing our road assets. The long-term financial savings associated with the proposed functional hierarchy of our asset network will be fully realised through the subsequent review and implementation of the Road Asset Management Plan.

4.       Community Consultation

The recommendations of this report sets out the proposed consultation program, including provision of advertisements in local papers and the Government Gazette.

5.       Internal Consultation

A staff working party has been developed in mid-2013 to do a complete review of the Road Management Plan and the Road Hierarchy. This working party will continue to work on the implementation and ongoing reviews of the plan.

6.       Legislative / Policy Implications

The Road Management Act 2004 sets out the requirement and procedures for making a Road Management Plan. The contents of the plan and the recommendations for public consultation are in line with this Act.

The Plan reflects the purpose and objective of Council as specified under Sections 6 and 7 of the Local Government Act 1989.

This Road Management Plan sets the key policy framework of how Council manages its road, footpaths and related assets. This Plan, combined with Council’s Road Asset Management Plan, sets the service levels of the Buloke Shire road network.

7.       Environmental Sustainability

Nil.

8.       Conflict of Interest Considerations

Nil.

9.       Conclusion

The Draft Road Management Plan will give Council an increased strategic and sustainable approach to managing and maintaining our extremely large and important road network. The plan will be less prescriptive than previous versions and allow Council to plan and prioritise work based on condition and class of a particular road.

The revised classification system recognises the changing function and use of roads over time and will deliver to council a reduction of approximately $1.56mill on annual renewal expenditure liability.  This will assist in improving councils long term financial sustainability.

It is recommended that the Council endorse the Draft Road Management Plan and arrange for advertisements for public consultation and submissions in line with Section 54 of the Road Management Act 2004.

Buloke Shire Council Ordinary Meeting Minutes                                    Wednesday, 12 February 2014

7.2.6                 Road Management Plan Review

Attachment 1    Draft Road Management Plan - Version 3.0

BULOKE SHIRE COUNCIL

Draft Road Management Plan

2013

(Version 3.0)

Table of Contents

1.     Introduction. 3

2.     Purpose of the Plan. 3

3.     Legislative Basis for the Plan. 3

4.     Roads for which the Plan Applies. 4

5.     Management System... 4

6.     Asset Standards. 5

7.     Classification System... 5

7.1        Road Classification. 6

7.2        Footpath Classification. 7

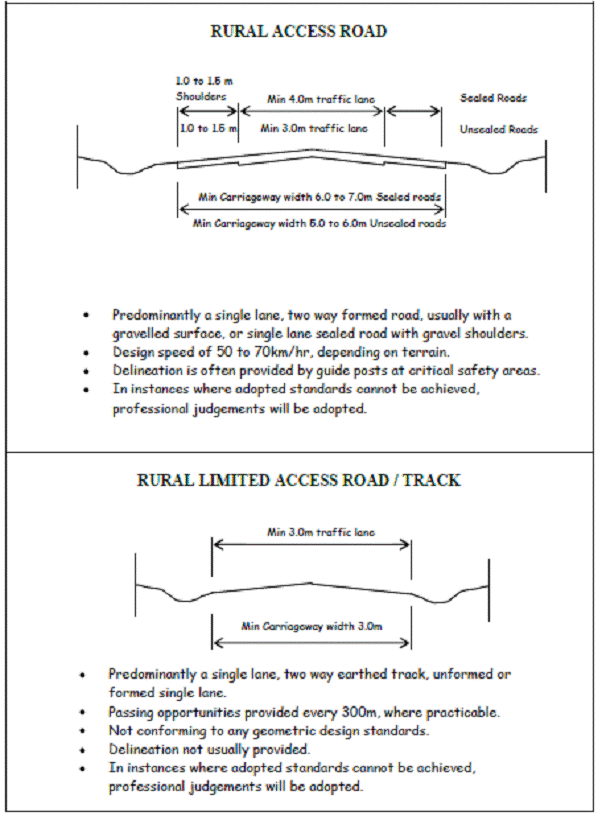

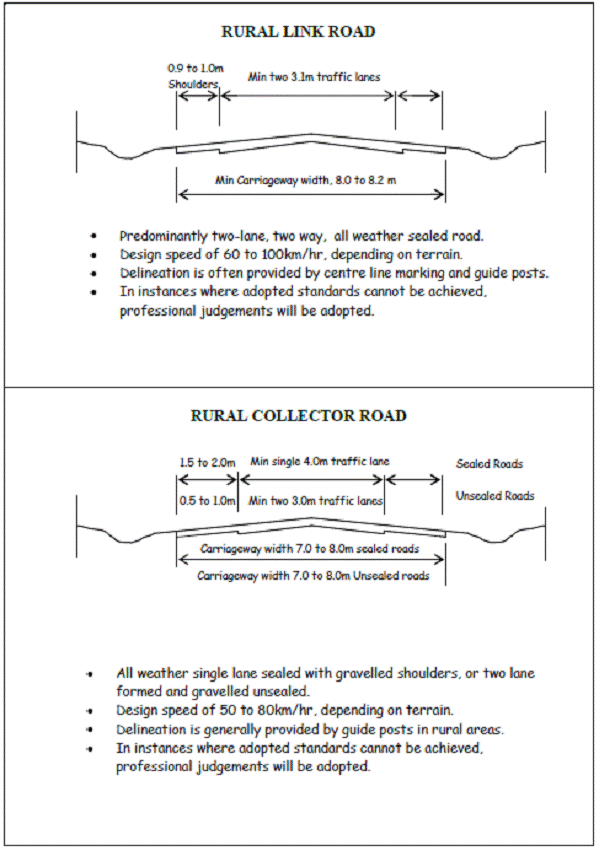

8.     Standards for Upgrading and Renewal of Road Assets. 7

9.     Maintenance Standards. 7

10.   Monitoring System and Response. 8

11.   Force Majeure. 9

12.   Off-Road Paths. 9

APPENDIX A – ASSET MANAGEMENT SYSTEM... 10

APPENDIX B – STANDARDS FOR UPGRADING AND RENEWAL OF ROAD ASSETS.. 11

APPENDIX C – DESCRIPTION OF HAZARD AND HAZARD RESPONSE.. 13

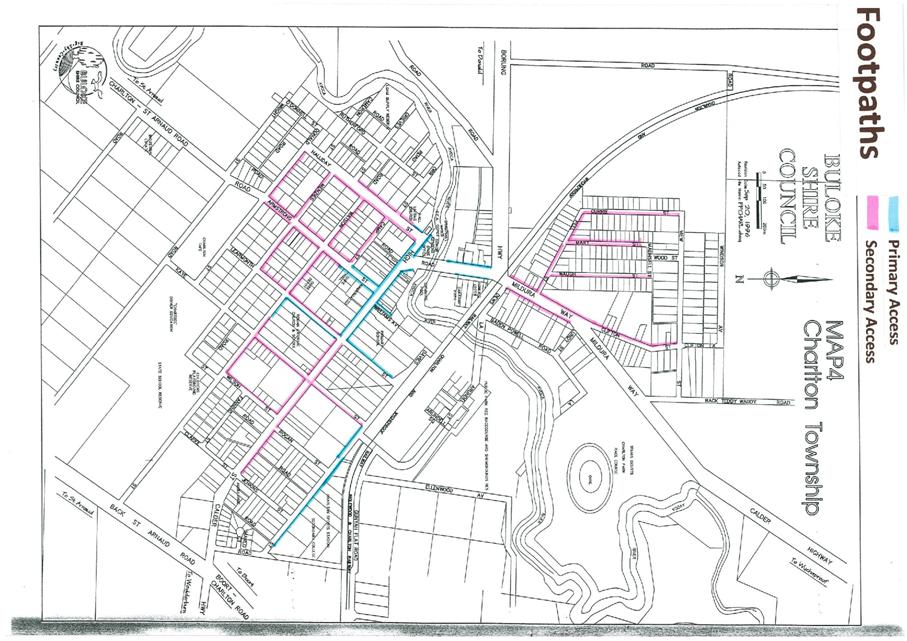

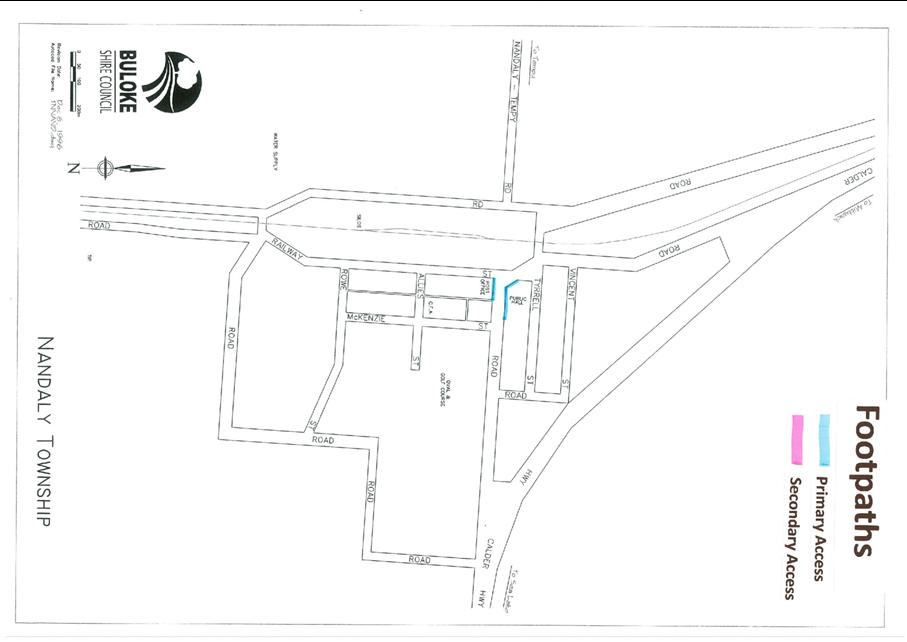

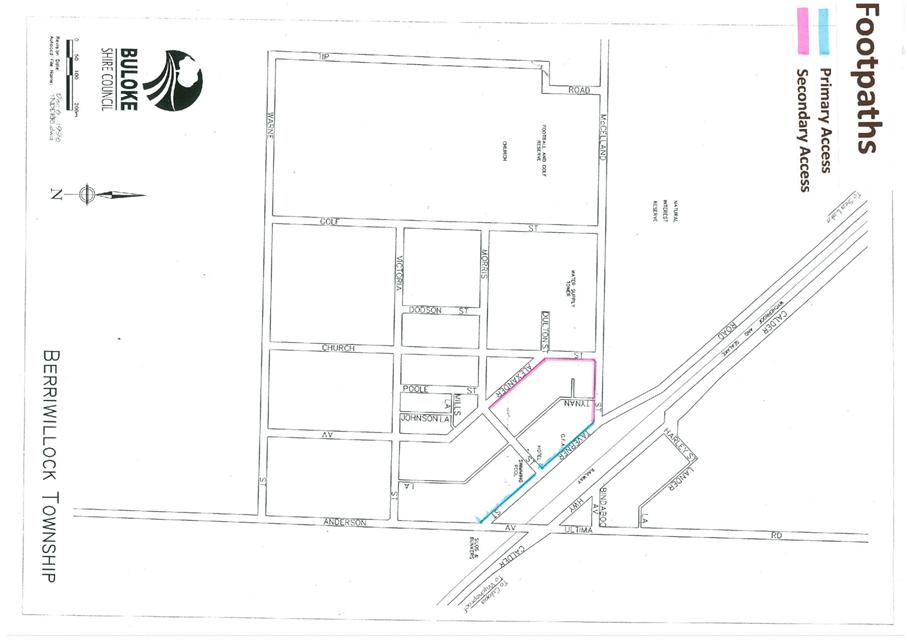

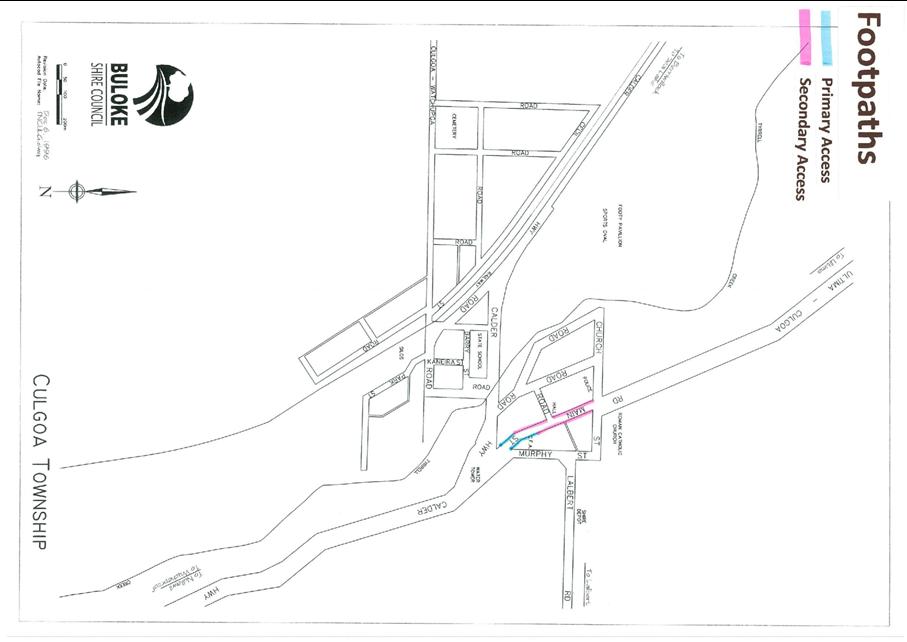

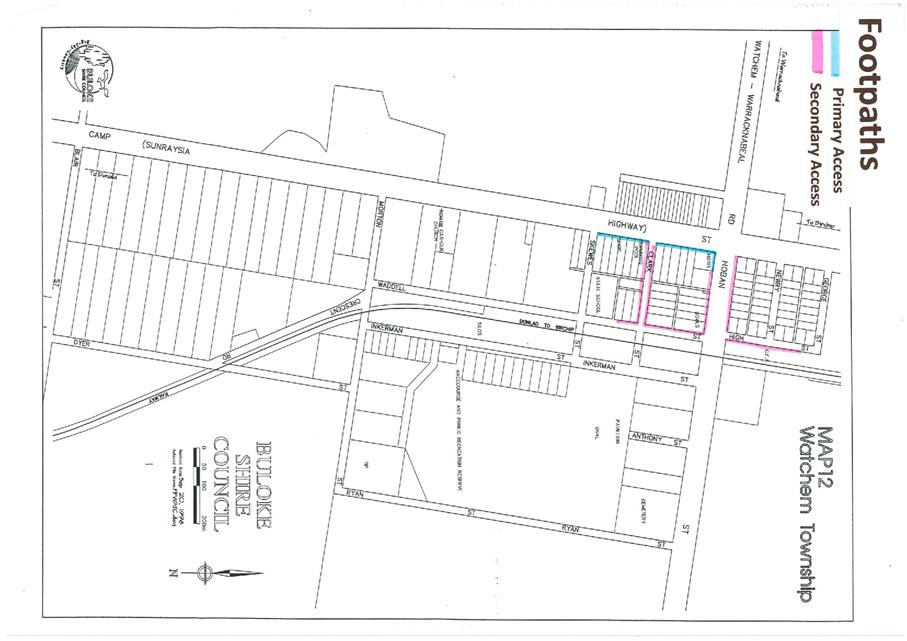

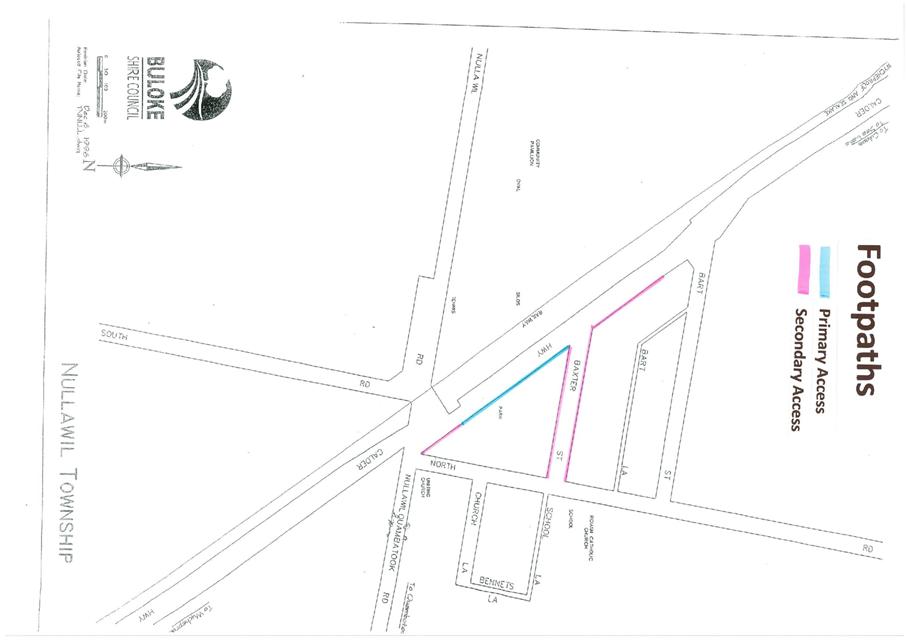

APPENDIX D – ROAD AND FOOTPATH HIERARCHY MAPS.. 15

Buloke Shire Council Ordinary Meeting                                                Wednesday, 12 February 2014

7.2.6                 Road Management Plan Review

Attachment 1    Draft Road Management Plan - Version 3.0

1.        Introduction

The Buloke Shire Council (Council) is committed to ensuring that accessible, quality services and facilities are provided to our community.

The development of the Road Management Plan compliments the Council’s Council Plan by addressing specific elements of the maintenance and management of the road network, as well as the legislative responsibilities under the Road Management Act 2004.

2.        Purpose of the Plan

The purpose of this Road Management Plan is to:

·    Detail the management systems for the road management functions under the control of Buloke Shire Council,

·    Set the relevant standards in relation to the discharge of duties in the performance of those road management functions,

·    Ensure the provision of a safe and efficient road network for use by road users and the community.

3.        Legislative Basis for the Plan

This Road Management Plan is prepared in accordance with, Division 5 of the Road Management Act 2004 (the Act), and in accordance with Ministerial Code of Practice – Road Management Plans.

The Plan reflects the purpose and objective of Council as specified under Sections 6 and 7 of the Local Government Act 1989.

In developing the relevant standards detailed in this Plan, Council has had regard to the following Best Value Principals specified under Section 208B of the Local Government Act 1989.

All services must be:

·    Measured against quality and cost standards;

·    Responsive to the needs of its community;

·    Accessible to those members of the community for whom the service is intended;

·    Subject to continuous improvement;

·    Linked to a program of regular community consultation; and

·    Report regularly to the community.

4.        Roads for which the Plan Applies

This Plan applies to all roads and pathways for which Council is the coordinating road authority in accordance with Sections 36 and 37 of the Act. The roads are listed in Council’s Register of Public Roads.

The register provides a list of the roads for which Council is the Responsible Authority, and includes (where applicable) the following;

·    Road name

·    Locality

·    Date Road became a Public Road

·    Start and end description

·    Length

·    Road Classification

·    Footpath Classification

·    Surface Type

·    Ancillary Areas

·    Demarcation Responsibility

Council has determined that those roads and footpaths on the Register of Public Roads are those roads that are considered to be reasonably required for public use. The Register of Public Roads has been adopted by Council and is amended from time to time as required. The Register of Public Roads is available for inspection at Council offices.

Council’s responsibility for the operation of arterial roads is detailed in the Code of Practice- Operational Responsibility for Declared Freeways and Arterial Roads.

Where applicable, the details of agreements between the Council and other road authorities, made pursuant to Section 15 of the Act, are also included in the Register of Public Roads.

This Plan does not apply to any driveway or pathway providing access from private property to a public road.

5.        Management System

Council’s Road Management Plan has been developed within an overall planning framework, which guides Council in identifying community needs and aspirations.

Information flow and the decision making process is complex, with the Council Plan, Financial Plan and Annual Budget, providing the framework to a range of supporting Plans and Strategies.

Council’s Road Asset Management Plan is a key document in detailing the strategic guidelines and identifying maintenance, renewal and upgrade improvements for the road network. The Road Asset Management Plan takes a lifecycle approach to the management of our road network and identifies the elements necessary for the long term sustainability of our asset. It provides details of the particular actions and resources required to manage the road system.

The management system that Council uses for its road management functions can be summarised in the diagram provided in Schedule A. The flowchart outlines the process for determining asset standards, allocating resources and prioritising works.

6.        Asset Standards

Council’s road management standards have been developed within the overall planning framework, taking into account community expectations, industry standards, relevant risk factors and available resources.

Maintenance standards and asset performance targets will vary across the road network in line with relevant risk factors such as the nature and volume of traffic using the road, operating speed, the susceptibility of assets to deterioration, the cost effectiveness of repairs and the competing priorities for funding.

For the purposes of the Road Management Plan standards have been defined in terms of:

·    The Road and Footpath Classification;

·    Standards for Expansion Upgrade and Renewal;

·    Standards for Maintenance; and

·    Condition Monitoring and Response.

7.        Classification System

A new classification system has been developed for both roadways and footpaths, to ensure that appropriate management, engineering standards and planning practices are applied to a road based on its function.

The new functional based classification system also enables more efficient use of resources by allocating funding to those roads that are of higher priority and the costs are better justified.

7.1     Road Classification

In developing the road classification system the following guiding principles have been used:

·    Classification system is linked with, and consistent to the Austroads National Functional Road Classification system;

·    Classification system is function based;

·    Traffic volumes, vehicle type, existing road structure, abutting property use, future demand etc, assist in determining appropriate classification; and

·    Width of a road or whether it is sealed is not necessarily criteria that influence a classification.

ROAD CLASSIFICATION

LINK ROAD

A Link Road provides primarily for collecting and distributing traffic from local areas to the wider Arterial Road Network.

It provides connectivity to significant town and rural industries, including farm produce, quarries and tourist’s activities.

Link Roads cater generally for higher traffic volumes (>150ADT), heavy vehicles and higher travel speeds.

COLLECTOR ROAD

A Collector Road provides primarily a feeder service to Link Roads. It provides access to local properties in both rural and town areas and access to moderate local rural industries, including farm produce, quarry and tourist activities.

Collector Roads generally cater for moderate traffic volumes (50 - 100 ADT), and medium travel speeds

ACCESS ROAD

An Access Road provides primarily direct access to occupied residential properties and industries in urban and rural areas.

It provides access to limited local rural industries, including farm produce, quarry, and tourist activities.

Access Roads cater generally for lower traffic volumes (20 – 100 ADT), and low travel speeds.

LIMITED ACCESS/TRACK

A Limited Access Road/Track provides primarily access to undeveloped properties in rural areas.

It is not required to provide daily access to residences, and may be used for paddock access, fire protection purposes and management access.

Limited Access roads / Tracks cater for very low speeds, low traffic volumes (<10 ADT)

7.2     Footpath Classification

The footpath classification system has been developed based on the expected usage of the network.

FOOTPATH CLASSIFICATION

PRIMARY ACCESS ROUTE

Provides services to areas with expected high volumes of pedestrian traffic.

Generally confined to commercial areas.

SECONDARY ACCESS ROUTE

Provides services to areas with lower expected volumes of pedestrian traffic.

Predominantly confined to residential areas.

8.        Standards for Upgrading and Renewal of Road Assets

The Standards for construction of new rural local roads and for the expansion, upgrading and renewal of existing rural local roads, have been developed in accordance with the standards described in Schedule B Standards for Urban streets are determined on an individual basis depending on site conditions, traffic and amenity.

The standards take into account road user requirements relating to operational comfort, convenience, safety and the funding resources available to Council.

Compatible cross-section, horizontal and vertical alignment will provide users with an consistent quality of service in terms of ride comfort, convenience and a safe facility.

It is not intended that all roads will comply with adopted Standards, however any new or refurbishment work should be constructed to the desirable Standard, where practicable. In instances where adopted standards cannot be achieved, professional judgements will be adopted.

9.        Maintenance Standards

Maintenance Standards have been developed in consultation with internal stakeholders, the community, an assessment of available historical data and industry standards.

Standards will vary across the road network in line with relevant risk factors such as the nature and volume of traffic using the road, operating speed, the susceptibility of assets to deterioration, the cost effectiveness of repairs and the competing priorities for funding. The variation of maintenance standard across the network is reflected in Council’s road classification system.

Council has identified critical maintenance defects for all roads for which it is responsible. For each defect, the following criteria have been developed:

·    The level at which the defect is a potential safety hazard; and

·    The level at which a defect reaches a desirable performance standard.

In determining the point at which a defect is identified as a potential hazard, Council has referred to industry standards developed by Austroads and VicRoads.

Schedule C provides the hazard description adopted by Council for roads for which it is responsible. The desirable performance standards describe the standard at which maintenance works are to be implemented. They are based on community consultation, available resources and the optimal time to intervene to maximise the life of the road. The performance standards are under development and will form part of Council’s Road Asset Management Plan.

10.      Monitoring System and Response

Council inspects all roads for which it is responsible on a cyclic basis to identify potential safety hazards, and defects which exceed accepted maintenance standards.

The inspection program reflects the road priority identified in the road classification system and appropriate use of resources.

INSPECTION TYPE

INSPECTION FREQUENCY BY CLASSIFICATION

Footpaths (all)

Link Road

Collector Road

Access Road

Limited Access / Track

Day Time

Yearly

Four per year

Twice per year

Once per year

Once every five years

Night Time

Not inspected

Yearly

Once every two years

Once every five years

Not inspected

In addition to being identified through the routine monitoring system, defects are logged into Council’s Customer Service Request System from other sources, including identification by a customer or road user.

When a defect is identified through routine inspection, or reported from a customer, the defect is logged electronically to identify the nature of the defect, its location, the responsible officer, and the appropriate response.

Bridge Structures are inspected once per year. The VicRoads Level 1 Bridge Inspection form is used to record the annual inspections.

Once identified the defects are then assessed and actioned. Appendix C describes the hazard response adopted by Council for each classification of road.

11.      Force Majeure

Council will make every endeavour to meet all aspects of its Road Management Plan. However, in the event of natural disasters and other events including, but not limited to, fires, floods, droughts, and the like, together with human factors, such as lack of Council staff or suitably qualified Contractors, because of Section 83 of the Victorian Wrongs Act 1958, as amended, Council reserves the right to suspend compliance with its Road Management Plan.

In the event that the CEO of Council, has to, pursuant to Section 83 of the above Act, consider the limited financial resources of Council an its other conflicting priorities, meaning Council’s Plan cannot be met, they will write to Council’s Officer in charge of its Road Management Plan and inform them that some, or all, of the timeframes and response times are to be suspended.

Once the events beyond the control of Council have abated, or if the events have partly abated, Council’s CEO will write to Council’s Officer responsible for Council’s Plan and inform them which parts of Council’s Plan are to be reactivated.

12.      Off-Road Paths

Paths, walking tracks and trails which are not located on the Public Roads are not included in the Council Register of Public Roads and are excluded from this Road Management Plan.

These paths are considered off-road and are located in recreation reserves, parklands, or properties for which Council has responsibility. These paths are inspected and maintained by Council in a similar way to the “Limited Access/Track” as detailed in the Appendices of this plan.

APPENDIX A – ASSET MANAGEMENT SYSTEM

Chart –Planning Process Linkages

Council has commenced the process of developing a robust strategic planning process built around a policy framework established through a careful analysis of economic capacity, risk mitigation and soundly based service standards.

A strong relationship has been developed between asset maintenance, asset renewal and the annual budget decision-making process based on an informed assessment of the resources required to achieve continuous improvement to Council's asset base.

Road expenditure, capital and maintenance, is assessed on the basis of road category, traffic type and volume, road condition, maintenance consumption, associated risk and customer request.   A process for evaluating all asset improvement requests has been developed and is in the process of being implemented.

Each year’s annual program is based on an annual review of the 10 year forward capital program with current year works being prioritised on the basis of road category, traffic type & volume, road condition, maintenance consumption, associated risk and customer request.

The 10 year forward capital program is regularly reviewed by Council taking into account economic capacity, road category, traffic type and volume, road condition, maintenance consumption, associated risk and customer request.

APPENDIX B – STANDARDS FOR UPGRADING AND RENEWAL OF ROAD ASSETS

APPENDIX B – STANDARDS FOR UPGRADING AND RENEWAL OF ROAD ASSETS

APPENDIX C – DESCRIPTION OF HAZARD AND HAZARD RESPONSE

PAVEMENTS

Description of Hazard

Response Time by Classification

Link Road

Collector Road

Access Road

Obstructions and Substances in Traffic Lane

Materials fallen from vehicles, dead animals, wet clay and other slippery substances, hazardous materials, accumulation of dirt or granular materials on the traffic lane of sealed roads

3 days

1 week

1 week

Ponding of water >300mm deep, fallen trees, oil spills, stray livestock.

24 hours

3 days

1 week

Pavement of Surface Defects

Potholes in traffic lane of a sealed pavement greater than 300mm in diameter and greater than 100mm deep or in the traffic lane of an unsealed pavement greater than 500mm diameter and 150mm deep

2 weeks

1 month

3 months

Deformations greater than 100mm under a 3m straight edge

2 weeks

1 month

3 months

Edge drops onto unsealed shoulder greater than 100mm

2 weeks

1 month

3 months

Drainage

Damaged or missing drainage pit lids, surrounds, grates, in pedestrian areas or traffic lanes.

2 weeks

1 month

3 months

ROADSIDES

Vegetation - Trees, Shrubs and Grassed Areas

Tree limbs or trees that have been classified as in danger of falling and causing a danger to the public

24 hours

3 days

1 week

Trees, shrubs or grasses that have grown to restrict design sight distance to intersections or restrict viewing of safety signs

2 weeks

1 month

3 months

Vegetation intruding within an envelope over roadways from the back of shoulder and/or kerb and a minimum of 5m height clearance over pavement and the trafficable portion of shoulders.

3 months

6 months

12 months

Safety signs missing, illegible or damaged making them substantially ineffective

2 weeks

1 month

3 months

Guideposts missing or damaged at critical locations making them substantially ineffective

3 months

6 months

12 months

Safety barriers and fencing missing or damaged at critical locations making them substantially ineffective

3 months

6 months

12 months

Pavement markings missing, illegible or confusing at a critical location

3 days

1 week

2 weeks

STRUCTURES

Damage affecting structural performance.

24 hours

24 hours

1 week

APPENDIX C – DESCRIPTION OF HAZARD AND HAZARD RESPONSE

FOOTPATHS AND PATHWAYS

Footpath Classification

Primary Access Route

Secondary Access Route

Defective pedestrian areas with a step greater than 25mm

6 months

12 Months

Vegetation which presents a physical hazard to the public over pedestrian/bicycle paths, intruding into a clearance envelope between the edges of path and a minimum of 2.5m height clearance over path.

6 months

12 Months

When Council inspects or is notified of a hazard, Council will rectify it if possible, or provide appropriate warning within the response time indicated. Where, because of the nature of the repair required, level of resources required or workload, it is not possible to rectify within the time shown, appropriate warning of the hazard is to be provided until the repair can be completed

Appropriate warning could include, for example:

·    Provision of warning signs,

·    Traffic control action

·    Diverting traffic around the site,

·    Installation of a temporary speed limit,

·    Lane closure,

·    Closure of the road to use by certain vehicle (eg a load limit), or

·    Road closure

·    Or any other measure which reasonably addresses the duty of care to road users.

Limited Access/Tracks are inspected every five years. Repair works are scheduled on a programmed basis and will be attended to when resources become available.

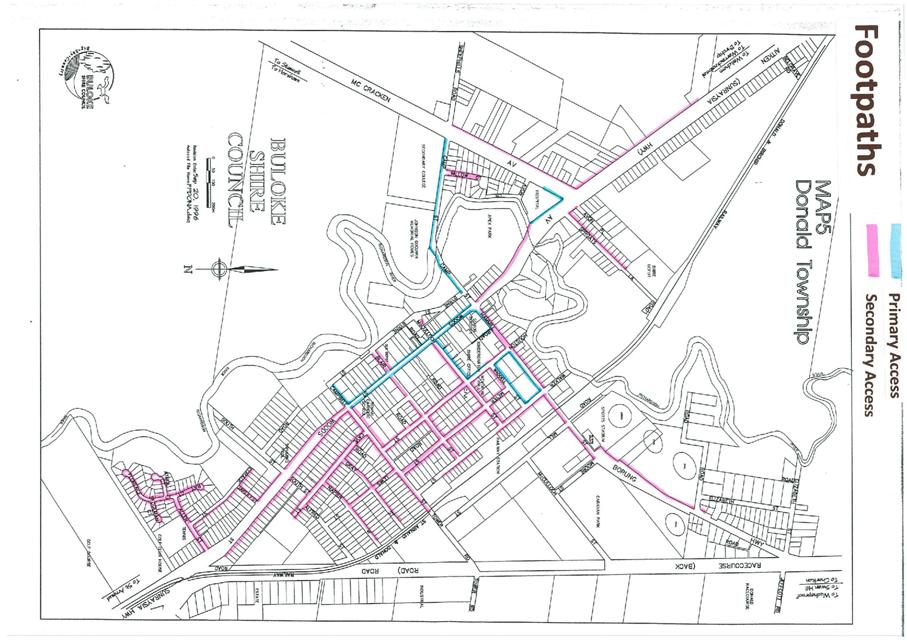

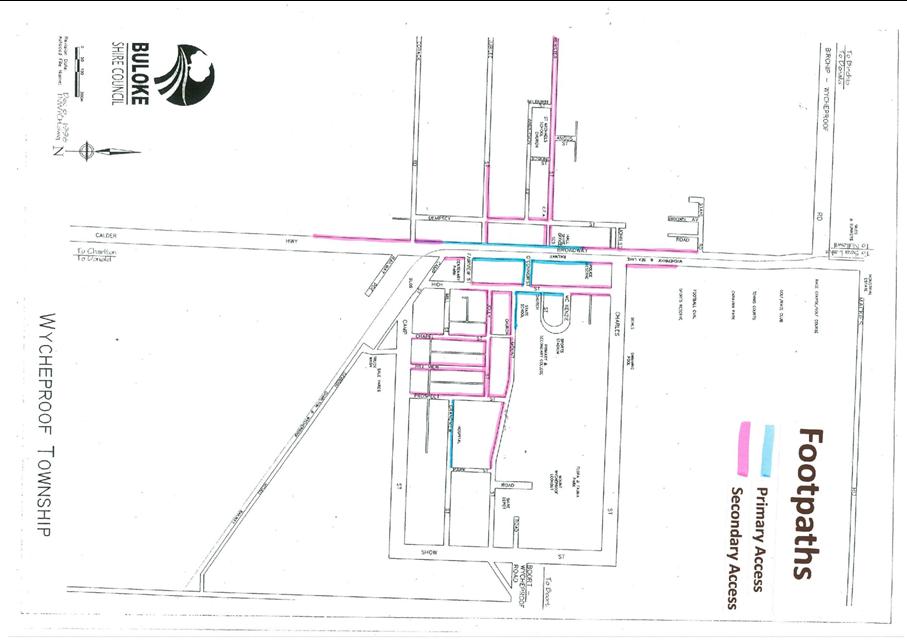

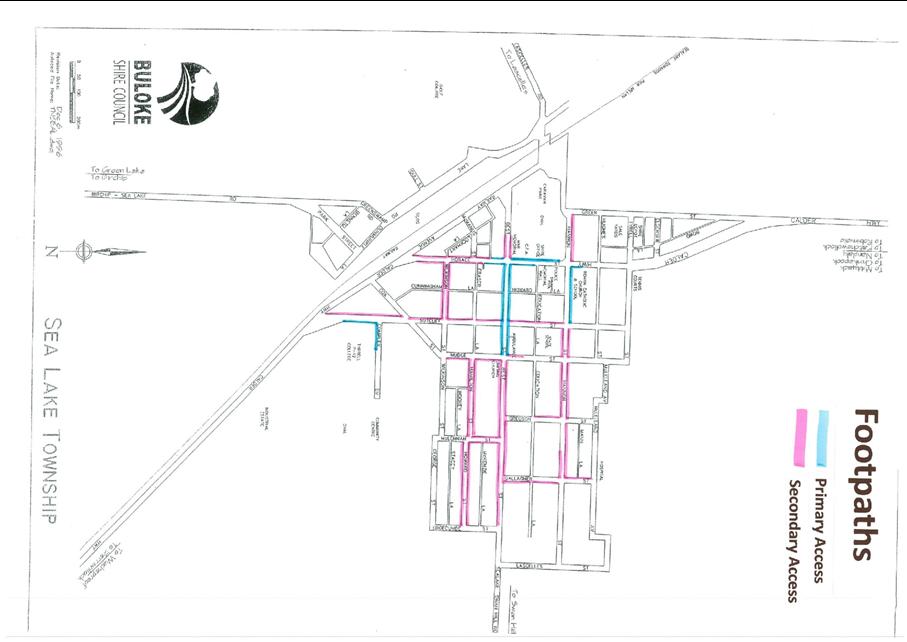

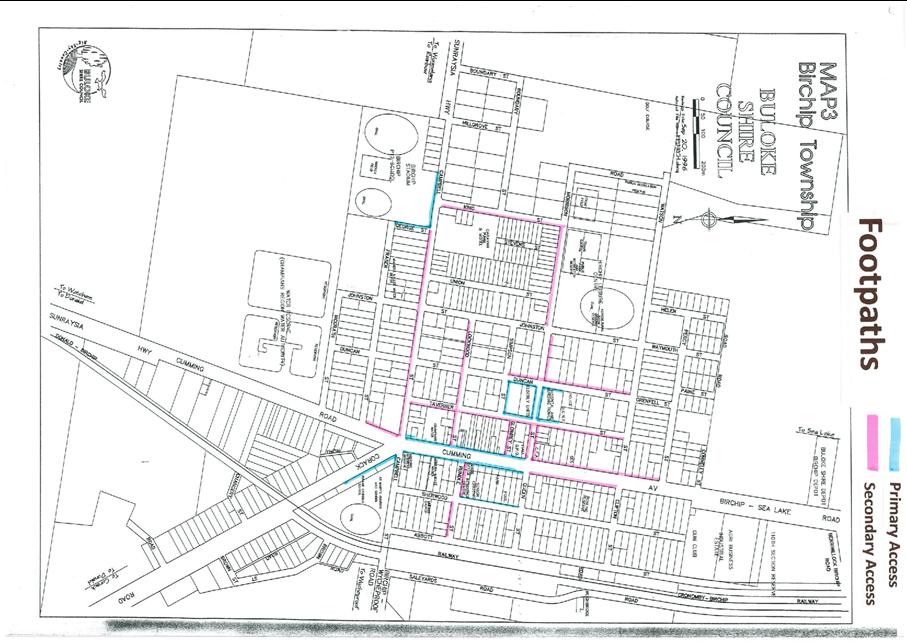

APPENDIX D – ROAD AND FOOTPATH HIERARCHY MAPS

Buloke Shire Council Ordinary Meeting Minutes                                                                        Wednesday, 12 February 2014

7.2.6                 Road Management Plan Review

Attachment 2    Road Management Plan Maps

Buloke Shire Council Ordinary Meeting Minutes                            Wednesday, 12 February 2014

7.3       Financial Reports

7.3.1    2013-14 Mid Year Budget Review

Author’s Title:           Acting Chief Executive Officer

Department:              Office of the CEO                                            File No: 0213

Attachments:

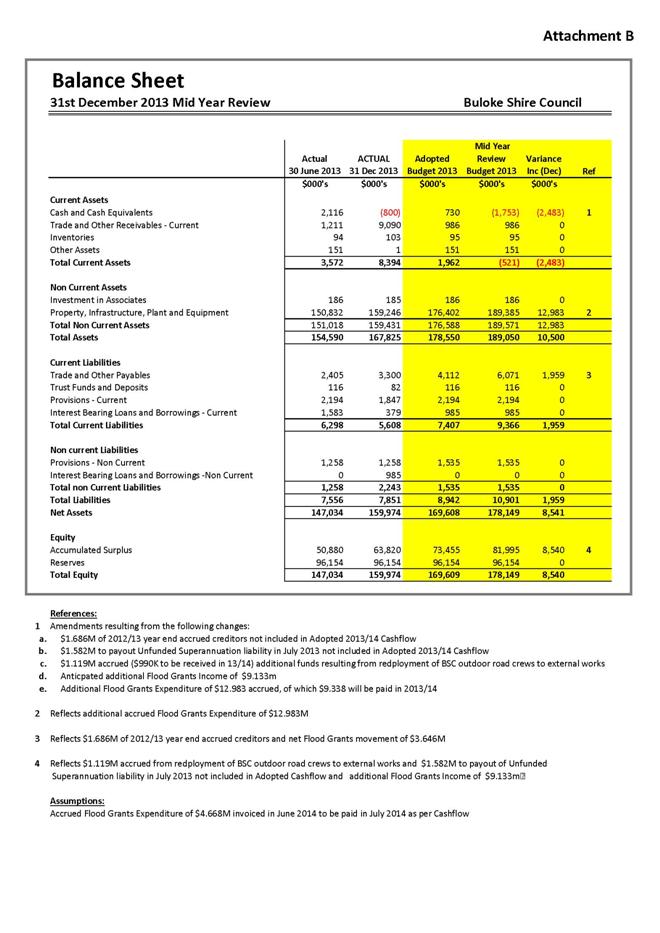

1       ViewFinance Report - 2013 - 2014 Mid Year Budget Review

Relevance to Council Plan 2013 - 2017

Objective:                            An organisation that is responsibly governed with a strong emphasis on sustainable financial and risk management.

Strategy:                              Ensuring Council is well governed and its finances and risks are managed sustainably and responsibly.

Priority:                                Review and renew the Council’s financial plans to improve financial sustainability as measured by indicators of local government financial sustainability developed by the Victorian Auditor-General’s Office.

Motion:

That:

1.       Council receive and note the mid-year financial report and adopt the variances detailed in the report.

Moved:             Cr Gail Sharp

Seconded:      Cr David Pollard

Carried.

1.       Executive Summary

The purpose of this report is for Council to assess its mid-year financial position and to amend its 2013-14 Annual Budget to reflect the known variances that have occurred during the first half of the financial year.

2.       Discussion

Council adopted its budget for the 2013-14 financial year, however the finances of Council should be reviewed on a regular basis to identify any variations that have occurred from the adopted position.  There are a number of factors that will contribute to variations which are detailed in the attached financial report.

The 2013-14 Mid-Year Budget report has been prepared based on the identification of major variances.  There have been further minor adjustments in program areas which have not resulted in a substantive change from the adopted budget position.  Only major variations have been included in the Mid-Year Budget Report.

Major Variations

The major variations reported in the attached financial report are as follows:

The opportunity has arisen to increase the external works carried out by Councils outdoor road crews.  This is expected to result in a positive variance of $1.119m.

The roads flood recovery works have been accelerated to ensure completion of the works by 30th June 2014.  This will see additional income from flood funding of $9.133m and expenditure in the 2013-14 financial year of $9.338m.

The payment of $1.582m for Unfunded Superannuation liability has been included in the cash flow statement as well as $1.686m of 2012-13 year end accrued creditors which need to be accounted for in the 2013-14 statements.  Both of these items were not accounted for in the cash flow statements presented to Council on the adoption of the budget.

The above variations impact on Councils adopted budget by improving Council’s net surplus from operations by $10.25m and resulting in an unfavourable variation to Councils forecast cash position at 30 June 2014 by $2.48m.

Council’s capital works will increase from the budgeted amount by $13.36m as a result of the acceleration of the flood recovery works.  Excluding the flood recovery works, there is not expected to be a significant variation in Council’s capital works expenditure for 2013-14, with a total reduction in expenditure of $28,000 to $6.05m.

3.       Financial Implications

The adoption of the Mid-Year Budget Report confirms Council’s financial position at  31st Dec 2013 and projects adjustments to its projected budget position at 30th June 2014.

4.       Community Consultation

The Local Government Act 1989 indicates that where changes to the Council’s Annual Budget are not material or do not involve any alteration to the rating structure or involve new Council borrowings, public notice of the 2013-14 Mid-Year Budget is not required.

This Mid-Year Budget Report meets this legislative requirement.

5.       Internal Consultation

The review has been conducted in consultation with all staff directly responsible for Council budgets.

6.       Legislative / Policy Implications

The report is consistent with the requirements of the Local Government Act 1989.

7.       Environmental Sustainability

This report has no direct impact on environmental sustainability.

8.       Conflict of Interest Considerations

nil

9.       Conclusion

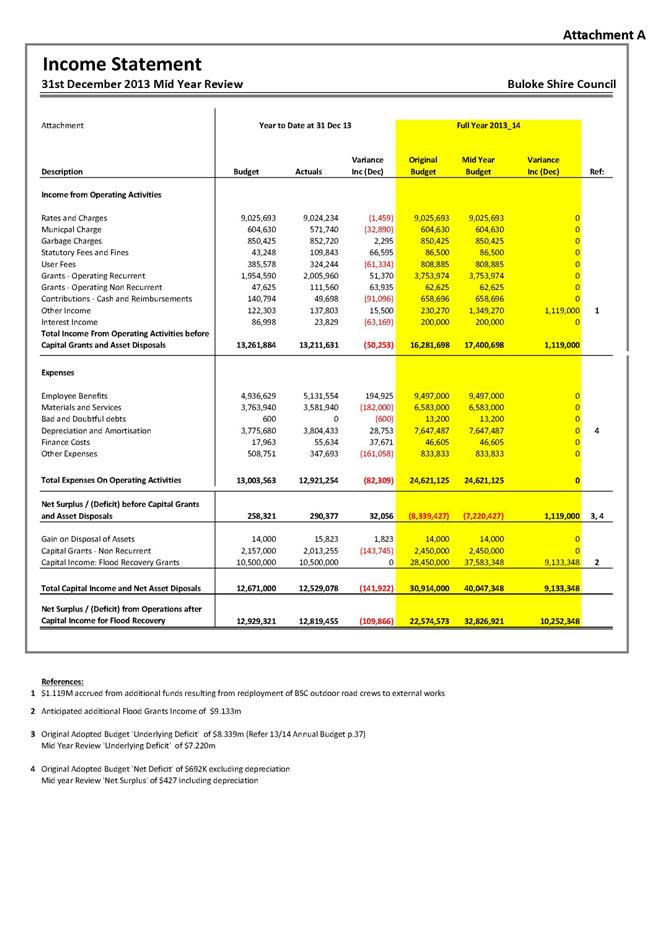

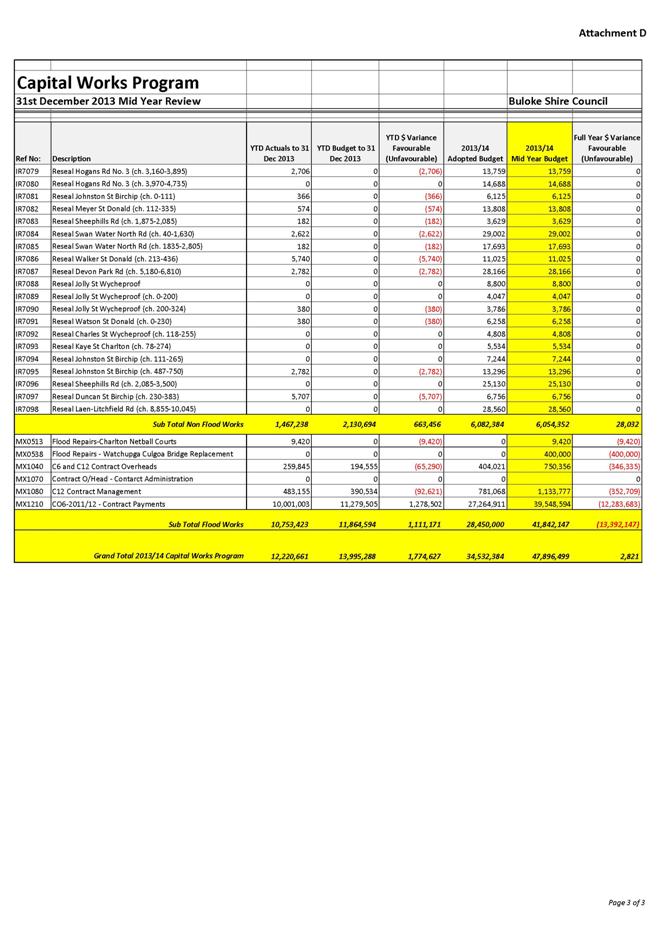

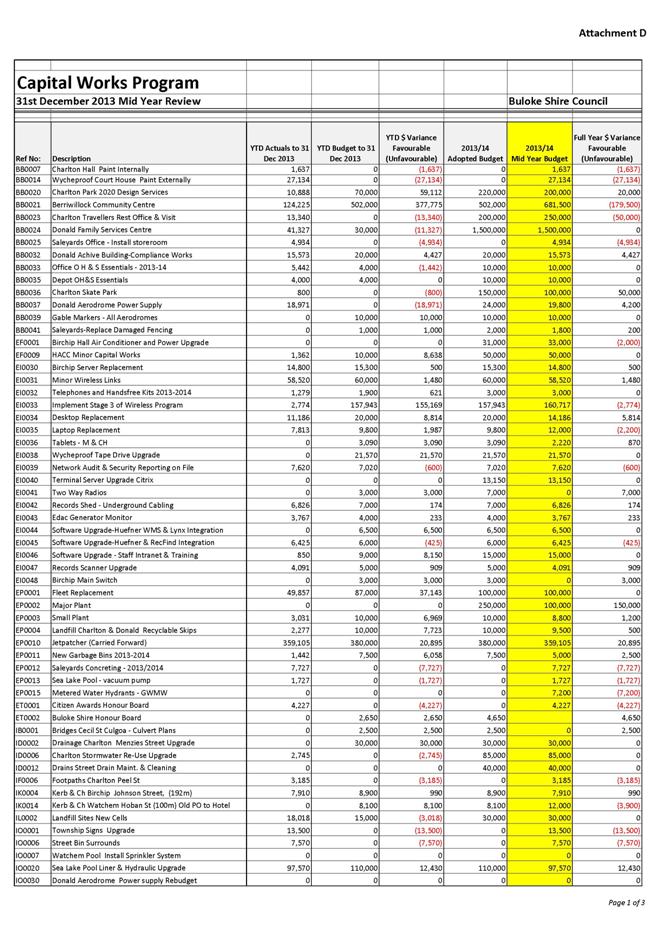

The Mid-Year Budget Report reinforces the difficult financial position of the Council.  Although it is expected that there will be an improved position with respect to Net Surplus from Operations, if flood recovery works are excluded from the accounts, the Council is facing a Net Deficit of $7.22m.  In addition, Council is faced with a Deficit Cash Position at 30 June 2014 of $1.75m, with a Restricted Cash Liability of $4.78m.

This highlights the issues raised in Council’s budget papers and the recent VAGO Report about the ongoing financial sustainability of Council.  Council will need to consider reductions in Operating and Capital Expenditure in the preparation of its 2014-15 budget and Long Term Financial Plan.

Buloke Shire Council Ordinary Meeting Minutes                                                    Wednesday, 12 February 2014

7.3.1                 2013-14 Mid Year Budget Review

Attachment 1    Finance Report - 2013 - 2014 Mid Year Budget Review

Buloke Shire Council Ordinary Meeting Minutes                             Wednesday, 12 February 2014

8.          REPORTS FROM COUNCILLORS

8.1       Delegate Reports

Motion:

That Council note the Councillor Delegate Reports as presented.

Moved:             Cr Ellen White

Seconded:      Cr Leo Tellefson

Carried.

8.2       Activity Reports

Cr Stuart McLean

13 December 2013       Christmas Function – Birchip

                                      Wycheproof P-12 College Presentation Night

17 December                Wimmera Mallee Tourism Association – Chaired

                                      Wycheproof Vision Meeting on Mount

15 January 2014           Birchip Cropping Group – Andrew Broad Visit

26 January                    Australia Day Celebrations – Charlton and Wycheproof

29 January                    Assembly of Council

3 February                    Buloke Tourism Board

5 February                    Victorian Police Community Conversations – Charlton and Wycheproof (approximately 50 at Charlton and 100 at Wycheproof)

10 February                  Assembly of Council

11 February                  East Wimmera Health Service – Community forums – Wycheproof

12 February                  Ordinary Meeting of Council

Motion:

That Council note the Councillor Activity Reports as presented.

Moved:             Cr Leo Tellefson

Seconded:      Cr David Pollard

Carried.

8.3       Report from the Mayor

A verbal Activity Report was presented by the Mayor.

Buloke Shire Council Ordinary Meeting Minutes                             Wednesday, 12 February 2014

9.          OTHER BUSINESS

9.1       Petitions

                         Nil

9.2       Notices of Motion

9.2.1

Victoria Police - Community Conversations (Nom No. 32) (Cr McLean)  (CR/13/01)

Motion:

That Council write to the Victoria Police Regional Inspector, with a copy to local Police Stations, acknowledging their initiative to hold the “Community Conversations” Sessions and also the importance and success of such sessions.  Council to state these sessions allowed the community to view their concerns and for  the Victoria Police representatives to hear their concerns, which will lead to improved community policing in the Shire.

Moved:          Cr Stuart McLean

Seconded:   Cr David Pollard

Carried.

9.3       Questions from Councillors

9.3.1    presentation from gwm water

Cr Milne referred to a Presentation from Grampians Wimmera Mallee Water (GWM) and enquired what is the situation regarding the Water Tank and Cr Mather responded that GWM Water are waiting on a response from the State Government.

9.4       Questions from the Public

                         Nil

9.5       Any Other Procedural Matter

                         Nil

9.6       Urgent Business

                         Nil

10.       MATTERS THAT MAY EXCLUDE THE PUBLIC

                         Nil

11.       ANY OTHER BUSINESS

12.       MEETING CLOSE

Meeting closed at 7.58pm.
