Ordinary Council Meeting

 Addendum Agenda

Wednesday 8 May 2013

Commencing at 7.00pm

Wycheproof Supper Room

367 Broadway, Wycheproof

Warwick Heine

Chief Executive Officer

Buloke Shire Council

Buloke Shire Council Ordinary Meeting Addendum Agenda                    Wednesday, 8 May 2013

ADDENDUM AGENDA

7.2.... Management Reports

7.2.10      Donald Hockey Club Changeroom Development  3

7.2.11      Charlton and Donald Flood Study - Funding Submission  9

7.2.12      Roadside Weed and Rabbit Control Plan 2013/2015  13

7.2.13      Exercise of Lease Option - Automatic Weather Station, Charlton Landfill  32

7.3.... Financial Reports

7.3.1        Finance Report as at 30 April 2013  35

L....... Report from the Mayor

L.1            Report from the Mayor  54

WARWICK HEINE

CHIEF EXECUTIVE OFFICER

Buloke Shire Council Ordinary Meeting Addendum Agenda                   Wednesday, 8 May 2013

7.2.      Management Reports

7.2.10  Donald Hockey Club Changeroom Development

Author’s Title:           Recreation Officer

Department:              Assets and Infrastructure                               File No: CP/10/07

Attachments:

1       ViewApproval to amend Master plan

Relevance to Council Plan 2009-13

Objective:                                 A Buloke community where people of all ages, backgrounds and abilities, are embraced and supported and can access the Council services they need to help live healthy and fulfilling lives.

Strategy:                                   The contribution of all communities, large and small, in planning for and making decisions about the future is facilitated and recognised.

Priority:                                     Ensure all major projects and strategies are informed through community and stakeholder consultation which is guided by Council’s Community Consultation framework and where relevant, appropriate advisory committees and/or mechanisms.

RECOMMENDATION

That:

1.       Council note the contents of the report

2.       The Donald Recreation Reserve Master Plan be amended to reflect the decision by the Donald Recreation Reserve Committee to support the provision of an additional stand alone facility for the Donald Hockey Club on the Reserve

3.       Council staff continues to liaise with the Donald Hockey Club and Donald Recreation Reserve Committee on the proposed development.

4.       The Donald Hockey Club and Donald Recreation Reserve be advised that Council is not at this point in time prepared to support an application for funding for this project to the State Government’s Putting Local’s First funding program on the basis that has not been identified as a priority compared to other projects already listed on Council’s Forward Capital Works Program.

1.       Executive Summary

The Donald Recreation Reserve Master Plan prepared n 2011 identified as a high priority the rectification/improvement of the Jeffcott Cricket Pavilion and toilets to become a dual Hockey and Cricket club room.

Upon meeting Donald Hockey Club representatives in December 2011 to begin the facilitation of planning for this project, the club members highlighted proximity to the Hockey Ground as an important issue and indicated their desire for a facility of their own, in close proximity to the ground and providing toilet/change and kitchen facilities.

2.       Discussion

In early June 2012, a meeting was arranged with a DPCD representative, the Hockey Club, representatives of the Bendigo Bank (Donald and Bendigo) and Members of the Donald A & P Society.

The DPCD representative recommended the Club look to the RDV’s Putting Locals First Funding program to enable the project to go forward.  The A & P Society also indicated their interest in sharing the facility with the Hockey Club.

On 28 October 2012, an enquiry into the required statutory permissions for a Place of Assembly at the Donald Recreation reserve was received by the Planning Officer.

A letter was sent on 29 October 2012 outlining the planning requirements including design plans. This letter also strongly recommended that another meeting take place between the club and Council’s Recreation Officer given the building proposal is not in keeping with the adopted Master Plan for the reserve.

A planning permit application was submitted on 19 November 2012 with a site plan, elevations and other requirements. The estimated cost of the proposed works was $240,000.

The application was referred to the North Central Catchment Management Authority (NCCMA), who approved it with a minimum height condition, and to the Department of Sustainability and Environment (DSE) who were concerned about Cultural Heritage issues on the site. However, DSE have since issued a letter (26 April 2013) advising no objection to the proposal and proposing no conditions.

On 5 December 2012, Council’s Recreation Officer sent an email to the Chairman of the Donald Recreation Reserve Committee of Management (attached) briefly highlighting the project and requesting formal approval from the Committee for the proposed works on the Reserve and for agreement to amend the Master plan to reflect this.

A response was received on the 6 December 2012 confirming the Committee’s approval for the project and amendment to Master plan on the Donald Recreation Reserve.

A planning permit is now required to be issued within the sixty day statutory time frame.

A building permit is also required for the works and a submission for this has not been made as of 2 May 2013.

Further detailed drawings of the proposed building from a registered building practitioner will be required to ensure compliance with the Building Code before a building permit may be issued. This can be included in the planning permit final letter. The choice of the building surveyor is with the land owner as it will be a council asset. It is proposed the Municipal building surveyor should be the registered building surveyor.

As per the building permit application, a quote of the value of the works will be required.

In recent discussions with the Coordinators of the project, it was identified that at present the Club, with local funding partners has approximately 30% of the proposed project cost and upon approval of planning permit and building permit would seek further funding from other programs, including where possible, Regional Development Victoria’s Putting Local’s First Program. Assuming the cost of the building remains at the estimated the potential call on the Putting Local’s First Program would be $168,000.

Council will need to consider its support under the Putting Local’s First Program alongside other priority projects.

The need for this proposed development has been well documented. The proposal is consistent with the Donald Recreation Reserve Master Plan to the extent that the need for the facility was identified as part of that process, all be it that at different solution was proposed as part of the final Master Plan.

Current priorities for expenditure at the Donald Recreation Reserve are for an upgrade of power supply and implementation of the recommendations from the recent Essential Services Review of facilities at the Reserve. Bringing this project forward potentially delays implementation of these two projects that are essential for the long term development of the Reserve and for public safety.

Construction of a Hockey Pavilion at the Donald Recreation Reserve is currently programmed for consideration in the 2016/17 as part of the Forward Capital Works Program, but could be pushed beyond that year as a result of the lack of availability of the required funds.

The proposal by representatives of RDV that funding for this project be sought from the Putting Locals’ First Program raises a separate matter for Council, how this project is treated in relation to other projects given higher priority in Council’s Forward Capital Works Program. While the worth of the project is not under debate support for funding from Putting Local’s First effectively allows this project to ‘queue jump’ other projects that are of similar importance to other parts of the Shire.

Council needs to consider this project in the context of other proposed capital works projects and the implications associated with re-determining project priorities on an ad hoc basis.

3.       Financial Implications

There are no direct financial implications from this report unless Council determines to reassign CapEx priorities to make this project a priority for 2013/14. .

Council staff will continue to work with the committee to gain an understanding of the construction costs and funding options.

When constructed the building will become a Council asset and be included in Council’s asset register, require annual insurance, maintenance and depreciation allocations.

4.       Community Consultation

As indicated in the main section of the report, there has been significant consultation with the Donald Hockey Club, project coordinators and Donald Recreation Reserve Committee in the development of this project.

5.       Internal Consultation

This report utilises information from Council’s Senior Planning Officer.

Internal consultation on this development has been conducted with the Manager Assets & Infrastructure.

6.       Legislative / Policy Implications

All legislative or Policy issues have been addressed through the planning permit stage of the project.

7.       Environmental Sustainability

N/A

8.       Conflict of Interest Considerations

N/A

9.       Conclusion

This project seeks to vary the Donald Recreation Reserve Master Plan and has the support of the Donald Recreation Reserve Committee to alter the Master Plan accordingly.

More work is required on the plans for the proposed building to meet Building Control requirements. The need to address minimum height conditions may add to the cost of the project.

Council also needs to consider funding options for this proposed project. The Donald Hockey Club is fund raising to meet the cost of the project but support is currently required from Council for grant applications. This request needs to be considered in the context of similar requests from other groups across the Shire.

Buloke Shire Council Ordinary Meeting Addendum Agenda                      Wednesday, 8 May 2013

7.2.10               Donald Hockey Club Changeroom Development

Attachment 1    Approval to amend Master plan

From:                                         Andrew Griffiths [griffiths.andrew53@gmail.com]

Sent:                                           Thursday, 6 December 2012 2:41 PM

To:                                               Paul Fernee

Cc:                                               Anthony Judd

Subject:                                     Re: Donald Recreation reserve Masterplan

Hello Paul

The committee is aware and supportive of the proposal for the new change facility at the hockey area . We are conversant with

the alteration to the original master plan and as such , we fully consent to an amendment to allow it to proceed .

l hope this brief but to the point reply is sufficient confirmation for you and look forward to continued cooperation .

lncidentally , l don't think we had a meeting scheduled until next year but will keep you informed .

Regards

Andy  Griffiths

Chairman , Committee of Management

On Wed, Dec 5, 2012 at 12:36 PM, Paul Fernee <PFernee@buloke.vic.gov.au> wrote:

Hi Andy,

As you are likely aware there is a new change facility in the works for the hockey club on the Donald Rec reserve.

The proposal is obviously different to the master plan that was developed for the site.  Council is happy to amend the Master plan to reflect the new building, but request that the Donald Recreation Reserve Committee provide a letter to myself and/or Anthony Judd highlighting that you approve of the development outside the scope of the Master plan.

I would be grateful for yours and the Committees assistance in accepting this new building within the Recreation Reserve Complex.

Also I am still keen to attend your next scheduled committee meeting.

Kind Regards,

Paul Fernee
Recreation Officer
Buloke Shire Council

p. (03) 5478 0179 | m. 0409 590 486
a. PO Box 1, Wycheproof VIC 3527
pfernee@buloke.vic.gov.au
http://www.buloke.vic.gov.au

DISCLAIMER

This email and any attachments may contain information that is confidential, legally privileged and/or copyright. If you are not the intended recipient, any use, disclosure, distribution or reliance on the information contained in this e-mail is unauthorised. You should only re-transmit or distribute the information if you are authorised to do so.

If you have received this e-mail in error please notify Buloke Shire Council by return e-mail to buloke@buloke.vic.gov.au and destroy all copies printed or held on any computer. Buloke Shire Council does not warrant that this e-mail and any attachments are free of viruses.

Buloke Shire Council

PO Box 1 Wycheproof 3527

Ph:  (03) 5478 0100

Fax: (03) 54937395

Buloke Shire Council Ordinary Meeting Addendum Agenda                   Wednesday, 8 May 2013

7.2.11  Charlton and Donald Flood Study - Funding Submission

Author’s Title:           Manager Assets & Infrastructure

Department:              Assets and Infrastructure                               File No: DR/19/05

Attachments:

Nil

Relevance to Council Plan 2009-13

Objective:                                 A Shire where roads, drains, public spaces, community facilities, parks and other essential infrastructure are fit for purpose, well maintained and contribute to the well-being of the community

Strategy:                                   Maintaining and improving the condition of our assets to ensure essential services are provided and the community has access to quality public facilities.

Priority:                                     Continue the development and implementation of plans to protect and manage public assets in the Shire for the long-term.

RECOMMENDATION

That:

1.       The Council apply for funding under the Natural Disaster Resilience Grant Scheme for the following projects:

-    Construction of stage one of the Donald Levee Bank development – Levees 2 and 3 only (total cost $925,000).

-    Development of the detailed design of the proposed Charlton Ring Levee (total cost $250,000).

-    Construction of a floodway on the Charlton-St Arnaud Road (total cost $500,000)

2.       The Council consider a 10% contribution toward the Donald Levee Bank Development ($92,500) and development of the detailed design work for the proposed Charlton Ring Levee ($25,000) as part of the 2013/14 Council budget preparations.

3.       The Council does not financially contribute toward the construction of the proposed floodway on the Charlton-St Arnaud Road as it is a VicRoads owned and controlled asset.

1.       Executive Summary

The Charlton and Donald Flood and Drainage Management Studies, which have been managed by the North Central Catchment Management Authority (NCCMA), are nearing completion.

Both studies have raised a range of structural and non-structural options for flood protection and mitigation.

Funding for further investigation and implementation of the recommendations from the two studies is available through the National Disaster Resilience Grants Scheme (NDRGS). Applications to the Scheme close on 22 May 2013. Grants made under the NDRGS require contributions from State and Local Government.

It is proposed Council make application for grants under the NDRGS but seek a reduction in local contribution on the basis of financial hardship.

2.       Discussion

Charlton

The Charlton Flood Study is nearing final completion and at the most recent Steering Committee and subsequent community meeting; it recommended Council consider applying for funding to carry out two of the key structural recommendations of the plan:

·   The development of a ring levee around the township at an estimated cost of $5million

·   Converting the culverts on the Charlton – St Arnaud Road back to a floodway at an estimated cost of $500,000.

Charlton Flood Study Proposed Works

Estimated Cost

·   Construction of flood protection levees

$5 million

·   Increasing the capacity of the St Arnaud Road culverts

$0.5million

Total Estimated Cost

Benefit Cost Ratio*

$5.5 million

0.97

Whilst there is in principle community support for the concept of the levee option, there have been a range of concerns raised regarding the cost, design and location of the final levee. In particular, the proposed levee has the potential to adversely affect a number of rural properties on the outskirts of town.  Further work is required to ensure that these adverse impacts can be practically managed.

Additional information is required in order for the community and Council to make a final decision on the levee.

Funds are required to undertake a detailed costing, landholder negotiations and functional design.

The estimated cost to complete the additional design work is $250,000.

It was evident through this consultation that there was significant community desire to increase the capacity of the culverts underneath the Charlton-St Arnaud Road.

Flood modelling undertaken through the development of the Plan has determined that in as little as the 10% AEP flood event, floodwaters as they cannot flow freely into the Avoca River are diverted into Charlton. Another significant benefit of the proposed works is that in larger flood events, such as a repeat of the September 2010 flood event, flooding of properties in the business area of Charlton would be delayed by in the order of 5-8 hours.

The original proposal was to install larger culverts in this location, however due to the magnitude of the flow; culverts would be unable to adequately convey the flow.  The construction of a bridge is cost prohibitive, therefore it is proposed to return the waterway crossing to a floodway.

The estimated cost to return the waterway crossing to a floodway is $500,000. Given this is a VicRoads asset, it is not recommended that Council financially contribute toward this project, however Council will apply for the full amount of funding for this project.

Donald

The Donald Flood Study is also nearing final completion and the steering committee have endorsed the recommendation for a series of levees around the township.

Donald Flood Study Proposed Works

Estimated Capital Cost

Construction of four flood protection levees

·   Levee 1 – Donald Swimming Pool

·   Levee 2 – Donald Township

·   Levee 3 – Johnson Goodwin Aged Care Facility

·   Levee 4 – Elizabeth Street

$350,000

$730,000

$195,000

$230,000

Total Estimated Cost

$1,505,000

Benefit Cost Ratio

0.74 (0.98 for levees 2&3 only)

Whilst the construction of all four levees is supported by the committee that oversaw the development of the plan, Stage One of the implementation involves design and construction of the two highest priority levees (levee 2 and levee 3).

Extensive community consultation has been undertaken and there is strong community support for the proposed highest priority levees.

The estimated cost of the design and construction of the two levees is $925,000.

Natural Disaster Resilience Grants Scheme (NDRGS)

The NDRGS has recently been announced and is funded by the Australian Government under a National Partnership Agreement with each state and territory.

This program is designed to support projects leading to the following outcomes:

-    Reduced risk from the impact of disasters and

-    Appropriate emergency management, including volunteer, capability and capacity consistent with the State’s risk profile.

The normal applicant contribution for a project is 50%.

Consideration may be given to approving a project with a lower applicant contribution in cases councils with low financial capacity or other organisations.

Buloke has a low financial capacity and it is proposed that it also argue hardship to reduce its contribution to the Scheme to 10% over the two levee based projects.  Hardship is argued on the basis of Council’s current financial position and budget outlook.

Grant applications are due on the 22nd May.

3.       Financial Implications

The total cost of the projects recommended by the two Flood Plan studies is as follows:

-    Stage one of the Donald Levee Bank development (levees two and three only): $925,000

-    Development of the detailed design of the proposed Charlton Ring Levee: $250,000

-    Installation of a floodway on the Charlton-St Arnaud Road: $500,000.

It is proposed that Council consider contributing 10% of the costs toward the Donald levee and Charlton design works, totalling $117,500 in the 2013/14 capital budget.

Council will be responsible for the ongoing cost of maintaining the levee.

It is not proposed that Council contribute toward the cost of installing a floodway at the Charlton.

4.       Community Consultation

There has been a number of community meetings and other opportunities for residents in the Charlton and Donald districts to be part of these studies. A community based steering committee was developed for each township, who have led the development of these plans

5.       Internal Consultation

The North Central Catchment Management Authority has held meetings with Councillors and key council staff throughout the development of both studies, and staff will work together on the development of the funding applications.

6.       Legislative / Policy Implications

Nil.

7.       Environmental Sustainability

Nil.

8.       Conflict of Interest Considerations

Nil.

9.       Conclusion

It is recommended that the Council apply for funding under the Natural Disaster Resilience Grant Scheme for the following projects:

-    Stage one of the Donald Levee Bank development – Levees 2 and 3 only (total cost $925,000).

-    Development of the detailed design of the proposed Charlton Ring Levee (total cost $250,000).

-    Installation of a floodway on the Charlton-St Arnaud Road (total cost $500,000)

The Council consider the a 10% contribution to the Donald Levee Bank Development ($92,500) and development of the detailed design work for the proposed Charlton Ring Levee ($25,000) in the 2013/14 Council budget.

The Council does not financially contribute to the proposed floodway on the Charlton-St Arnaud Road as it is a VicRoads owned and controlled asset.

Buloke Shire Council Ordinary Meeting Addendum Agenda                   Wednesday, 8 May 2013

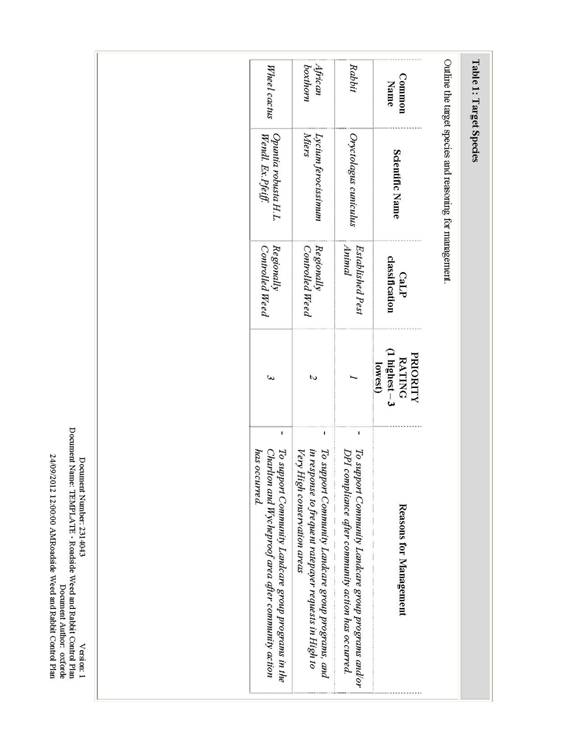

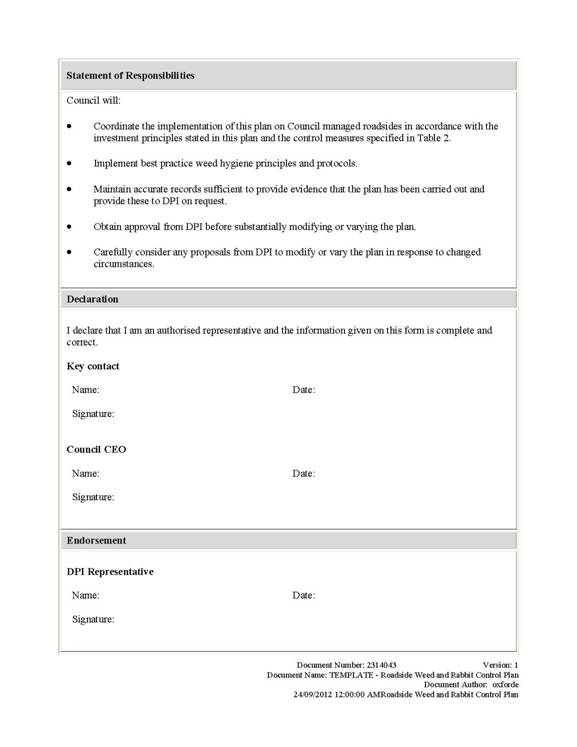

7.2.12  Roadside Weed and Rabbit Control Plan 2013/2015

Author’s Title:           Environmental Compliance Officer

Department:              Assets and Infrastructure                               File No: EM/13/05

Attachments:

1       ViewDraft Roadside Weed and Rabbit Control Plan 2013/2015

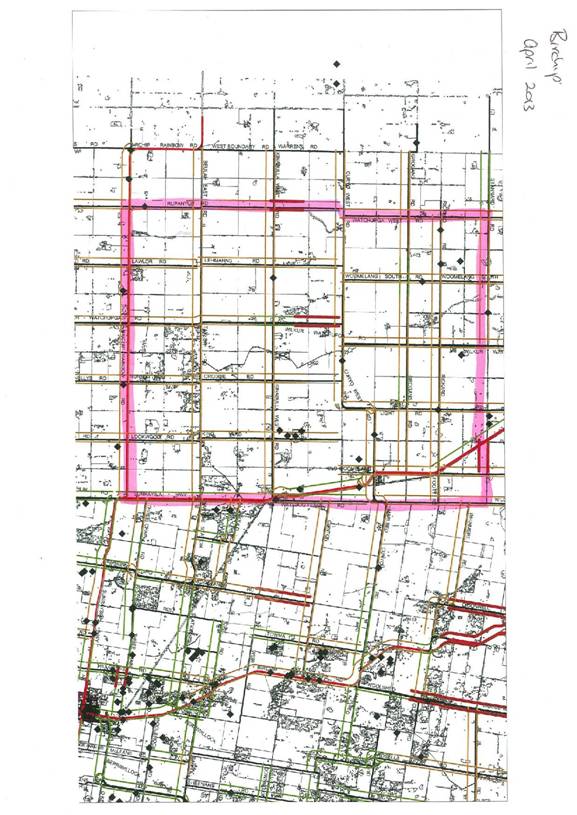

2       ViewBirchip Map

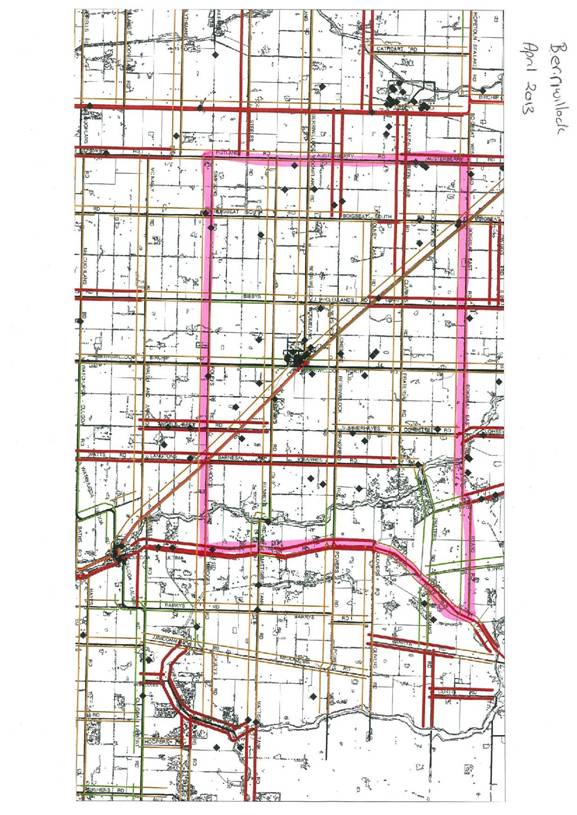

3       ViewBerriwillock Map

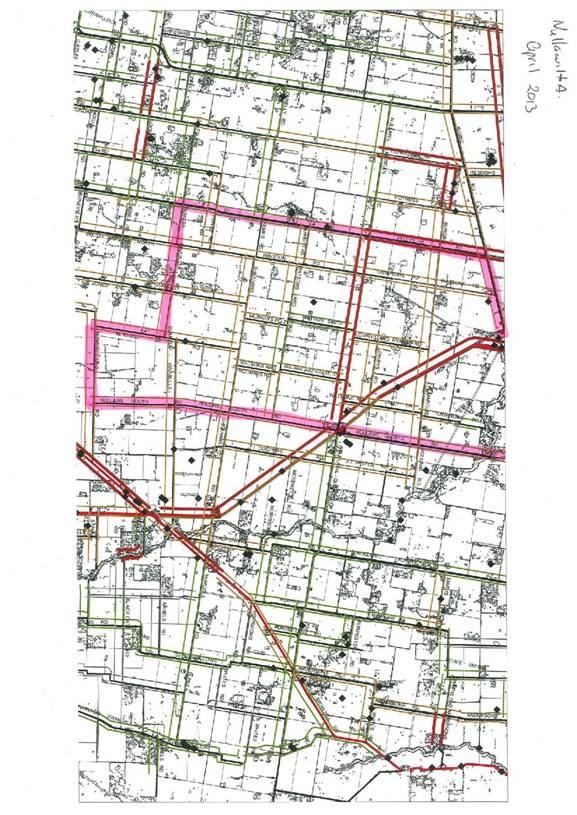

4       ViewNullawill Map

5       ViewCulgoa Map

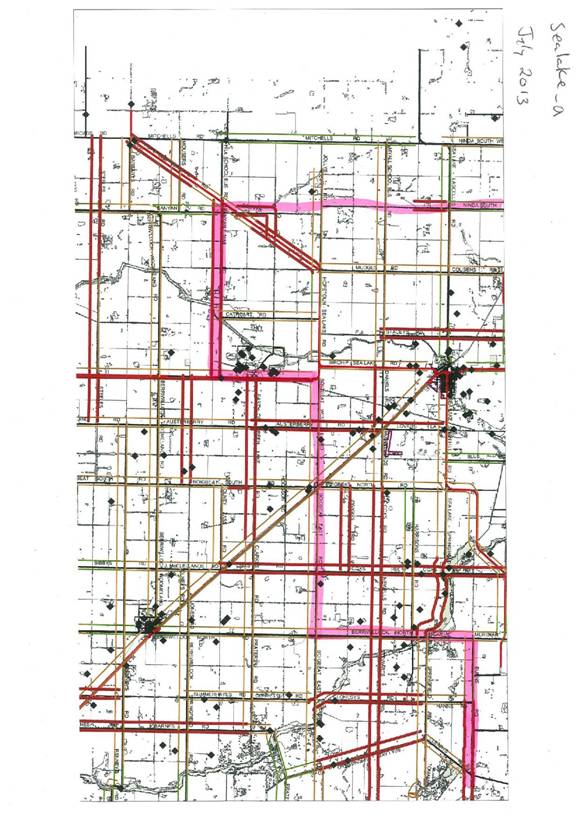

6       ViewSea Lake Map

7       ViewMt Buckrabanyule Map Wheel Cactus

Relevance to Council Plan 2009-13

Objective:                                 A Shire that is working with the community to reduce our carbon footprint, protect and enhance the natural environment and share experiences and information.

Strategy:                                   Protecting our natural assets through short and long-term planning and environmental programs.

Priority:                                     Use the Municipal Strategic Statement to manage development and protect the natural character of Buloke.

RECOMMENDATION

That:

1.       Council, having consulted with the community and local Landcare Networks and Groups  adopt the Roadside Weed and Rabbit Plan without modification.

1.       Executive Summary

Buloke Shire Council’s overall roadside weed and rabbit management objective is the effective and proactive management of invasive species on Council managed roadsides across the Shire.

The Roadside weed and rabbit plan contributes to Buloke Shire’s ongoing roadside weed and rabbit management program and complements past investments made by Buloke Shire which was enabled through State Government initiative funding.

The Plan will assist with the preventing the spread and introduction of invasive plant and animal species across the Shire and the region as a whole.

Following consultation with local Landcare groups the Plan is recommended for final adoption.

2.       Discussion

In April 2013, the draft Roadside Weed and Rabbit Control Plan was advertised in the three local paper which circulate within the Shire; The Buloke Times, Sea Lake/ Wycheproof Times Ensign and North Central News.

The Plan was also placed on the Buloke Shire’s website for comment.

Copies of the draft Plan were also sent by email to the following Landcare coordinators within the Shire, who distributed the Plan to all their Landcare members.

·        Kevin Spence - Buloke and Northern Grampians Landcare Network.

·        Jessica Cook – South Eastern Mallee Region

·        Kim Cross – Eastern Mallee Region.

Email copies of the Plan were also sent to;

·        Jeffcott Landcare group

·        Wycheproof Landcare group

·        Berriwillock Landcare group

·        Birchip Landcare group

·        Culgoa Landcare group

·        Nullawil Landcare group

·        Charlton Landcare group

The following responses were received:

1.  Kevin Spence- BNG Landcare Network

·   Mapping and sharing this information on a common database that can be reviewed and updated as required

·   Trying to ensure that the plan starts to look at setting up more formal and regular contact between all stakeholders, including managers of private and public land, so we can get an integrated and coordinated approach. To me this will be one of the best lasting legacies and help ensure scarce resources are best utilised

·   Including agricultural assets in prioritisation considerations.

2.  Janet Richardson – Wychitella District Landcare Group.

·   “I wish to draw attention to the continuing problem of the pest plant Opuntia robusta [wheel cactus] on the roadsides in the Buloke Shire. As this plant is now a Weed of National Significance I trust its control will be a key part of the Shire’s plan.”

3.  Kim Cross and Jessica Cook, through phone discussion said that their Landcare groups are happy with the Plan as they are already undertaking rabbit control works in their areas and that they are happy that the Shire is taking a collaborative approach to pest and weed management.

3.       Financial Implications

The funding agreement was signed in November 2012 and $50,000 has been received

Council will use 10% for project management cost and the remainder $40,000 will be used for on ground works that are defined within community project areas supporting Landcare groups and DPI compliance.

$50,000 to be received in July 2013 – 10% project management cost

$50,000 to be received in July 2014 – 10% project management cost

4.       Community Consultation

Kevin Spence - Buloke and Northern Grampians Landcare Network.

Jessica Cook – South Eastern Mallee Region

Kim Cross – Eastern Mallee Region.

Emails were also sent out to;

Jeffcott Landcare group

Wycheproof Landcare group

Berriwillock Landcare group

Birchip Landcare group

Culgoa Landcare group

Nullawil Landcare group

Charlton Landcare group

5.       Internal Consultation

No internal consultation/discussions.

6.       Legislative / Policy Implications

State

·     Invasive Plants and Animal Policy Framework

·     Catchment and Land Protection Act 1994

·     Flora and Fauna Guarantee Act 1988

·     Crown Land (Reserves) Act 1978

·     Land Act 1958

·     Local Government Act 1989

·     Planning and Environment Act 1987

·     Environment Protection Act 1970.

·     Road Management Act 2004

Regional

·     North Central CMA Invasive Plants & Animal Strategy 2010-15

·     Mallee CMA Invasive Plants & Animals Management Strategy.

Local

·     Buloke Shire Council’s Environment Strategy

·     Buloke Shire Council’s  Weed Identification

·     Buloke Shire Council’s Roadside Management Plan

7.       Environmental Sustainability

The Buloke Shire Council seeks to work with local communities in protecting high value environmental assets from pest plant and animal impacts. The southern regions of the shire contain Buloke Woodland Communities that are recognised as a regional and national high priority asset. The northern region of the shire joins Lake Tyrrell, a wetland of National Significance that plays an important ecological/hydrological role in the natural functioning of a major wetland system.

8.       Conflict of Interest Considerations

No known conflicts

9.       Conclusion

Buloke Shire Council’s overall roadside weed and rabbit management objective is the effective and proactive management of invasive species on Council managed roadsides across the Shire. The Roadside weed and rabbit plan contributes to Buloke Shire’s ongoing roadside weed and rabbit management program and complements past investments made by Buloke Shire which was enabled through State Government initiative funding. The Plan will assist with the preventing the spread and introduction of invasive plant and animal species across the Shire and the region as a whole.

Buloke Shire Council Ordinary Meeting Addendum Agenda                      Wednesday, 8 May 2013

7.2.12               Roadside Weed and Rabbit Control Plan 2013/2015

Attachment 1    Draft Roadside Weed and Rabbit Control Plan 2013/2015

Buloke Shire Council Ordinary Meeting Addendum Agenda                      Wednesday, 8 May 2013

7.2.12               Roadside Weed and Rabbit Control Plan 2013/2015

Attachment 2    Birchip Map

Buloke Shire Council Ordinary Meeting Addendum Agenda                      Wednesday, 8 May 2013

7.2.12               Roadside Weed and Rabbit Control Plan 2013/2015

Attachment 3    Berriwillock Map

Buloke Shire Council Ordinary Meeting Addendum Agenda                      Wednesday, 8 May 2013

7.2.12               Roadside Weed and Rabbit Control Plan 2013/2015

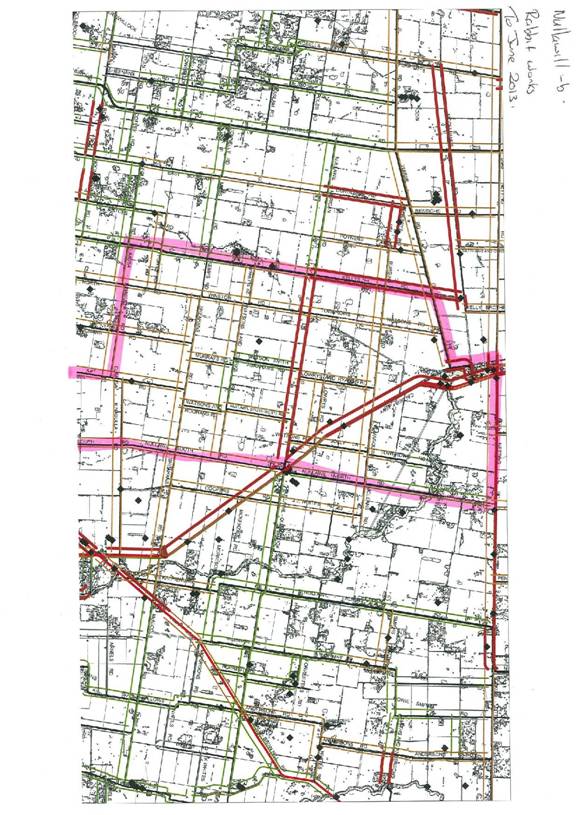

Attachment 4    Nullawill Map

Buloke Shire Council Ordinary Meeting Addendum Agenda                      Wednesday, 8 May 2013

7.2.12               Roadside Weed and Rabbit Control Plan 2013/2015

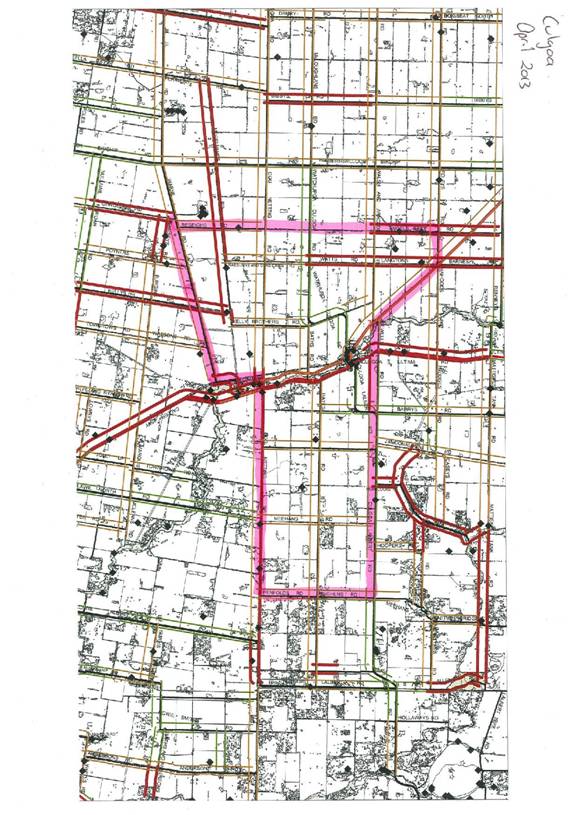

Attachment 5    Culgoa Map

Buloke Shire Council Ordinary Meeting Addendum Agenda                      Wednesday, 8 May 2013

7.2.12               Roadside Weed and Rabbit Control Plan 2013/2015

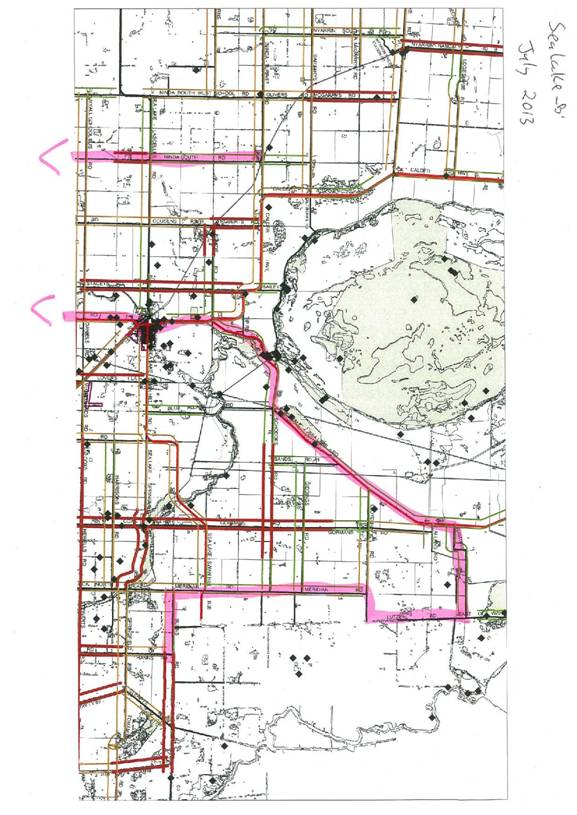

Attachment 6    Sea Lake Map

Buloke Shire Council Ordinary Meeting Addendum Agenda                      Wednesday, 8 May 2013

7.2.12               Roadside Weed and Rabbit Control Plan 2013/2015

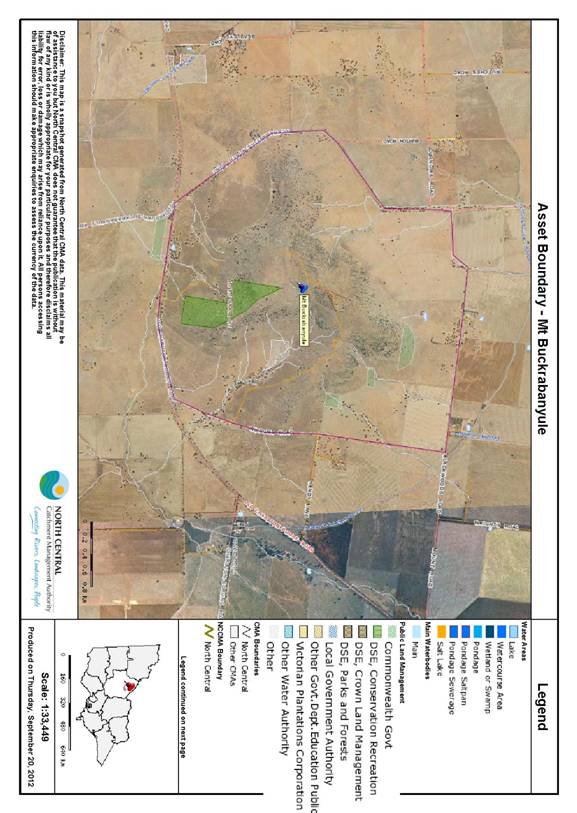

Attachment 7    Mt Buckrabanyule Map Wheel Cactus

Buloke Shire Council Ordinary Meeting Addendum Agenda                   Wednesday, 8 May 2013

7.2.13  Exercise of Lease Option - Automatic Weather Station, Charlton Landfill

Author’s Title:           Risk Officer

Department:              Office of the CEO                                            File No: WM/08/01

Attachments:

Nil

Relevance to Council Plan 2009-13

Objective:                                 A local economy in which the contribution of the agricultural sector and business sector is recognised and their continued growth actively encouraged and supported.

Strategy:                                   Promoting the high quality clean agricultural production capacity of the Shire to take advantage of new opportunities to maximise economic growth.

Priority:                                     Promote the capability of local producers to provide high quality grains, legumes, oil seeds and live meat to local, national and international markets and ensure Land Use policies in the Buloke Planning Scheme protect the future of these economic assets.

RECOMMENDATION

That:

1.       Council write to DTZ Real Estate Services (Vic) Pty Ltd, who represents the Commonwealth Bureau of Meteorology, confirming that Council have received notice of and agrees to the Bureau of Meteorology formally exercising the option to renew for a further 10 year period, from 16 July 2013 to 15 July 2023.

2.       Council gives Public Notice of its intention to continue the lease with the Commonwealth of Australia, represented by the Bureau of Meteorology, pursuant to the exercise of the option to renew.

3.       That the Public Notice disclose the following:

(a)               References to Section 190 (restriction on power to lease land) and Section 223 (right to make a submission);

(b)               The location of the property, including Certificate of Title details;

(c)               The use of the Land

(d)               The rent to be paid pursuant to the current Lease terms;

(e)               The independent annual market rental valuation received for the land;

(f)               The reason the current Lease is below the independent market rental valuation is because:

i.                                  This was arrangement agreed to in the original lease negotiations and was the amount set in that agreement;

ii.                                  The Automatic Weather Station installed on the site is necessary in order to obtain data necessary for the Bureau of Meteorology’s functions under the Meteorology Act 1955 (Commonwealth);

iii.                                 The Bureau of Meteorology is established as a national meteorological agency to perform its functions under the Meteorology Act 1955 (Commonwealth) in the public interest; and

iv.                                The site produces data relevant to agricultural data users, and is of value to primary producers in the Shire.

(g)               The commencement and end of the submission period;

(h)               How submissions can be made;

(i)                That persons making a submission is entitled to request that they be heard in support of their submission and are entitled to appear in person; and

(j)                Contact details for a Council representative if further information is required.

4.       The date by which submissions are to be submitted, for the purposes of Section 223 of the Local Government Act 1989 (Cth) be 30 days from the date of the placement of the necessary advertisements.

5.       That the advertisements be placed in the local press, namely the North Central News, Sea Lake Wycheproof Times Ensign and the Buloke Times.

1.       Executive Summary

The Commonwealth of Australia, represented by the Bureau of Meteorology (BoM), has exercised an option of renewal for the continued lease of the Automatic Weather Station (“AWS”) at the Charlton Landfill (stack site), for a further 10 year period.

2.       Discussion

The AWS comprises electronic equipment and other facilities contained within an area of 30 metres by 30 metres (900m²) on the land more particularly described in Certificate of Title Volume Lot 2 PS337537A/Part CA 17 Sec 8, Charlton East. The permitted use of the site is the installation, maintenance and usage of the AWS in order to obtain data necessary for the BOM’s functions under the Meteorology Act 1955 (Commonwealth).

The BOM has a current Lease with Council for a term of 10 years, terminable by the Tenant on 12 month’s notice from the date of signing the lease, together with one option for renewal for a further term of 10 years exercisable in writing by the Tenant not less than three months before the expiry of the term. The Bureau of Meteorology has formally proposed to exercise that option for a further term of 10 years, for the period 16 July 2013 to 15 July 2023 and which is at the current annual rental of $10 per annum. All outgoings, services, maintenance and other charges are payable by the Tenant.

An Independent Valuation for the land as at 17 April 2013 assessed the annual market rental at $500.00 per annum (excluding GST).

This AWS site was established as part of the Bureau of Meteorology’s Agrometeorology program and produces data relevant to agricultural data users. An AWS sends data frequently and is designed to provide data for the Bureau’s forecasting, warning and information services, as well as providing data for the Bureau’s climate database. One of the advantages of an AWS is that they can be installed in sparsely populated areas and it is designed to provide data in all weather, day and night, 365 days per year.

3.       Financial Implications

An amount of $10.00 per annum rental is payable by the Bureau of Meteorology to Council.

4.       Community Consultation

Public notices for the proposed exercise of the option for renewal will be placed in the local newspapers including details of the Lessee, amount of rental to be paid for the land and the intended use.

5.       Internal Consultation

None applicable.

6.       Legislative / Policy Implications

Council is required to comply with the requirements of Sections 190 and 223 of the Local Government Act 1989 (Victoria) and Local Government Best Practice Guidelines for the Sale, Exchange and Transfer of Land (Ministerial Guidelines endorsed June 2009).

7.       Environmental Sustainability

The agricultural sector will be affected by climate change policy. Assisting the Bureau of Meteorology to take and record meteorological observations and transmit meteorological reports and information assists in providing accurate information to inform the development of sustainable and alternative farming practices, which in turn affects productivity and economic growth.

8.       Conflict of Interest Considerations

There are no known conflicts of interest.

9.       Conclusion

The farming sector is the principal source of employment opportunity in the Shire, aided by the economic growth from the Shire’s comparative advantages in grain production and agriculture. Therefore, it is considered that accurate and timely local meteorological data is of significant importance to the local community. The AWS is one means of providing the data necessary to fulfil the Bureau of Meteorology’s functions. Weather data, such as that provided by the AWS, can be used to predict high-risk weather conditions which impacts agricultural productivity growth.

7.3.      Financial Reports

7.3.1    Finance Report as at 30 April 2013

Author’s Title:           Manager Finance

Department:              Finance                                                             File No: Rep102013

Attachments:

1       ViewIncome Statement

2       ViewBalance Sheet

3       ViewCapital Budget

Relevance to Council Plan 2009-13

Objective:                                 An organisation that is responsibly governed with a strong emphasis on astute financial and risk management.

Strategy:                                   Ensuring Council is well governed and its finances and risks are managed responsibly.

Priority:                                     Review and renew the long-term financial plan for Council’s financial sustainability.

RECOMMENDATION

That:

1.       The Council receive the Monthly Financial Report which includes the Income statement, Balance sheet and Cash flow.

2.       The Council receive the year to date Capital Expenditure Report and note the progress made in meeting the Capital Budget targets.

3.       The Council note the variances outlined in the reports provided and note the comments explaining the reasons for these variances.

1.       Executive Summary

This report is prepared in line with the current Council meeting timetable and provides Council with an update on the financial situation of Council as at the end of April 2013.

Comments on variances are based on the revised budget 2012/13 as adopted by Council.

Capital Budget

Capital Budget Classification

Annual Revised Budget

YTD Actual

Variance

Total Non flood Works

7,657,898

3,176,313

4,481.585

Flood Works

12,316,100

1,596,007

10,720,093

Total Budget 2012/13

19,973,998

4,772,320

15,201,678

Capital Budget Progress by Job status

Annual Revised Budget

YTD Actual

Variance

SUMMARY

Completed

1,826,103

1,895,743

(69,640)

Works Completed

1,989,051

598,910

(1,390,141)

Expect Completion

2,238,994

340,141

(1,898,853)

Deferred

75,000

8,837

(66,163)

Rebudgeted

1,528,750

332,681

(1,196,069)

Total Non-Flood Works

7,657,898

3,176,313

4,481,585

Flood Works

12,316,100

1,596,007

10,720,093

Total Budget 2012/13

19,973,998

4,772,320

15,201,678

“Works Completed means works completed and paid for.”

“Works Completed means practical completion but not fully paid as at report date.”

“Expect completion means projected expected to be completed in current Financial year."

“Deferred means project deferred to a later year or abandoned."

" Rebudgeted means that all or part of project rebudgeted for next financial year."

The previous tables above represent a summary of the current status of capital works. The first table represents the progress made on “Flood” and “Non-Flood Related” capital works.

The second table shows the status of jobs and the practical completion status as well as likelihood of completion within the remainder of the year.

Income Statement

Original Budget

Adopted Revised  Budget

Variance

Reforecast Result to End of Year

Variance Forecast to Revised Budget

Variance Forecast to Original Budget

SUMMARY

000’s

000’s

000’s

000’s

Net Surplus / ( Deficit) from Operations)

(4,746)

 (4,410)

336

(4,044)

           366

702

Net Surplus/( Deficit) from Operations excluding Depreciation

1,691

2,027

336

2,469

442

778

The income statement shows that council still anticipates to meet the revised budget end of year target and based on current forecasts should improve on the result.

2.       Discussion

Capital Budget

Capital works of $1.36 Million have been completed in the past month. The Capital Budget report has been extended to provide information as to the likelihood of projects being completed within the current financial year.

The detailed capital report shows that all reseal works have all been completed and that rehabilitation works have been completed on McLoughlan’s Road and Massey Bangerang Road.

It is still expected that the remainder of flood related funding for major flood related road works will be received prior to the end of the year. These funds will be invested and used to fund the ongoing flood repair works program in the 2013/14 financial year.

The report shows that most of the capital projects programmed for 2012/13 are expected to be completed except for major flood road works which will proceed through into the following year.

Projects scheduled for commencement and/or completion in 2012/13 that have been delayed or deferred and are therefore unlikely to be undertaken in the current year are clearly identified..

Income Statement

The year to date operating result is a net deficit of $2.26M after flood related grants have been removed from the operating result.

Management continues to be conscious aware that the Auditor General’s report on the 2011/12 Annual Financial Statements stated that there was uncertainty as to the Shire’s ability to continue as a going concern. Every effort is being made to improve operating results and demonstrate that this situation can be reversed.

The adopted revised budget projected a $4.4M operating deficit for the year. Council is currently $2.1M below this figure. Current projections are for an operating deficit of $4.044M at 30 June 2013.

The adopted revised budget reduced the projected end of year deficit from the original 2012/13 Budget by a projected $0.337M. As a result of further review of income and expenditure there is anticipated to be a positive variance of $0.702M as 30 June 2013 in comparison to the original budget figure.

It is anticipated that $1.0M is expected to be received as an advance payment for the Donald Community Services Centre and this figure is included in current projections.

Expenditure forecast for the total year is forecast to be $23.457M. This is marginally over the original revised budget figure of $23.417M.

It is anticipated that surplus plant items will be sold prior to the end of the year and should realise a net contribution of $0.047M.

Cash Position

The current cash position shows Council with a balance of $3.76 million in cash reserves. This is expected to meet the cash requirements for the next month as claims are made for the substantial flood related road works that are currently being performed.

3.       Financial Implications

The financial implications relating to the information contained in this report are outlined within the body of the report.

4.       Community Consultation

No Consultation with the community was required in the production of this report.

5.       Internal Consultation

Consultation with the various operational managers was undertaken to source information relating to any significant variances.

6.       Legislative / Policy Implications

This report is prepared to meet the Legislative requirements related to reporting Council’s financial situation to council.

7.       Environmental Sustainability

There are no environmental impacts as a result of the preparation of this report.

8.       Conflict of Interest Considerations

There are no matters or recommendations in this report that constitute a conflict of interest.

9.       Conclusion

The reporting requirements to report the financial situation of Council as at the end of the previous month and year to date to the end of that period have been met.

Buloke Shire Council Ordinary Meeting Addendum Agenda                                                                Wednesday, 8 May 2013

7.3.1                 Finance Report as at 30 April 2013

Attachment 1    Income Statement

Buloke Shire Council Income Statement to 30 April 2013

Financial Statement

Original

Budget

Annual Current Budget

Apr YTD Actuals

May MTH Forecast

Jun MTH Forecast

Total Actual

Reforecast

Reforecast Variance Remainder of Yr April

105 - Rates and Charges

9,941

9,940

9,865

0

0

9,865

(75)

110 - Statutory Fees and Fines

62

122

104

4

4

112

(10)

115 - User Fees

790

845

577

85

56

718

(127)

120 - Capital Grants

3,962

3,962

3,590

723

1,116

5,429

1,467

125 - Operating Grants

3,050

3,170

2,373

0

0

2,373

(797)

130 - Contributions - Cash

249

286

243

0

120

363

77

145 - Gain on Disposal of Assets

200

200

(27)

47

0

20

(180)

150 - Share of Profit / Loss in Assoc.

10

10

0

0

10

10

0

155 - Other Income

187

263

340

8

30

378

115

160 - Interest Income

490

209

119

11

15

145

(64)

Total Income

18,941

19,007

17,184

878

1,351

19,413

406

205 - Employee Benefits

10,303

9,770

8,352

794

1,102

10,248

478

210 - Materials and Services

6,326

6,214

4,921

430

461

5,812

(402)

215 - Bad and Doubtful debts

20

12

0

5

0

5

(7)

220 - Depreciation and Amortisation

6,437

6,437

5,433

540

540

6,513

76

225 - Finance Costs

57

50

19

0

0

19

(31)

230 - Other Expenses

544

934

721

55

84

860

(74)

Total Expenses

23,687

23,417

19,446

1,824

2,187

23,457

40

Net Surplus (Deficit)

(4,746)

(4,410)

(2,262)

(946)

(836)

(4,044)

366

Capital Flood Grants

35,140

35,140

4,500

0

30,640

35,140

0

Total

30,394

30,731

2,239

(946)

29,805

31,097

365

Buloke Shire Council Ordinary Meeting Addendum Agenda                           Wednesday, 8 May 2013

7.3.1                 Finance Report as at 30 April 2013

Attachment 2    Balance Sheet

Buloke Shire Council Ordinary Meeting Addendum Agenda                                                                Wednesday, 8 May 2013

7.3.1                 Finance Report as at 30 April 2013

Attachment 3    Capital Budget

Buloke Shire Council - Capital Budget Review April 2013.

Capital Areas / Flood and Non Flood Related

Annual Revised Budget

YTD Actual

Variance

Total Non flood Works

7,657,898

3,176,313

4,481,585

Flood Works

12,316,100

1,596,007

10,720,093

Total Budget 2012/13

19,973,998

4,772,320

15,201,678

Capital Budget Progress by Job status

Annual Revised Budget

YTD Actual

Variance

SUMMARY

Completed

1,826,103

1,895,743

(69,640)

Works Completed

1,989,051

598,910

(1,390,141)

Expect Completion

2,238,994

340,141

(1,898,853)

Deferred

75,000

8,837

(66,163)

Rebudgeted

1,528,750

332,681

(1,196,069)

Total Non-Flood Works

7,657,898

3,176,313

4,481,585

Flood Works

12,316,100

1,596,007

10,720,093

Total Budget 2012/13

19,973,998

4,772,320

15,201,678

`

Note  " Works Completed means practical completion but not fully paid as at report date.

" Expect completion means projected expected to be completed in current Financial year." " Deferred means project deferred to a later year or abandoned."

" Rebudgeted means that all or part of project rebudgeted for next financial year."

Project Description

Annual Current Budget

YTD Actuals

YTD Variance

Forecast Comments

Job Status

7800.EF0008 - Works In Progress : Mobile Display Cabinets Golden Grains Museum

0

8,000

8,000

Grant fund expenditure

Completed

7800.BB0010 - Works In Progress : Donald Hall Paint Exterior Entrance

10,000

5,369

-4,631

Completed

Completed

7800.BB0012 - Works In Progress : Wycheproof Hall Paint Internally

10,000

18,690

8,690

Completed

Completed

7800.BB0013 - Works In Progress : Wycheproof Bowls Club Replace Roof

18,500

17,186

-1,314

Completed

Completed

7800.BB0022 - Works In Progress : Sea Lake Community Complex Upgrade Kitchen

200,000

174,866

-25,134

Completed

Completed

7800.BB0026 - Works In Progress : Birchip Leisure Centre Extension MH4385

15,173

5,020

-10,153

completed

completed

7800.BB0027 - Works In Progress : Wycheproof Hall Solar Panels - MH4309

8,255

8,255

0

Completed

Completed

7800.EF0003 - Works In Progress : Donald Senior Citizens  Air Conditioning

20,000

16,091

-3,910

Completed

Completed

7800.EI0001 - Works In Progress : Councillor Printers

2,000

2,515

515

Completed

Completed

7800.EI0002 - Works In Progress : Desktop Replacement

46,000

37,875

-8,125

Completed

Completed

7800.EI0003 - Works In Progress : Laptop Replacement

22,500

19,448

-3,052

Completed

Completed

7800.EI0004 - Works In Progress : Councillor Computers

17,500

22,862

5,362

Completed

Completed

7800.EI0005 - Works In Progress : Server Replacement (WESX02)

15,300

16,100

800

Completed

Completed

7800.EI0006 - Works In Progress : Main Network Switch Replacement (Cisco SGE2010P)

4,150

4,150

0

Completed

Completed

7800.EI0007 - Works In Progress : Telephones and Hands Free Kits

6,000

5,689

-311

Completed

Completed

Buloke Shire Council Ordinary Meeting                                                                                              Wednesday, 8 May 2013

7.3.1                 Finance Report as at 30 April 2013

Attachment 3    Capital Budget

Project Description

Annual Current Budget

YTD Actuals

YTD Variance

Forecast Comments

Job Status

7800.EI0008 - Works In Progress : Backup Server Replacement

11,700

11,700

0

Completed

Completed

7800.EI0009 - Works In Progress : Councillor Telephones

4,200

5,148

948

Completed

Completed

7800.EI0013 - Works In Progress : Depot UPS Upgrade with SNMP

3,900

2,540

-1,360

Completed

Completed

7800.EI0014 - Works In Progress : Wyche & Birchip Server UPS Replacement

4,800

4,800

0

Completed

Completed

7800.EI0015 - Works In Progress : Mail and Web Marshall Licences Additional

3,250

2,182

-1,068

Completed

Completed

7800.EI0017 - Works In Progress : Exchange 2010 Server Upgrade

23,500

23,180

-320

Completed

Completed

7800.EI0018 - Works In Progress : Windows 2007 Upgrade

17,000

16,650

-350

Completed

Completed

7800.EI0020 - Works In Progress : Install Firebox XTM 510, Live Security & W G Pro

4,150

3,670

-480

Completed

Completed

7800.EI0022 - Works In Progress : Implement Stage 2 of Wireless program

140,000

159,376

19,376

Completed

Completed

7800.EI0023 - Works In Progress : Facilities Booking Software

0

3,970

3,970

Completed

Completed

7800.EI0024 - Works In Progress : Mapinfo Stratus Web-based GIS Solution Software

13,000

26,577

13,577

Product installed, minor

refinement work still underway before launch

Completed

7800.EI0025 - Works In Progress : Council Info System

23,210

30,286

7,076

Completed

Completed

7800.EI0026 - Works In Progress : Autonomous Access Points x 2

0

2,810

2,810

Completed

Completed

7800.EI0027 - Works In Progress : Xpedite M & CH Software

0

9,033

9,033

Installation completed.

Final invoice ($3,041) to be paid in May 2013

Completed

7800.EI0028 - Works In Progress : Service Connection Councillors

0

7,227

7,227

Project completed-

Improved connection for

Councillors

Completed

7800.EP0003 - Works In Progress : Small Plant

30,000

18,612

-11,388

On Budget- current review

of small plant underway

Completed

7800.EP0008 - Works In Progress : Microphones for Wyche Supper Room

0

2,996

2,996

Completed

Completed

7800.IL0002 - Works In Progress : Landfill Sites New Cells

25,000

25,932

932

Completed

Completed

7800.IO0012 - Works In Progress : Pools All Service Pool Pumps incl. Solar Pumps

4,000

725

-3,275

Completed

Completed

7800.IO0014 - Works In Progress : Birchip Replace Pool Pump

7,500

8,022

522

Completed

Completed

7800.IO0015 - Works In Progress : Birchip Pool Replace ladders

4,800

5,279

479

Completed

Completed

7800.IO0016 - Works In Progress : Charlton Pool Leak Reduction Works Stage 1

40,000

13,175

-26,825

Completed

Completed

7800.IO0017 - Works In Progress : Pools Charlton,Wyche & Birchip Foot Valves

8,000

4,255

-3,745

Completed

Completed

7800.IO0018 - Works In Progress : Charlton Pool Plant Pipe Work, including Filters

40,000

32,089

-7,911

Completed

Completed

7800.IO0019 - Works In Progress : Pools Donald and Charlton Disinfectant Upgrade

70,000

46,240

-23,760

Completed

Completed

7800.IO0021 - Works In Progress : Watchem Pool Replace Ladders

4,800

3,292

-1,508

Completed

Completed

7800.IO0022 - Works In Progress : Wycheproof Toddler Pool Drainage Line & Impr Circu

1,500

300

-1,200

Completed

Completed

7800.IO0024 - Works In Progress : Birchip Pool Leak Reduction Works Stage 1

50,000

32,677

-17,323

Completed

Completed

7800.IO0025 - Works In Progress : Pools All Replace Flow Switches

8,000

5,870

-2,130

Completed

Completed

7800.IO0033 - Works In Progress : Birchip Pool Plant Pipe Work

20,000

20,897

897

Completed

Completed

7800.IO0035 - Works In Progress : Wycheproof Netball Courts Upgrade : MH4396

0

7,564

7,564

Completed

Completed

7800.IO0036 - Works In Progress : Donald Pool Replace Sand Filter

0

32,545

32,545

Completed

Completed

7800.IR0004 - Works In Progress : Resheet Jeruk River Rd (end of seal) Rebudget

22,663

20,831

-1,832

Completed

Completed

7800.IR0005 - Works In Progress : Resheet River Rd (end of seal to start of seal)

26,090

24,733

-1,357

Completed

Completed

7800.IR0006 - Works In Progress : Resheet Galaquil Rd (Surface chg to Rapunyap Rd)

35,000

31,984

-3,016

Completed

Completed

7800.IR0007 - Works In Progress : Resheet Brennans Rd (Downes Rd to Ryand Rd)

42,107

24,182

-17,925

Completed

Completed

7800.IR0008 - Works In Progress : Resheet Ingrams Rd (Culgoa Ultima to Curtis Rds)

156,650

167,069

10,419

Completed

Completed

7800.IR0009 - Works In Progress : Resheet Richards Rd (Langs Rd to Scrubbery Lane)

0

16,857

16,857

Completed

Completed

Buloke Shire Council Ordinary Meeting                                                                                              Wednesday, 8 May 2013

7.3.1                 Finance Report as at 30 April 2013

Attachment 3    Capital Budget

Project Description

Annual Current Budget

YTD Actuals

YTD Variance

Forecast Comments

Job Status

7800.IR6001 - Works In Progress : Dumosa Birchip Road (Seal&Segment) (3257 12925)

291,630

284,577

-7,053

Completed

Completed

7800.IR7001 - Works In Progress : Reseal Wycheproof Calder Hwy S/R (0410m)

48,275

0

-48,275

Completed

Completed

7800.IR9004 - Works In Progress : Rehab - Watchupga Culgoa Road

176,000

188,209

12,209

Completed

Completed

7800.MA1101 - Works In Progress : District Offices - O H & S Essentials

0

41

41

Completed

Completed

7800.MH4286 - Works In Progress : Wyche Mens Shed-Toilet Upgrade

0

90

90

Completed

Completed

7800.MH4309 - Works In Progress : Wycheproof Hall Solar Panels

0

-5,000

-5,000

Completed

Completed

7800.MH4395 - Works In Progress : Donald Blueroom-Fire

0

7,250

7,250

Completed

Completed

7800.MH4396 - Works In Progress : Wycheproof Netball Courts Upgrade

0

4,463

4,463

Completed

Completed

7800.ML6606 - Works In Progress : Shoulder Resheets-Dumosa Birchip Rd (Dumosa Birchi

0

22,094

22,094

Completed

Completed

7800.MX0501 - Works In Progress : Flood Repairs-Redevelopment of Charlton Office

0

3,638

3,638

Completed

Completed

7800.MX0512 - Works In Progress : Flood Repairs-Charlton Netball/Hockey Rooms

0

9,945

9,945

Completed

Completed

7800.MX0513 - Works In Progress : Flood Repairs-Charlton Netball Courts

105,000

163,066

58,066

Completed

Flood Works

7800.MX0537 - Works In Progress : Flood Repairs - Charlton Driver Education Centre

0

49,258

49,258

Completed

Completed

7800.BB0015 - Works In Progress : Depot Sea Lake Upgrade staff amenities

60,000

102,503

42,503

Completed

Completed

7800.BB0016 - Works In Progress : Depots OH&S Essentials

10,000

11,282

1,282

Completed

Completed

7800.IF0004 - Works In Progress : Footpaths Donald Willow Court, (100m)

16,500

12,276

-4,224

Works completed.

Outstanding Invoices

Works Completed

7800.IK0009 - Works In Progress : Kerb & Ch-Best St (Railway Ave Horace St) ML8033

57,500

27,750

-29,750

Variance was expended to

ML 8033- Awaiting final invoice

Works Completed

7800.EI0029 - Works In Progress : BIS Long Term Planning Software

0

9,000

9,000

First Stage Completed

Second stage projected in

May

Works Completed

7800.IR7002 - Works In Progress : Reseal Wycheproof Camp Street (370m492m)

8,889

1,096

-7,793

Works Completed

Works Completed

7800.IR7003 - Works In Progress : Reseal Charles Street (255m  396m)

3,797

1,235

-2,562

Works Completed

Works Completed

7800.IR7004 - Works In Progress : Reseal Corack Road Birchip (0240m)

16,041

0

-16,041

Works Completed

Works Completed

7800.IR7005 - Works In Progress : Reseal Corack Road Birchip (240m  328m)

1,766

0

-1,766

Works Completed

Works Completed

7800.IR7006 - Works In Progress : Reseal Crescent Road (0466m)

12,302

0

-12,302

Works Completed

Works Completed

7800.IR7007 - Works In Progress : Reseal Cumming Avenue SBCW (0170m)

3,411

0

-3,411

Works Completed

Works Completed

7800.IR7008 - Works In Progress : Reseal Grenfell St (0101m)

3,075

0

-3,075

Works Completed

Works Completed

7800.IR7009 - Works In Progress : Reseal Hoban St (298m  373)

2,416

0

-2,416

Works Completed

Works Completed

7800.IR7010 - Works In Progress : Reseal Hoban St South (231m  261m)

1,014

0

-1,014

Works Completed

Works Completed

7800.IR7011 - Works In Progress : Reseal Industrial Dr (315m  913m)

12,159

0

-12,159

Works Completed

Works Completed

7800.IR7012 - Works In Progress : Reseal Industrial Estate Road (0177m)

10,280

0

-10,280

Works Completed

Works Completed

7800.IR7013 - Works In Progress : Reseal Industrial Estate Courts (0168m)

15,612

0

-15,612

Works Completed

Works Completed

7800.IR7014 - Works In Progress : Reseal Jil Jil Rd (1500m 2480)

29,494

2,707

-26,787

Works Completed

Works Completed

7800.IR7015 - Works In Progress : Reseal Jil Jil Road (01500m)

32,947

0

-32,947

Works Completed

Works Completed

7800.IR7016 - Works In Progress : Reseal Main St, West side Culgoa (0203m)

5,359

0

-5,359

Works Completed

Works Completed

7800.IR7017 - Works In Progress : Reseal Marbled Curyo Rd (1075m 2180m)

29,172

0

-29,172

Works Completed

Works Completed

7800.IR7018 - Works In Progress : Reseal Massey Banegrang Rd (2540m 3720m)

31,152

0

-31,152

Works Completed

Works Completed

7800.IR7019 - Works In Progress : Reseal McKenzie St (0293m)

11,273

0

-11,273

Works Completed

Works Completed

7800.IR7020 - Works In Progress : Reseal Mildura Way (514m  639m)

1,074

0

-1,074

Works Completed

Works Completed

7800.IR7021 - Works In Progress : Reseal Morrison St (690m  832m)

4,316

0

-4,316

Works Completed

Works Completed

7800.IR7022 - Works In Progress : Reseal Morrison St (112m  222m)

5,808

961

-4,847

Works Completed

Works Completed

7800.IR7023 - Works In Progress : Reseal Queen St (0111m)

2,247

3,240

993

Works Completed

Works Completed

7800.IR7024 - Works In Progress : Reseal Simpson Street (0100m)

2,742

721

-2,021

Works Completed

Works Completed

Buloke Shire Council Ordinary Meeting                                                                                              Wednesday, 8 May 2013

7.3.1                 Finance Report as at 30 April 2013

Attachment 3    Capital Budget

Project Description

Annual Current Budget

YTD Actuals

YTD Variance

Forecast Comments

Job Status

7800.IR7025 - Works In Progress : Reseal Stahl Street (0114m)

5,598

240

-5,358

Works Completed

Works Completed

7800.IR7026 - Works In Progress : Reseal Sutcliff Street (1037m 1144m)

3,010

0

-3,010

Works Completed

Works Completed

7800.IR7027 - Works In Progress : Reseal Todd Rd (2330m 2408m)

6,178

0

-6,178

Works Completed

Works Completed

7800.IR7028 - Works In Progress : Reseal Watchupga Culgoa Road (7290m 10140m)

75,240

0

-75,240

Works Completed

Works Completed

7800.IR7029 - Works In Progress : Reseal Watchupga Culgoa Road (34165m 34900m)

19,404

0

-19,404

Works Completed

Works Completed

7800.IR7030 - Works In Progress : Reseal Willangie Woomelang Rd (1860m)

68,746

0

-68,746

Works Completed

Works Completed

7800.IR7031 - Works In Progress : Reseal Willangie Woomelang Rd (1860 3230m)

41,232

2,524

-38,708

Works Completed

Works Completed

7800.IR7032 - Works In Progress : Reseal Willangie Woomelang Rd (4300m 5240m)

18,852

2,386

-16,466

Works Completed

Works Completed

7800.IR7033 - Works In Progress : Reseal Wilkur Watchupga Road (11165m 12045m)

22,190

1,082

-21,108

Works Completed

Works Completed

7800.IR7034 - Works In Progress : Reseal Wilkur Watchupga Rd (9530m 10550m)

26,928

0

-26,928

Works Completed

Works Completed

7800.IR7035 - Works In Progress : Reseal Industrial Estate Courts (168m  300m)

27,878

0

-27,878

Works Completed

Works Completed

7800.IR7036 - Works In Progress : Reseal Clifton St Turn Slot Birchip (0111m)

5,635

1,492

-4,143

Works Completed

Works Completed

7800.IR7037 - Works In Progress : Reseal Willangie Woomelang Road (3230m 4300m)

62,711

2,883

-59,828

Works Completed

Works Completed

7800.IR7038 - Works In Progress : Reseal Hoban Street (016m)

313

0

-313

Works Completed

Works Completed

7800.IR7039 - Works In Progress : Reseal Clifton St Turn Slot Birchip (111m  223m)

3,089

0

-3,089

Works Completed

Works Completed

7800.IR7040 - Works In Progress : Reseal Wilkur Watchupga Road (20850m 22220m)

37,615

1,082

-36,533

Works Completed

Works Completed

7800.IR7041 - Works In Progress : Reseal Sutcliff Street (692m  921m)

4,836

2,043

-2,793

Works Completed

Works Completed

7800.IR7042 - Works In Progress : Reseal Seven Mile Rd Charlton

90,000

672

-89,328

Works Completed

Works Completed

7800.IR9001 - Works In Progress : Rehab McLoughlan Road (2295 4320)

410,500

27,301

-383,199

Works Completed

Works Completed

7800.IR9002 - Works In Progress : Rehab Massey Bangerang Road (4920 6610)

500,250

478,854

-21,396

Works Completed

Works Completed

7800.IR9003 - Works In Progress : Rehab McLoughlan Road (1025)

226,500

17,545

-208,955

Works Completed

Works Completed

7800.BB0003 - Works In Progress : Charlton Kindergarten Office

12,000

1,820

-10,180

Works Completed

Works Completed

7800.BB0005 - Works In Progress : Charlton Bowls Club Replace Roof

21,000

316

-20,684

Project contract awarded-

to commence in April

Expect Completion

7800.BB0006 - Works In Progress : Charlton Golden Grains Museum Replace Roof

19,000

243

-18,757

Committee have received

external funding for the roof- no Council contribution required.

Expect Completion

7800.BB0007 - Works In Progress : Charlton Hall Paint Internally

10,000

5,886

-4,114

Works commenced

Expect Completion

7800.BB0011 - Works In Progress : Wycheproof Recreation Reserve Kitchen Upgrade

90,000

8,543

-81,457

Awaiting quotations,

project to commence in

April

Expect Completion

7800.BB0014 - Works In Progress : Wycheproof Court House Paint Externally

8,000

0

-8,000

Project to commence in

May

Expect Completion

7800.EP0006 - Works In Progress : Pools Charlton,Wychep & Birchip Pools Lane Ropes

4,000

0

-4,000

Project yet to commence

Expect Completion

7800.IF0005 - Works In Progress : Footpaths Birchip Cumming Avenue, (160m)

53,000

0

-53,000

Works Commenced

Expect Completion

7800.IO0007 - Works In Progress : Watchem Pool Install Sprinkler System

1,200

0

-1,200

Project yet to commence

Expect Completion

7800.IO0010 - Works In Progress : Saleyards Seal Lane Ways (Stage Two)

25,000

7,702

-17,298

Works Commenced

Expect Completion

7800.IO0013 - Works In Progress : Berriwillock Relocation Fencing at Toddler Pool

1,500

0

-1,500

Project yet to commence

Expect Completion

7800.IO0020 - Works In Progress : Sea Lake Pool Liner and Hydraulic Upgrade

300,000

15,999

-284,001

Contract let - works

progressing

Expect Completion

7800.IO0028 - Works In Progress : Wycheproof Centennial ParShade Structures

47,000

3,050

-43,950

Project scope to be

reviewed in conjunction with overall structural condition of building.

Expect Completion

Buloke Shire Council Ordinary Meeting                                                                                              Wednesday, 8 May 2013

7.3.1                 Finance Report as at 30 April 2013

Attachment 3    Capital Budget

Project Description

Annual Current Budget

YTD Actuals

YTD Variance

Forecast Comments

Job Status

7800.IO0029 - Works In Progress : Landfill Charlton New Fencing

20,000

0

-20,000

Quotes received, Roberts

Contracting to commence in April 2013

Expect Completion

7800.IO0030 - Works In Progress : Donald Aerodrome Power supply Rebudget

85,000

3,894

-81,106

Contract let - works to

occur June - August

Expect Completion

7800.IO0031 - Works In Progress : Saleyards Upgrade of Loading Ramps (Stage Two)

50,000

14,801

-35,199

Works ongoing- contractor

Addlem Engineering

Expect Completion

7800.MX0514 - Works In Progress : Flood Repairs-Charlton Harness Club Bldgs

100,000

1,243

-98,757

Contract let- works to

begin in April

Expect Completion

7800.BB0001 - Works In Progress : Nullawil Community Centre Kitchen Upgrade

70,000

5,661

-64,339

Awaiting funding

application

Expect Completion

7800.BB0018 - Works In Progress : District Offices OH&S essentials

10,000

15,577

5,577

Additional funding to be

spent in May

Expect Completion

7800.EP0001 - Works In Progress : Fleet Replacement

150,000

54,446

-95,554

Additonal Funds to be

spent in April/ May

Expect Completion

7800.EP0002 - Works In Progress : Major Plant

450,000

2,495

-447,506

Tenders called for

Jetmaster- to be let in

April/ May

Expect Completion

7800.ID0002 - Works In Progress : Drainage Charlton Menzies Street Upgrade

62,500

0

-62,500

Materials order placed,

Works to commence in late April

Expect Completion

7800.IF0001 - Works In Progress : Footpaths Wycheproof Broadway East, (101m)

35,550

16,466

-19,084

Works Commenced

Expect Completion

7800.EI0012 - Works In Progress : Software Upgrade - Huefner CSS

10,000

8,360

-1,640

Project almost finalised

one invoice still outstanding

Expect Completion

7800.EI0019 - Works In Progress : Upgrade Software, Inter&Intranet & Train Staff

30,000

17,617

-12,383

Website complete. Intranet

development to proceeding

Expect Completion

7800.EP0004 - Works In Progress : Landfill Charlton & Donald Recyclable Skips

50,000

0

-50,000

Quotes received

Expect completion

7800.EP0005 - Works In Progress : Garbage Bins - New

15,000

5,027

-9,973

Remainder of bins to be

ordered in May 2013

Expect completion

7800.EP0007 - Works In Progress : Saleyards Truck Wash New Pumps

12,000

0

-12,000

Quote on works sought

Expect completion

7800.BB0025 - Works In Progress : Saleyards Office - Install storeroom

10,000

2,050

-7,950

Project commenced- to be

completed in June

Expect Completion

7800.EF0001 - Works In Progress : Birchip Hall Air Conditioner and Power Upgrade

25,000

1,022

-23,978

Quotations called for-

works to begin in May

Expect Completion

7800.IO0026 - Works In Progress : Saleyards Landscaping Tree Replacement (Stage2)

2,500

0

-2,500

Expenditure in May 2013

Expect Completion

7800.IK0003 - Works In Progress : Kerb & Ch Watchem Hoban Street, (188m)

22,560

0

-22,560

Works to commence 15th

April 2013

Expect Completion

7800.IK0004 - Works In Progress : Kerb & Ch Birchip Johnson Street, (192m)

23,100

0

-23,100

Works to commence in

May 2013

Expect Completion

7800.IK0006 - Works In Progress : Kerb & Ch Birchip Simpson Street, (70m)

8,400

0

-8,400

Works to commence in

May 2013

Expect Completion

7800.IK0007 - Works In Progress : Kerb & Ch Birchip Sherwood St (ex. ML8034)

15,459

15,459

0

Works to commence in

May 2013

Expect Completion

7800.IK0008 - Works In Progress : Kerb & Ch-Best St (Gregson Gallagher Sts) ML8032

20,125

20,125

0

Works to commence in

May 2013

Expect Completion

Buloke Shire Council Ordinary Meeting                                                                                              Wednesday, 8 May 2013

7.3.1                 Finance Report as at 30 April 2013

Attachment 3    Capital Budget

Project Description

Annual Current Budget

YTD Actuals

YTD Variance

Forecast Comments

Job Status

7800.IL0001 - Works In Progress : Landfill Restoration/Rehabilitation

55,000

22,113

-32,887

Works Commenced

Expect Completion

7800.IO0001 - Works In Progress : Township Signs Upgrade

35,200

7,925

-27,275

Project proceeding- will be

completed by June

Expect Completion

7800.IO0002 - Works In Progress : Landfill Sites Upgrade Signs

10,000

3,035

-6,965

Further funding to be spent

in June

Expect Completion

7800.IO0003 - Works In Progress : Sea Lake Upgrade Transfer Ramp

10,000

755

-9,245

Project to be completed in

May

Expect Completion

7800.IO0004 - Works In Progress : Playground Replacement All Shire

35,000

3,213

-31,787

Project to be completed in

May

Expect Completion

7800.IO0006 - Works In Progress : Street Bin Surrounds

10,000

0

-10,000

Quotes sought, All to be

expended in April 2013

Expect Completion

7800.IR0001 - Works In Progress : Resh`t RichardsRd(Scrubberty SunH`way 2825 4525)

50,000

0

-50,000

Project to be completed in

June 2013

Expect Completion

7800.IR0002 - Works In Progress : Resheet Charlton Swan Hill Rd Rebudget

156,650

68,144

-88,506

Project commenced- to be

completed May

Expect Completion

7800.IR0003 - Works In Progress : Resheet Marmal North Rd (3.54 Camp Rd to segment)

20,250

8,975

-11,275

Project commenced- to be

completed May

Expect Completion

7800.BB0021 - Works In Progress : Berriwillock Community Centre

800,000

299,555

-500,445

Works progressing

Rebudgeted

7800.IO0037 - Works In Progress : Birchip Bowling Green Redevelopment

0

972

972

Rebudgeted

7800.MH4284 - Works In Progress : Sea Lake Pool Liner and Hydraulics Upgrade

0

5,090

5,090

Preliminary project costs-

grant funds received

Rebudgeted

7800.ID0001 - Works In Progress : Drainage Birchip SES Upgrade Rebudget

30,000

0

-30,000

Project yet to commence

Rebudgeted

7800.BB0020 - Works In Progress : Charlton Park Complex

120,000

5,250

-114,750

Project to be re-budgeted

in 2013/14 financial year following full cost analysis

Rebudgeted

7800.BB0023 - Works In Progress : Charlton Travellers Rest Office & Visit

220,000

15,887

-204,113

Project to be rebudgeted

Rebudgeted

7800.ID0003 - Works In Progress : Drainage Donald,Woods and Hamill St

47,250

0

-47,250

Project yet to commence

Rebudgeted

7800.ID0004 - Works In Progress : Drainage Rear Old Holden Dealer, Donald

31,500

0

-31,500

Project yet to commence

Rebudgeted

7800.ID0005 - Works In Progress : Charlton Park Connect to AWB Dam

80,000

0

-80,000

Project to be rebudgeted

Rebudgeted

7800.EI0010 - Works In Progress : Sea Lake Repeater Station Upgrade

0

306

306

Project cancelled

(Incorrect allocation of maintenance on two way radios)

Rebudgeted

7800.BB0024 - Works In Progress : Donald Family Services Centre

200,000

5,621

-194,379

Minor design changes

being finalised, project delayed awaiting confirmation of external funding.

Rebudgeted

7800.BB0017 - Works In Progress : District Offices Office Security Upgrade

25,000

3,135

-21,865

Quotes called for.

Deferred

7800.BB0019 - Works In Progress : Wycheproof Pound Upgrade to Regulations

0

891

891

Project being re-evaluated

Deferred

7800.EI0011 - Works In Progress : Two Way Radios

7,000

0

-7,000

Cancelled project

Deferred

7800.BB0009 - Works In Progress : Donald Archive Building New Roof

30,000

4,812

-25,188

Project to be deferred

pending a further condition report

Deferred

Buloke Shire Council Ordinary Meeting Addendum Agenda                    Wednesday, 8 May 2013

Project Description

Annual Current Budget

YTD Actuals

YTD Variance

Forecast Comments

Job Status

7800.IO0009 - Works In Progress : Birchip Stock Pound Semi Portable Yards

13,000

0

-13,000

Project unlikely to proceed-

alternative arrangements being investigated

Deferred

7800.MX1040 - Works In Progress : C6 and C12 Contract Overheads

430,483

347,632

-82,851

Project commenced

Flood Works

7800.MX1050 - Works In Progress : Contract O/Head - Consulting Engineering

0

4,960

4,960

Project commenced

Flood Works

7800.MX1080 - Works In Progress : C12 Contract Management

486,403

195,264

-291,139

Project commenced

Flood Works

7800.MX1210 - Works In Progress : CO6-2011/12 - Contract Payments

11,294,214

885,084

-10,409,130

Project commenced

Flood Works

Total

19,973,998

4,772,320

-15,201,678

L.          Report from the Mayor

L.1       Report from the Mayor

Author’s Title:           Mayor

File No: N/A

Attachments:

Nil

RECOMMENDATION

That the Council receive and note the Mayor’s Report as tabled.

Mayor’s Report

8 May 2013

The article in the Buloke Times following release of the Council’s March Financial Management Report once again raised the ‘spectre’ of Council being ‘broke’.  The words that attracted so much attention from the March report are used again in the April Financial Management Report tabled at the May Meeting.   They are the same words used in the Auditor General’s report on Council’s 2011/12 Annual Accounts and directly reflect the relative fragility of Council’s financial position.

As I indicated in a previous column on this topic, despite what some in the community might like to say, Council is not broke.   We can, and will, continue to pay our bills.   However, Councillors, Council Staff and the Community all need to be reminded of the tough financial reality that Council faces.

The ability of Council to provide the services the community expects, and to allocate resources to meet emerging needs, is entirely dictated by the revenue that Council can raise through rates, user charges and government grants.  It would not only be irresponsible, but also against the law, for Council to spend money it does not have.   It would also be irresponsible for Council to try to disguise just how tight its financial situation is, particularly when it is ratepayers money that Council is dealing with.

Council could choose to ‘put its head in the sand’ and ignore the situation it faces.   This may avoid some of the criticism that is thrown at us, but we believe it is better that we are honest about the situation, and that the community understands the challenges we face in making sure that we make decisions that improve our position, than make out everything is fine.   In the opinion of Councillors, such a stance would not be in the best interests of the Buloke community and certainly not in accord with the principles of Good Governance.

It is easy for people outside of Council to be critical of the work Council does and, to some extent, listening to such criticism goes with the job of Councillor.   However, the problem with these types of comments is that they are generally ill informed, and ignore the resources required to provide the services we deliver everyday and those required to meet the legislative compliance regimes that we are required to comply with.

Everyday resources are committed to maintaining roads, collecting waste and recyclables, clearing drains, cleaning toilets, operating swimming pools, maintaining parks,  enforcing local laws, providing pre-school service, helping new parents, supporting older persons, supporting young people, issuing building permits, etc.   All require the allocation of resources.   All require some form of management and control.   As indicated above, compliance is also a significant part of Council’s role.   For example, right at the current time Council is working to complete the following Plans mandated by legislation;

·    Council Plan (4 Year strategic plan)

·    Municipal Emergency Management Plan (audit and update)

·    Health and Well Being Plan

·    Domestic Animal Management Plan

·    Waste Water Management Plan

·    Municipal Strategic Statement (Review and alignment with other plans)

·    Strategic Resource Plan (10 Year Forward financial Plan)

·    Annual Budget 2013/14

·    Rating Strategy

·    Municipal Fire Management Plan (Review)

·    Road Management Plan

·    Review of all Council Policies (Must be completed within the first 12 months of the new Council)

·    Annual Report

·    Annual Financial Statements

Local Government is not a one-dimensional business.  It is not just a matter of collecting rates and spending it on whatever comes along.   Local Government is a complex business that requires Councillors to be constantly making decisions about how resources are to be best spent.   It is a constant balance between trying to meet ever changing community expectations, and the realities of managing the resources under our control.

Councillors sometimes need reminding that they are stewards elected to oversee the use of community resources.  We also acknowledge that from time to time we will make decisions that some in the community will question.   We do not draw back from such criticism.   In fact, we welcome constructive community input into the decision we make and the work that we do.   Despite the negative comments that it seems to attract, we will continue to ‘tell it how it is’ in terms of our financial position.    I, and all of my Councillor colleagues, am 100% committed to ensuring that at the end of our current four year term Buloke’s financial position is in better shape than it is now.   Council’s staff are committed to the same outcome, and that is why we are confident that we can achieve our objective.    That is our promise.

Cr Reid Mather

Mayor
